Olegivskiy residens logo
Share

Construction progress for August 2025

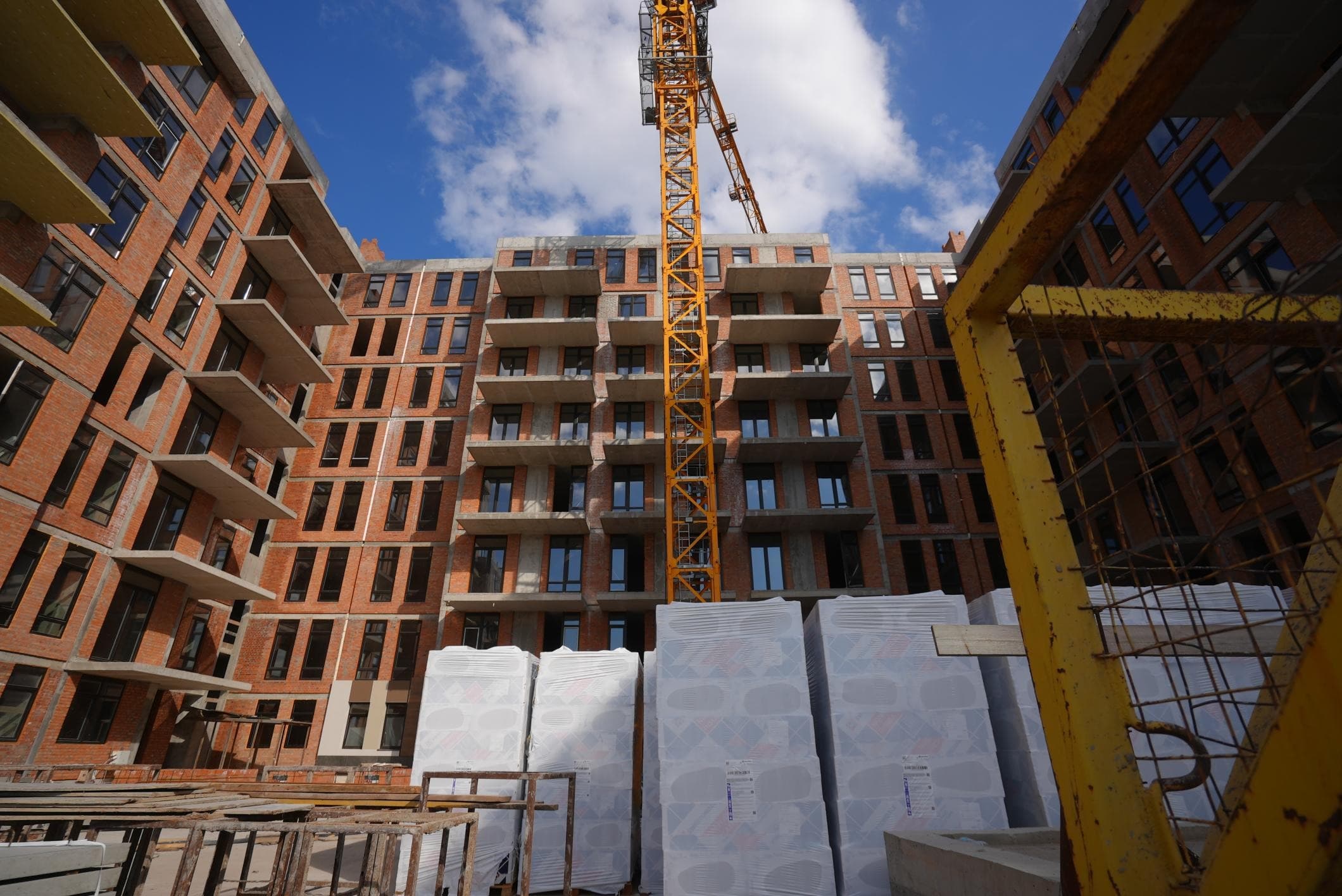

progress of construction

In August 2025, the following works were carried out at the construction site:

Section 1:

  • Laying of cement-sand screed from the 2nd to the 8th floor - 100%

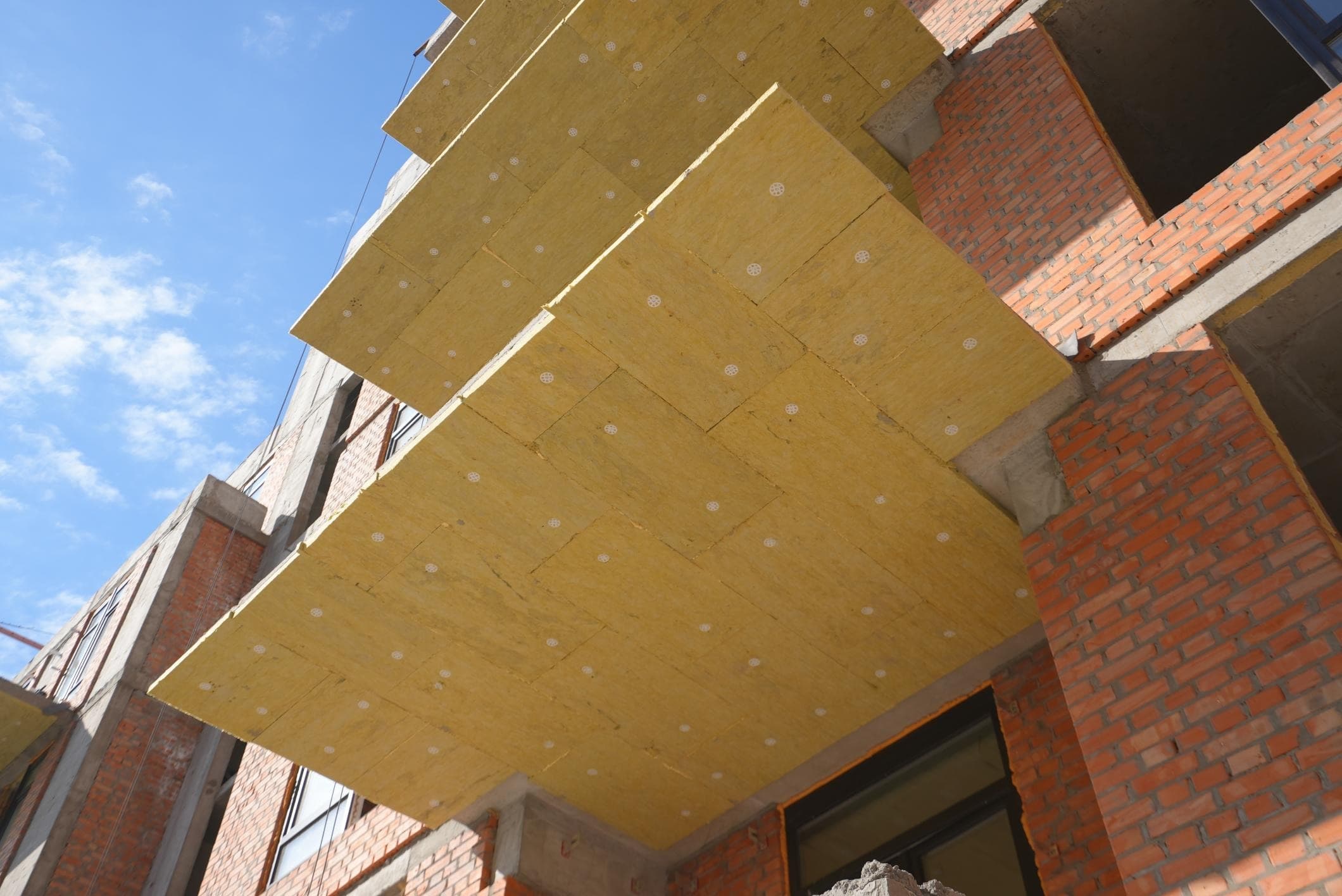

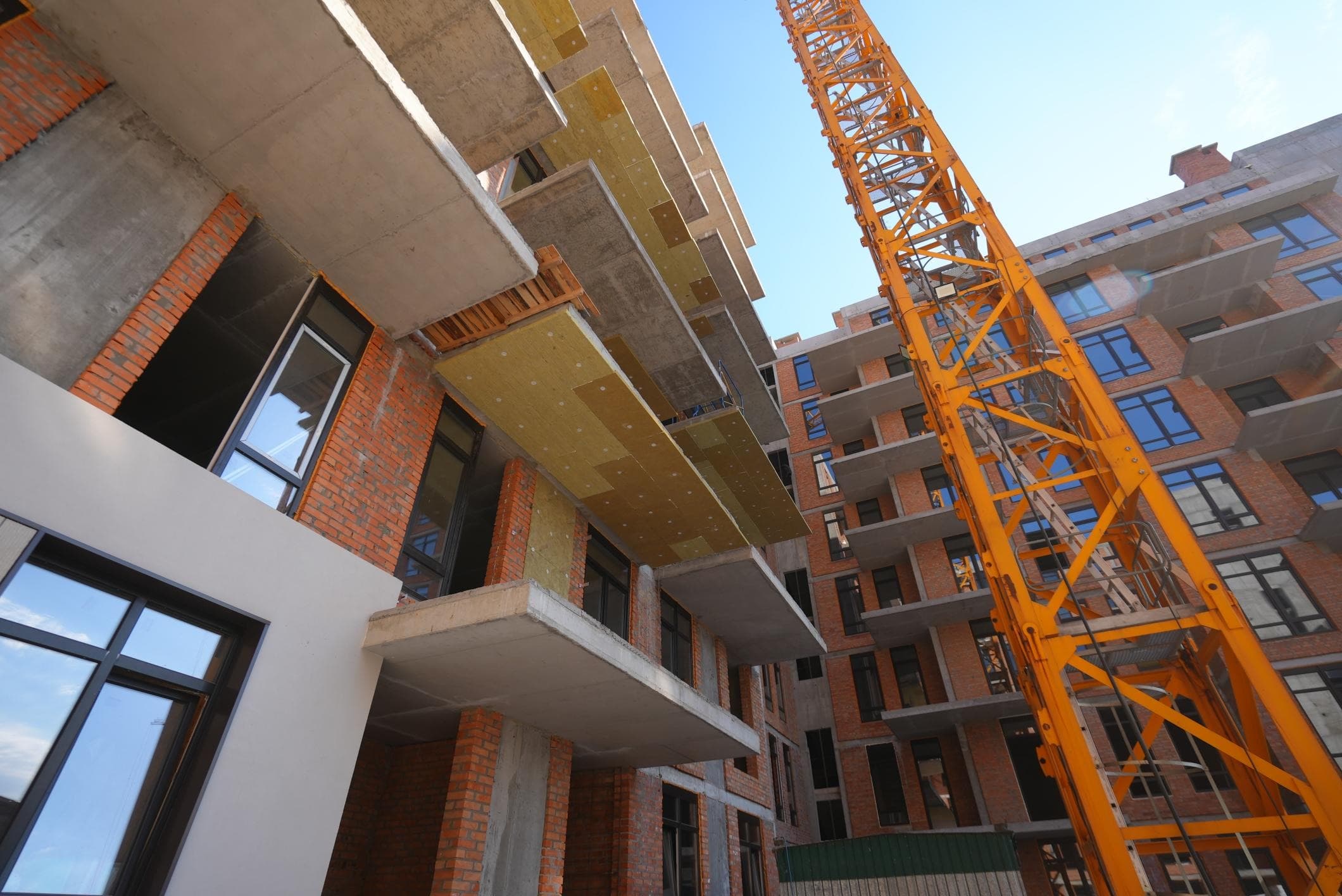

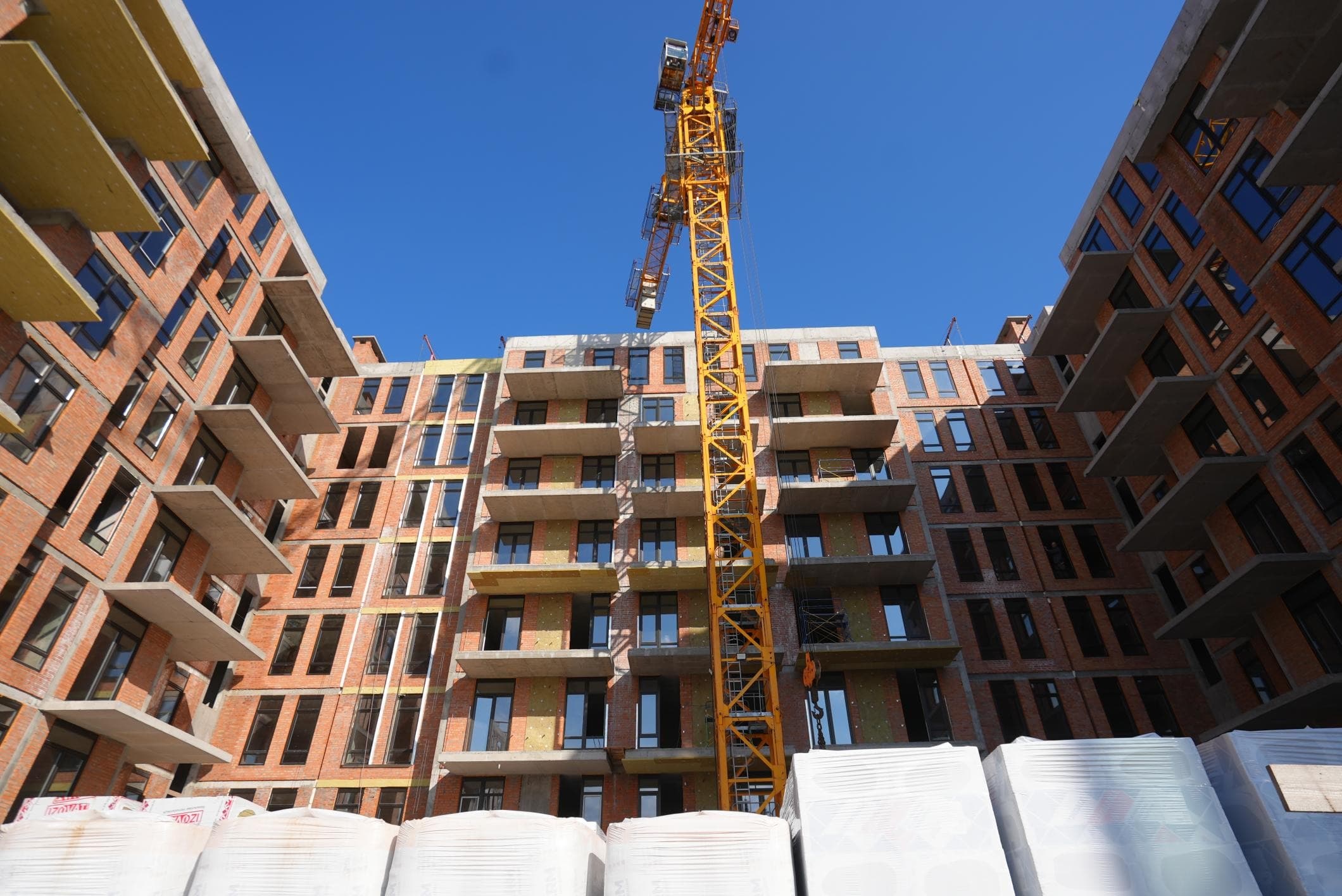

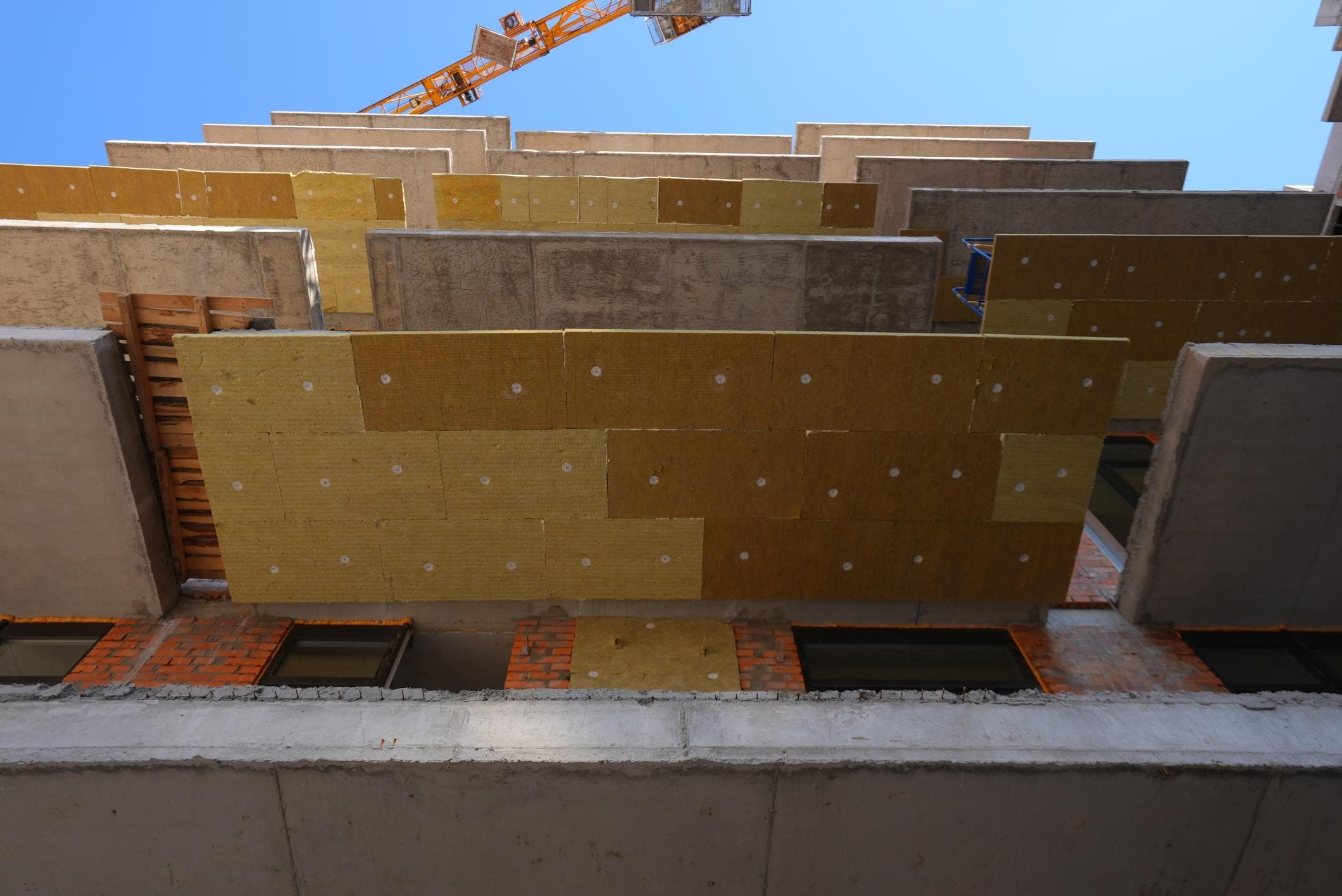

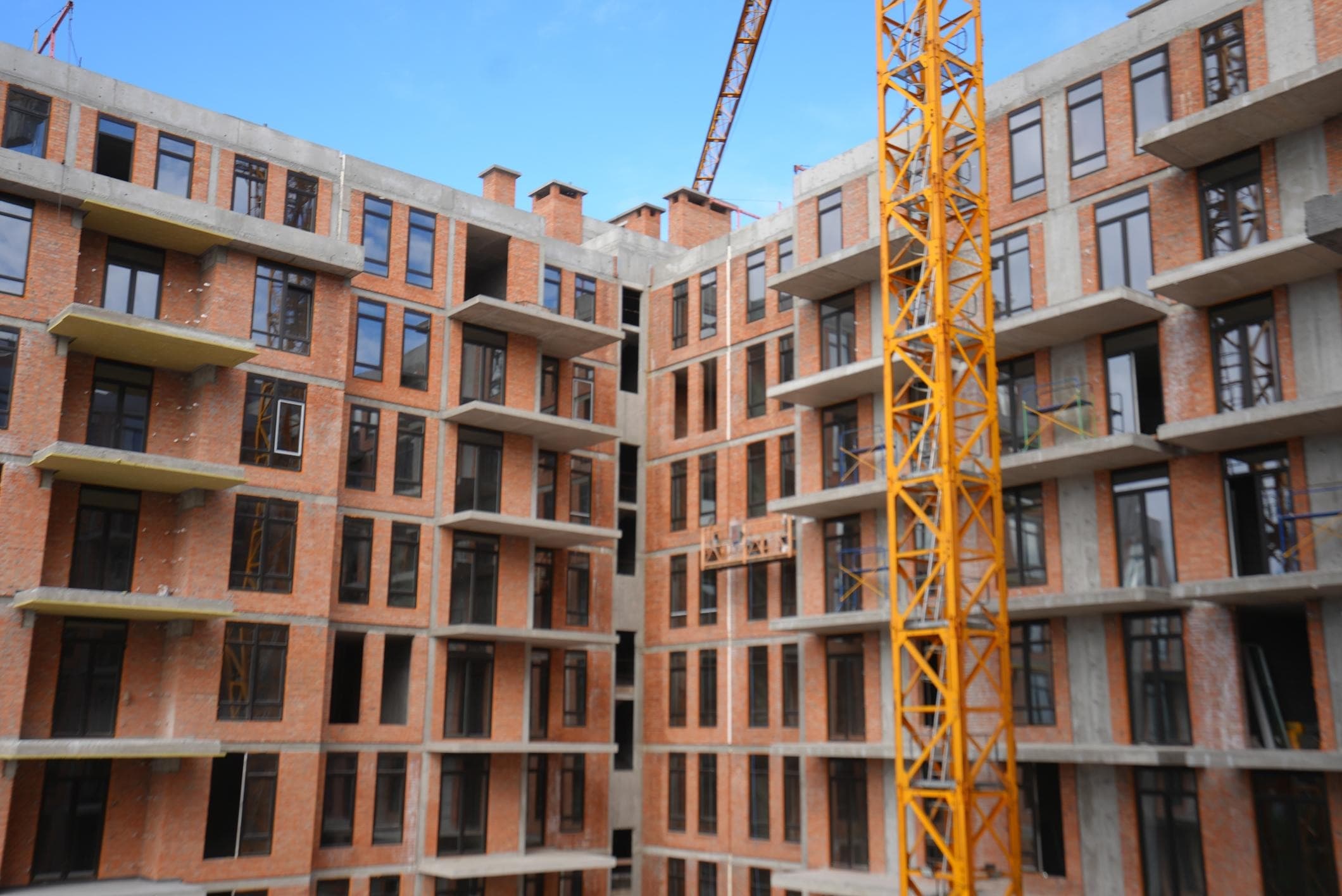

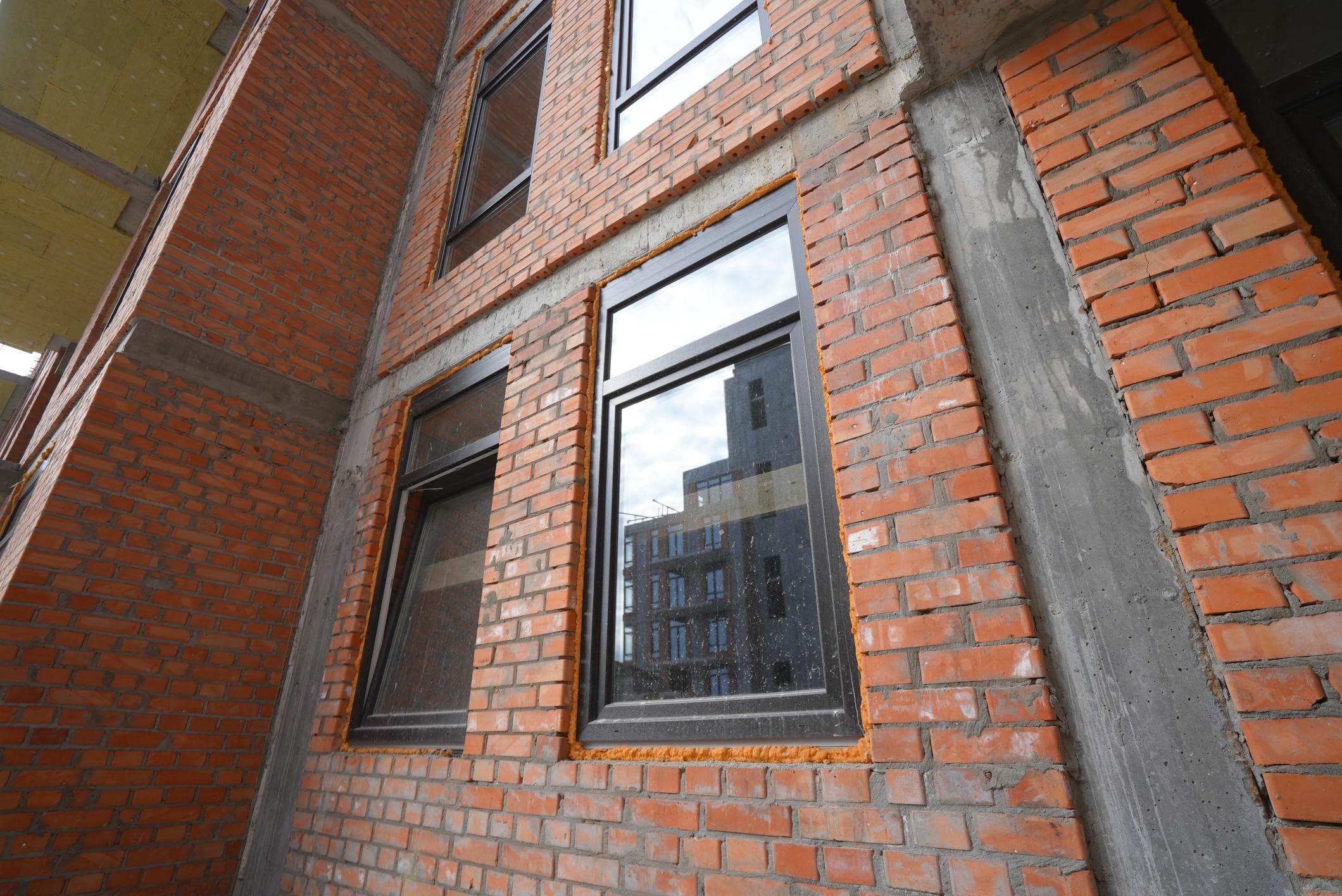

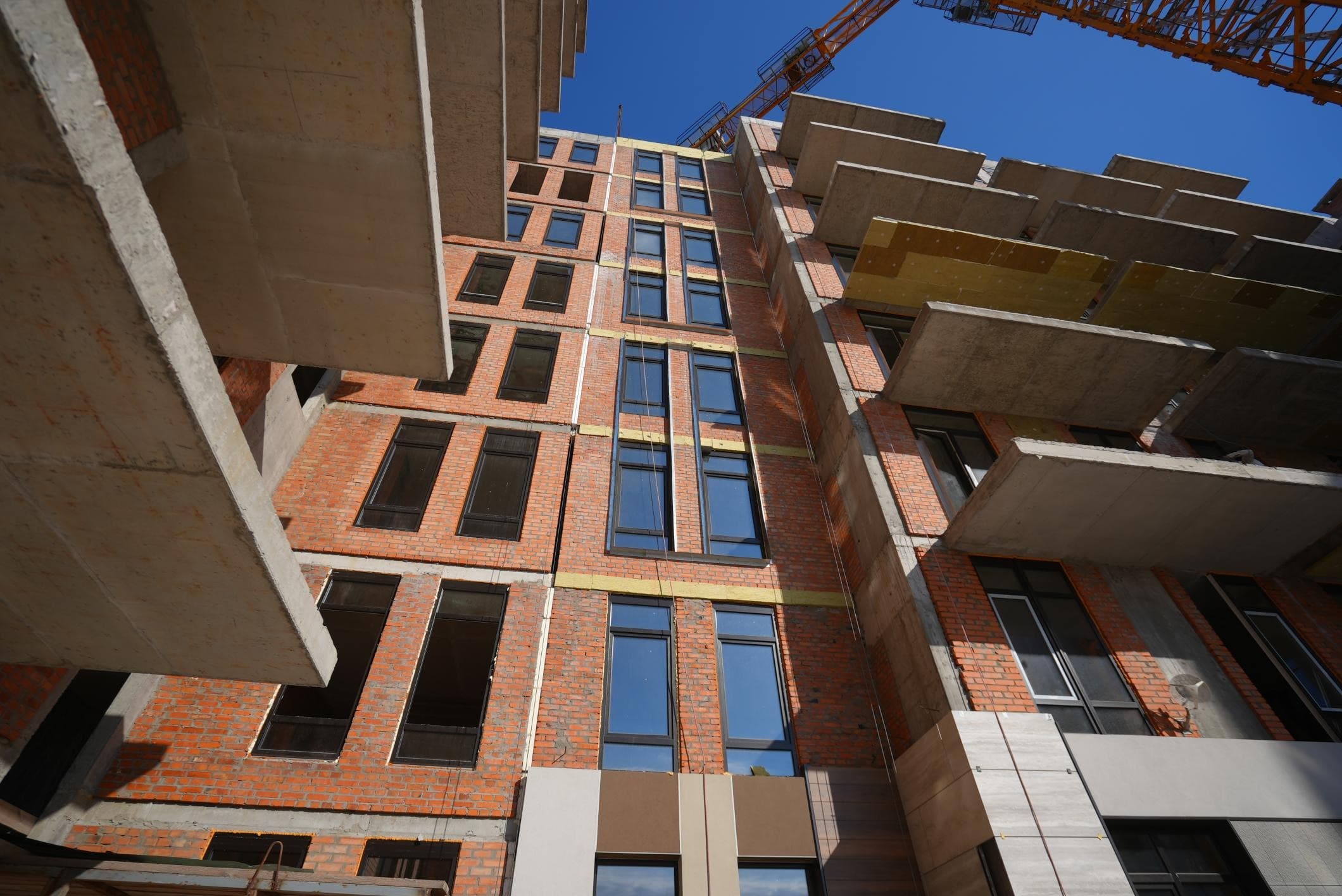

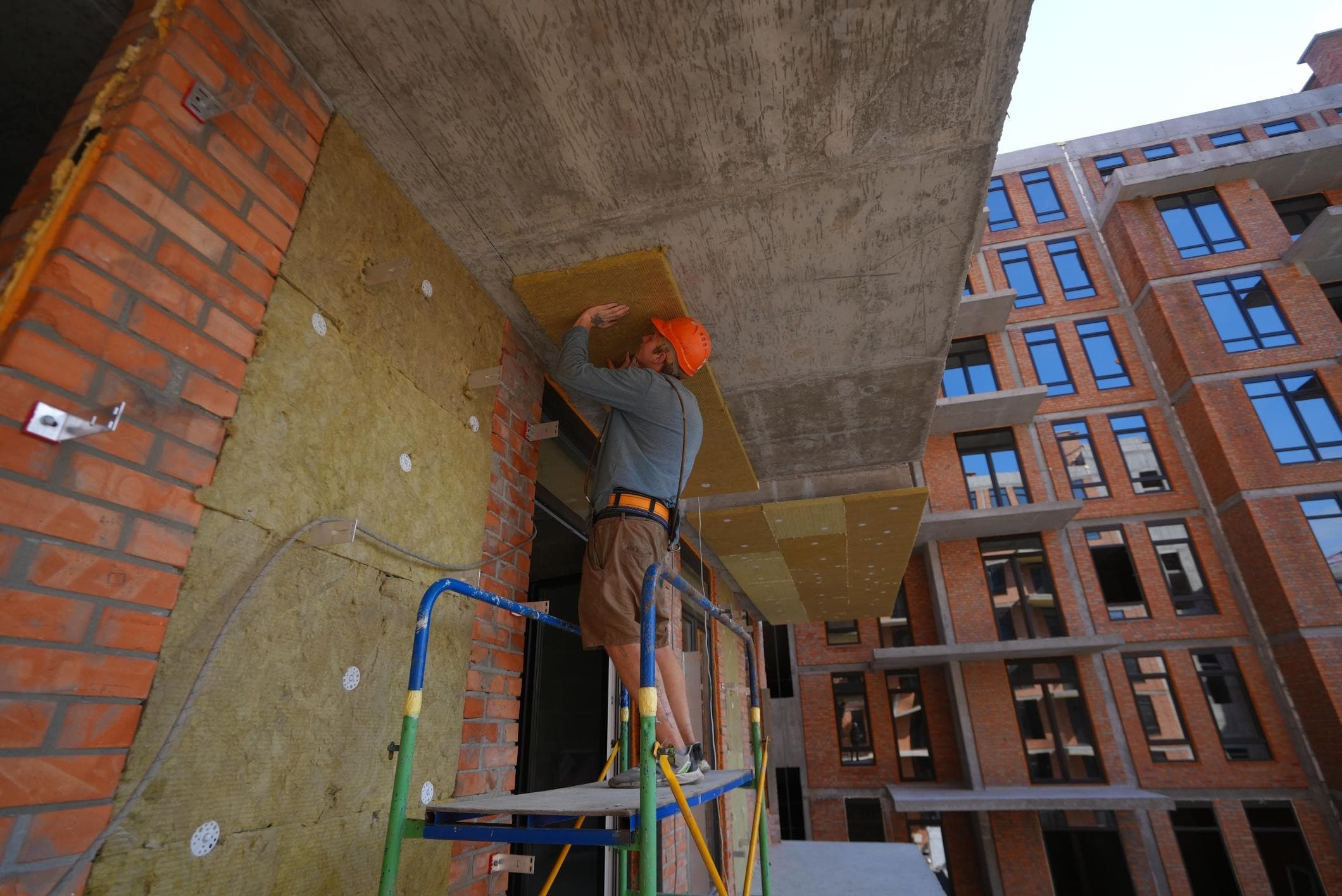

  • Facade installation - 10%

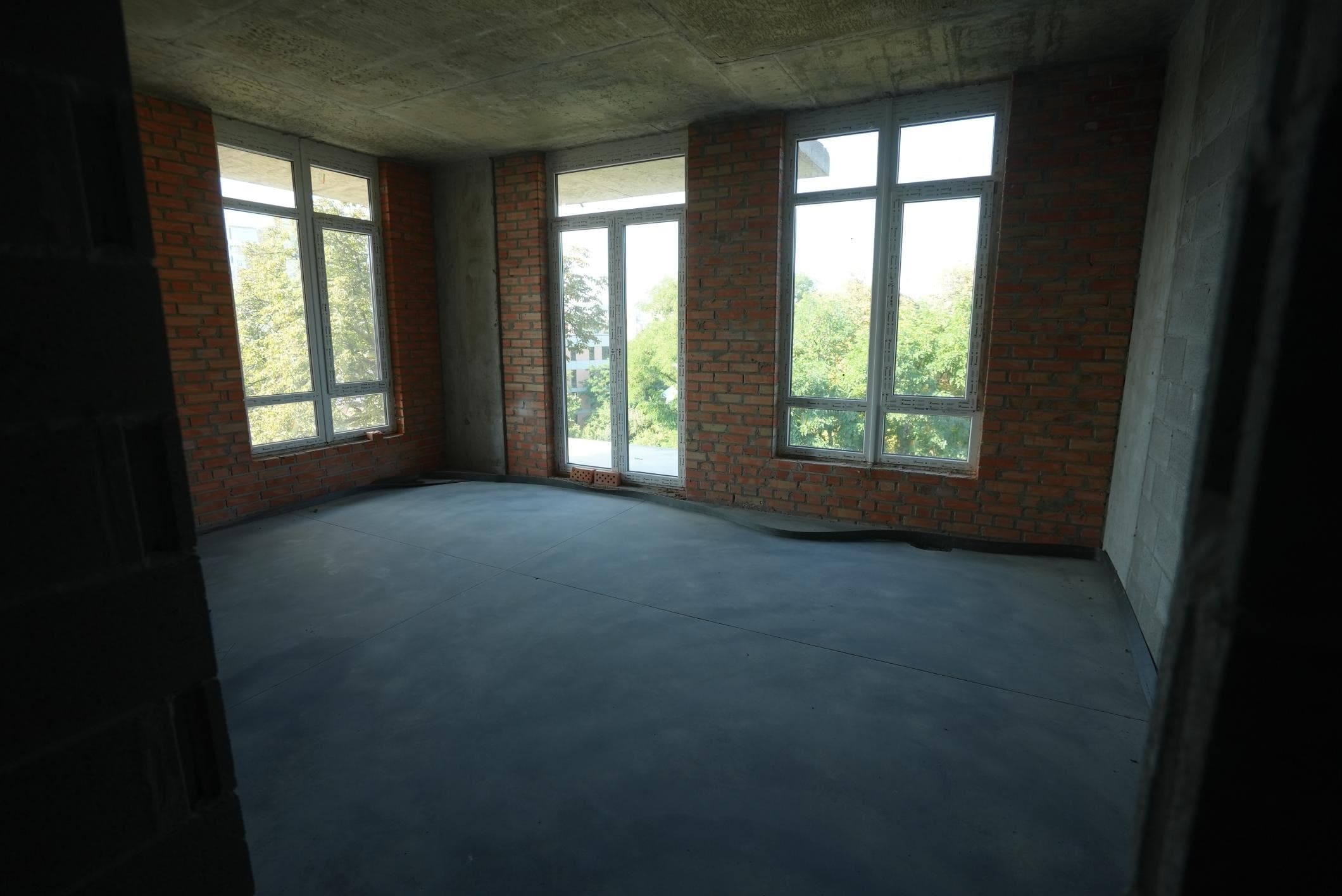

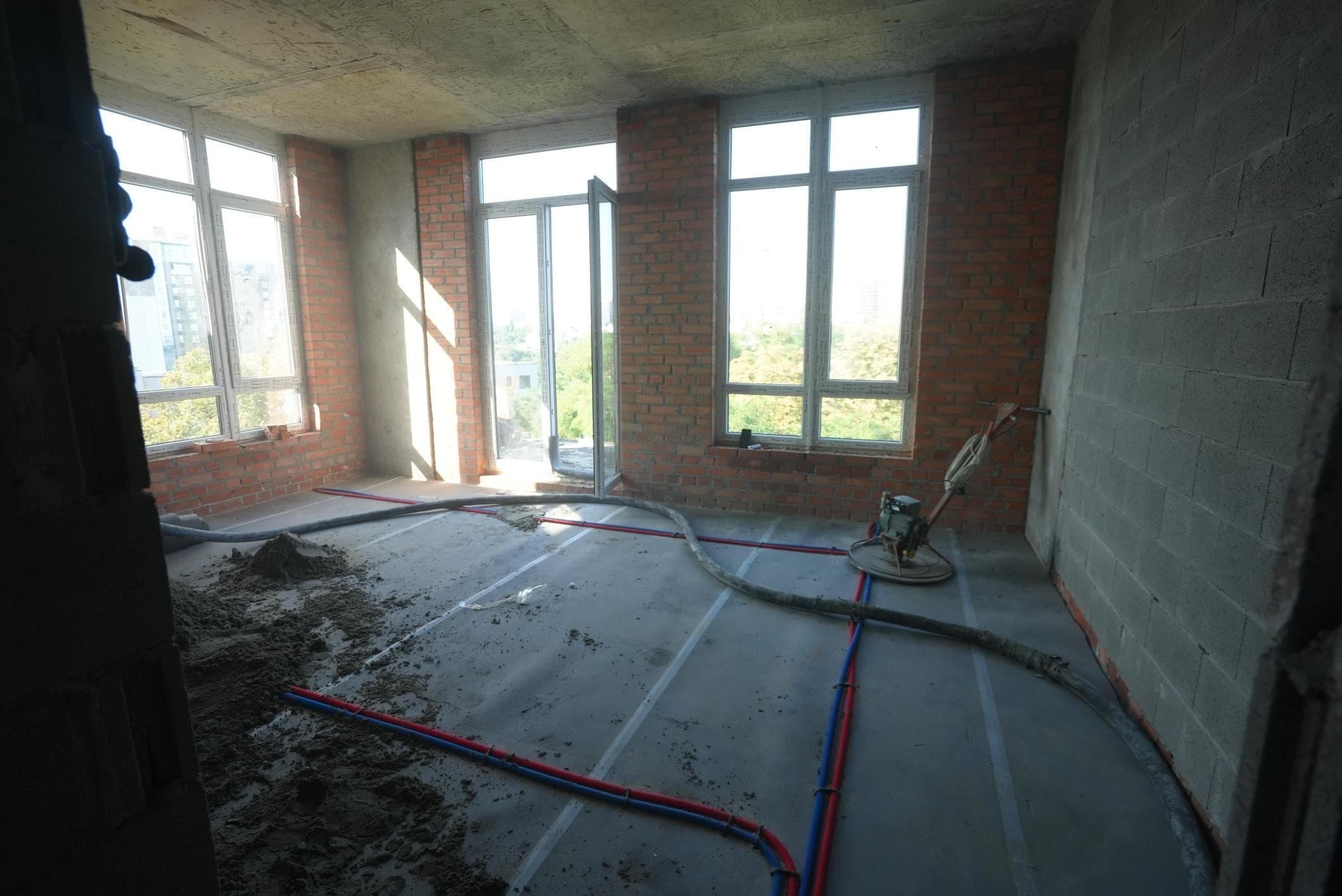

  • Sound insulation, floor installation in apartments, waterproofing in bathrooms and balconies, as well as preparation for laying cement screed from the 2nd to the 8th floor - 100%
  • Installation of internal engineering systems for floor heating/water supply, electrical supply of low-current networks in apartments and common areas from the 2nd to the 8th floor - 100%

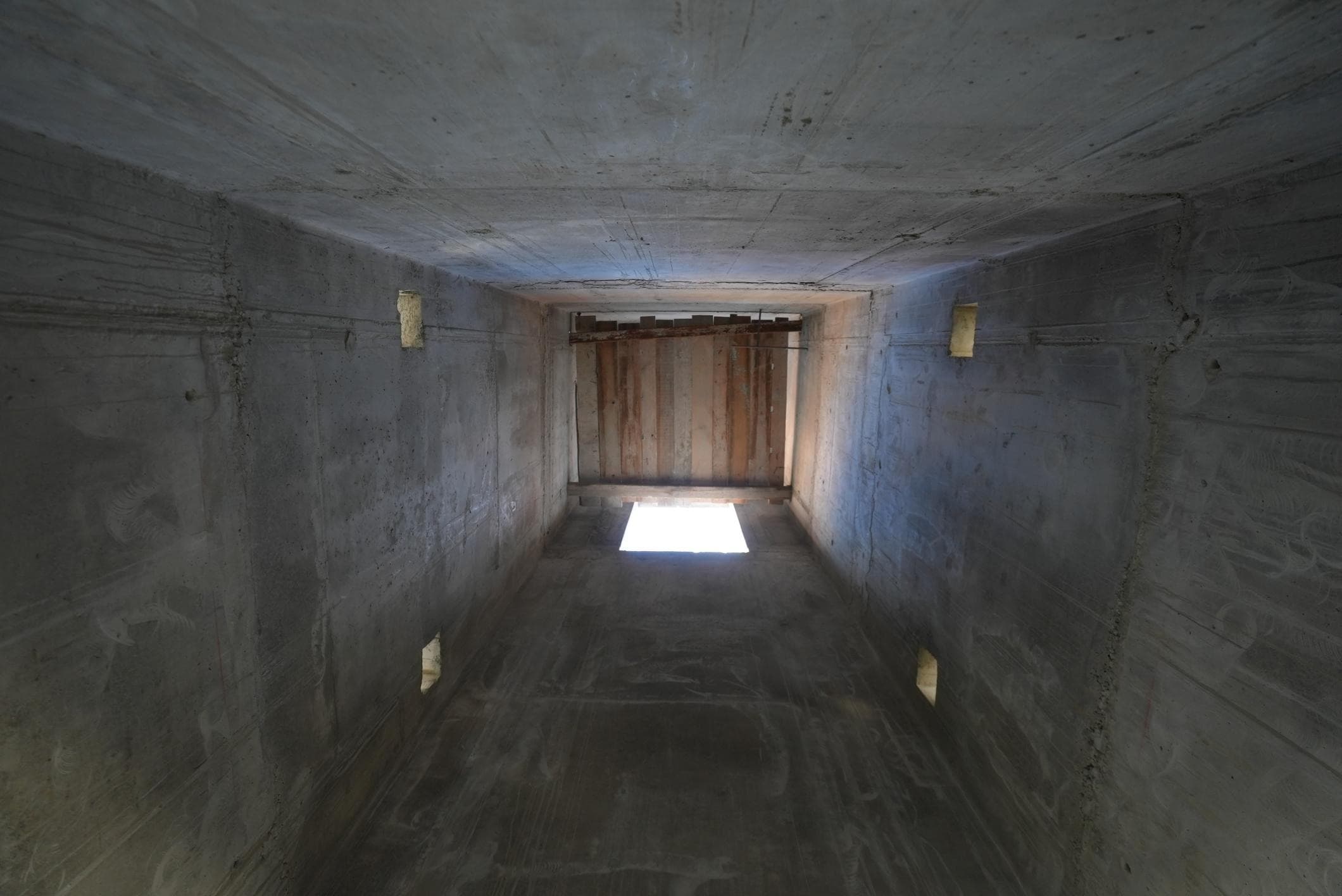

  • Installation of ventilation shafts (covers) - 100%

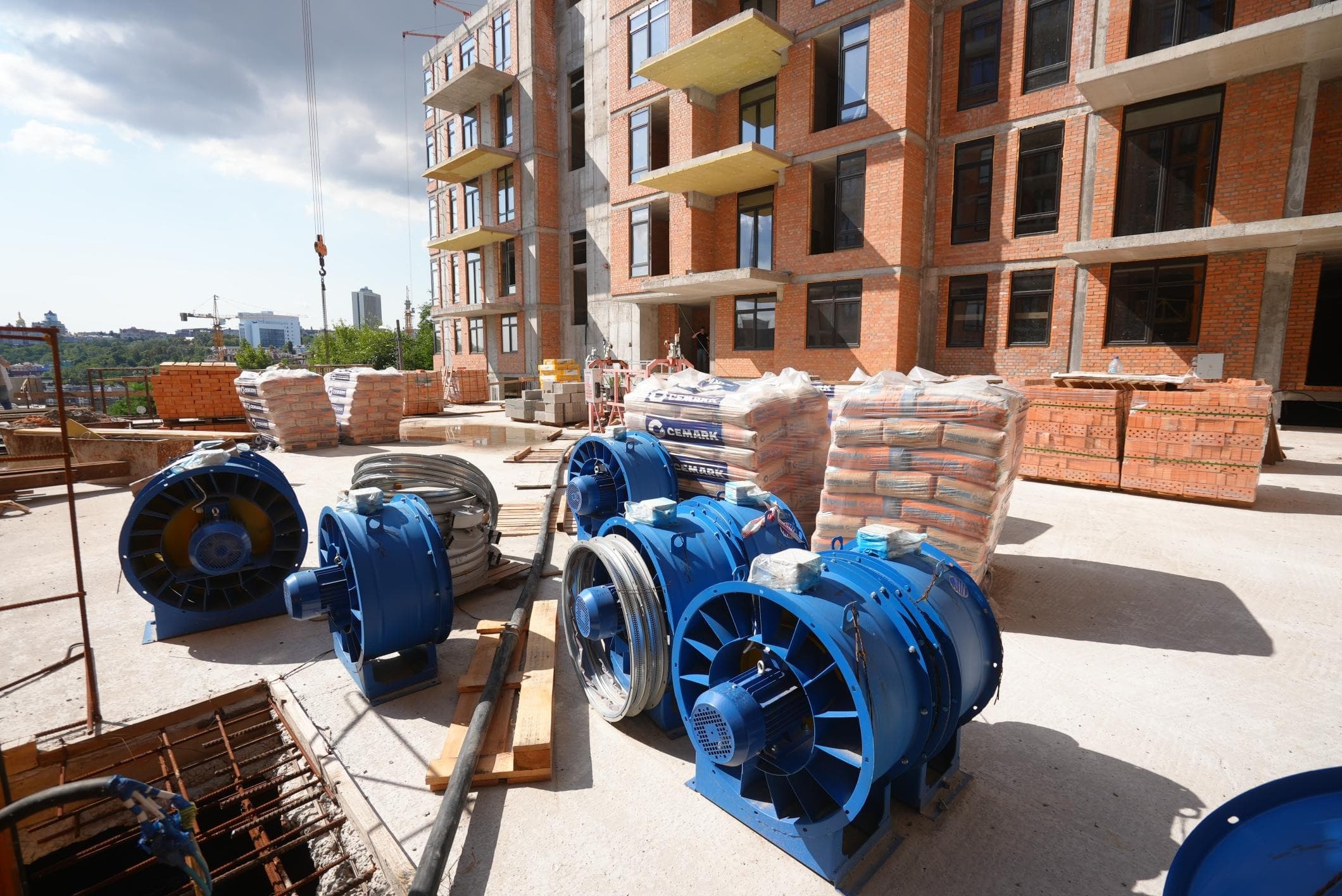

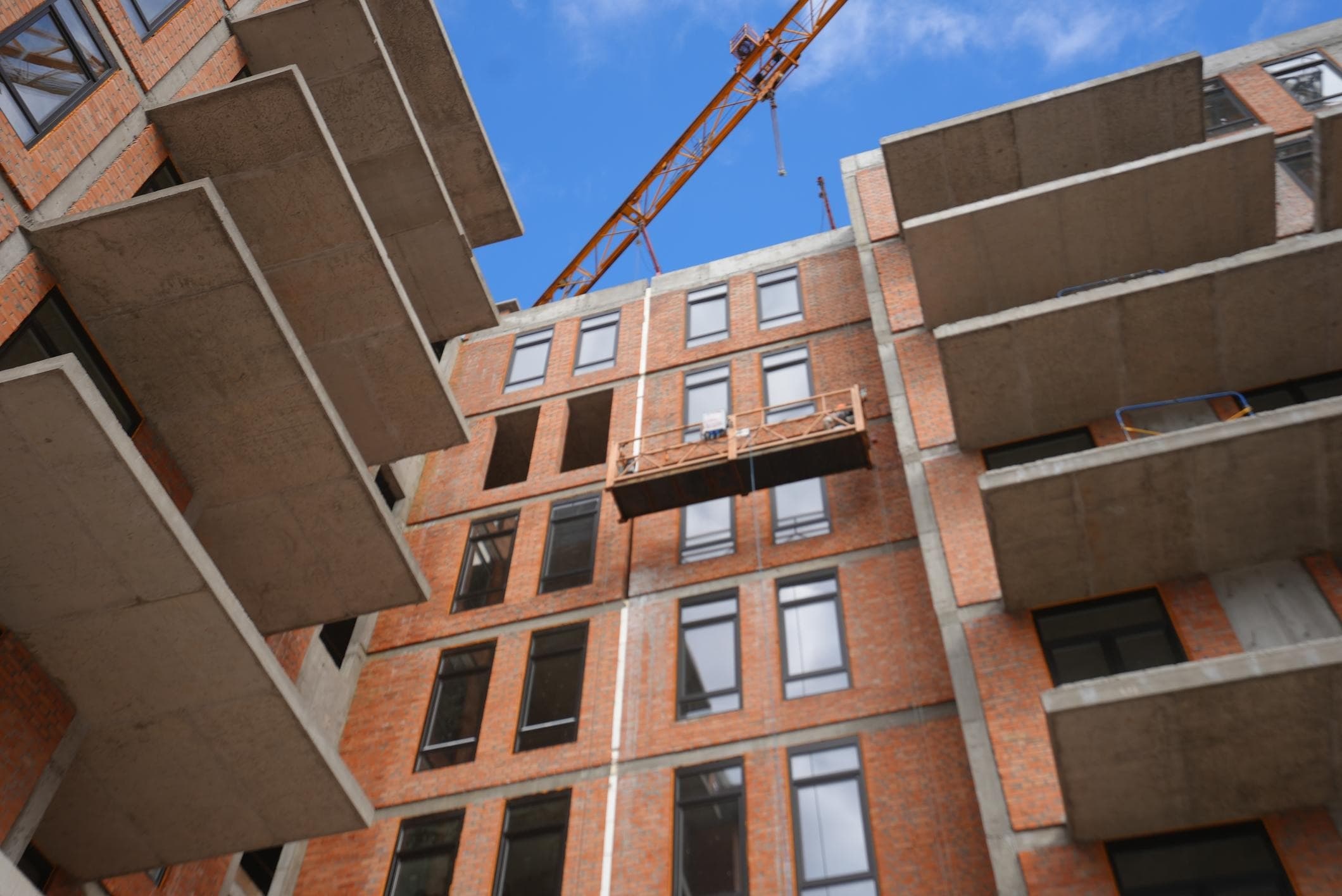

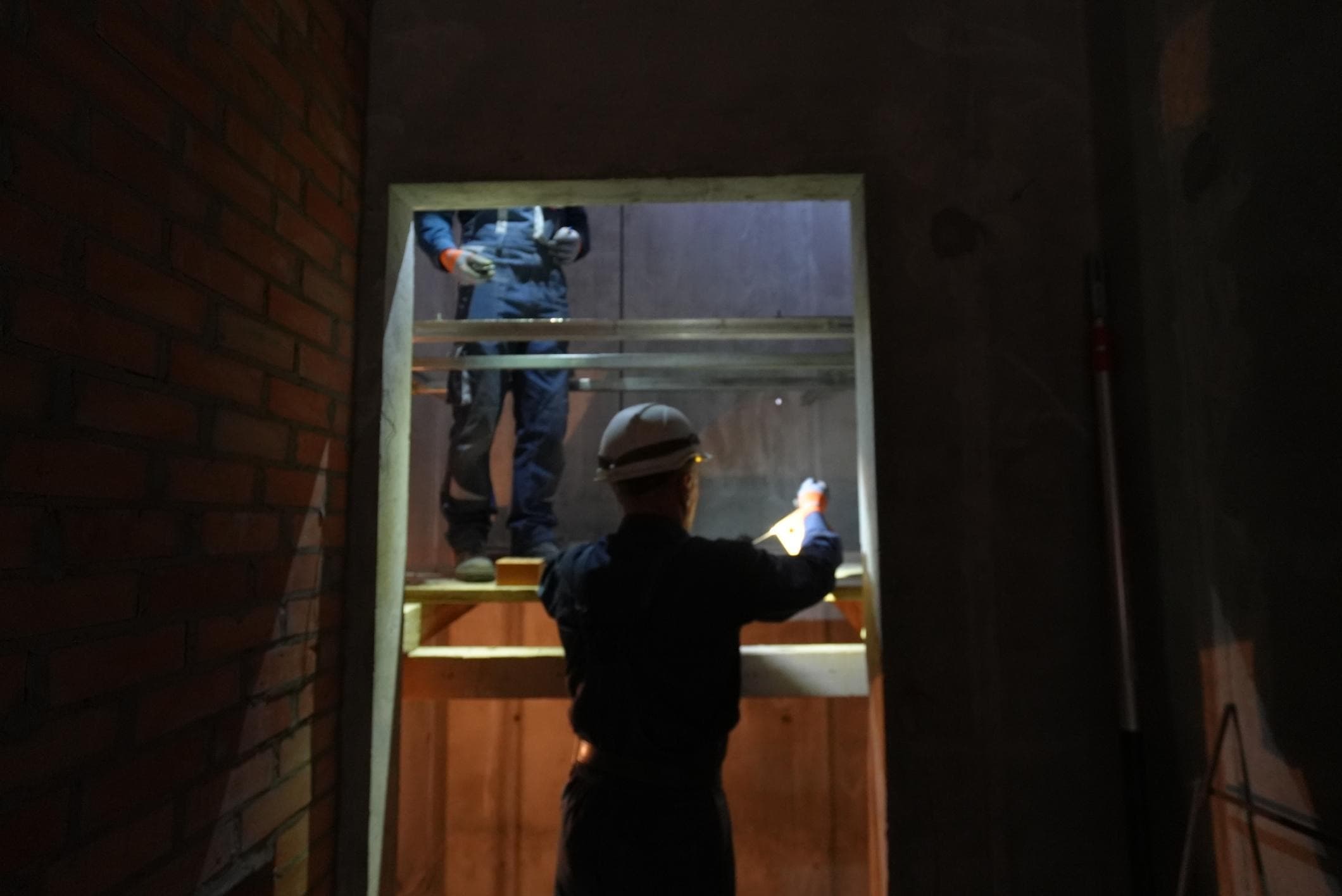

  • Installation of elevator equipment - 20%

Section 2:

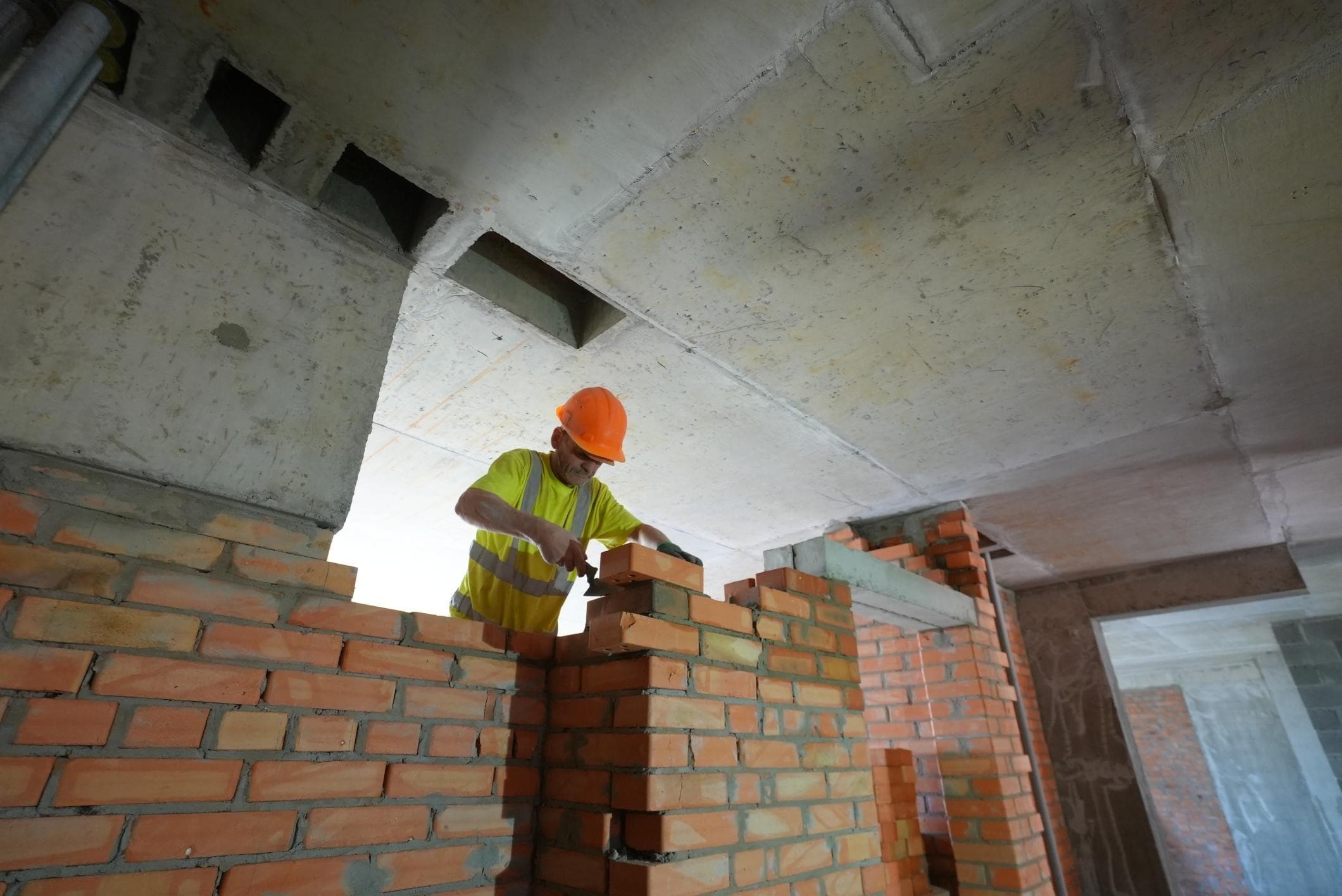

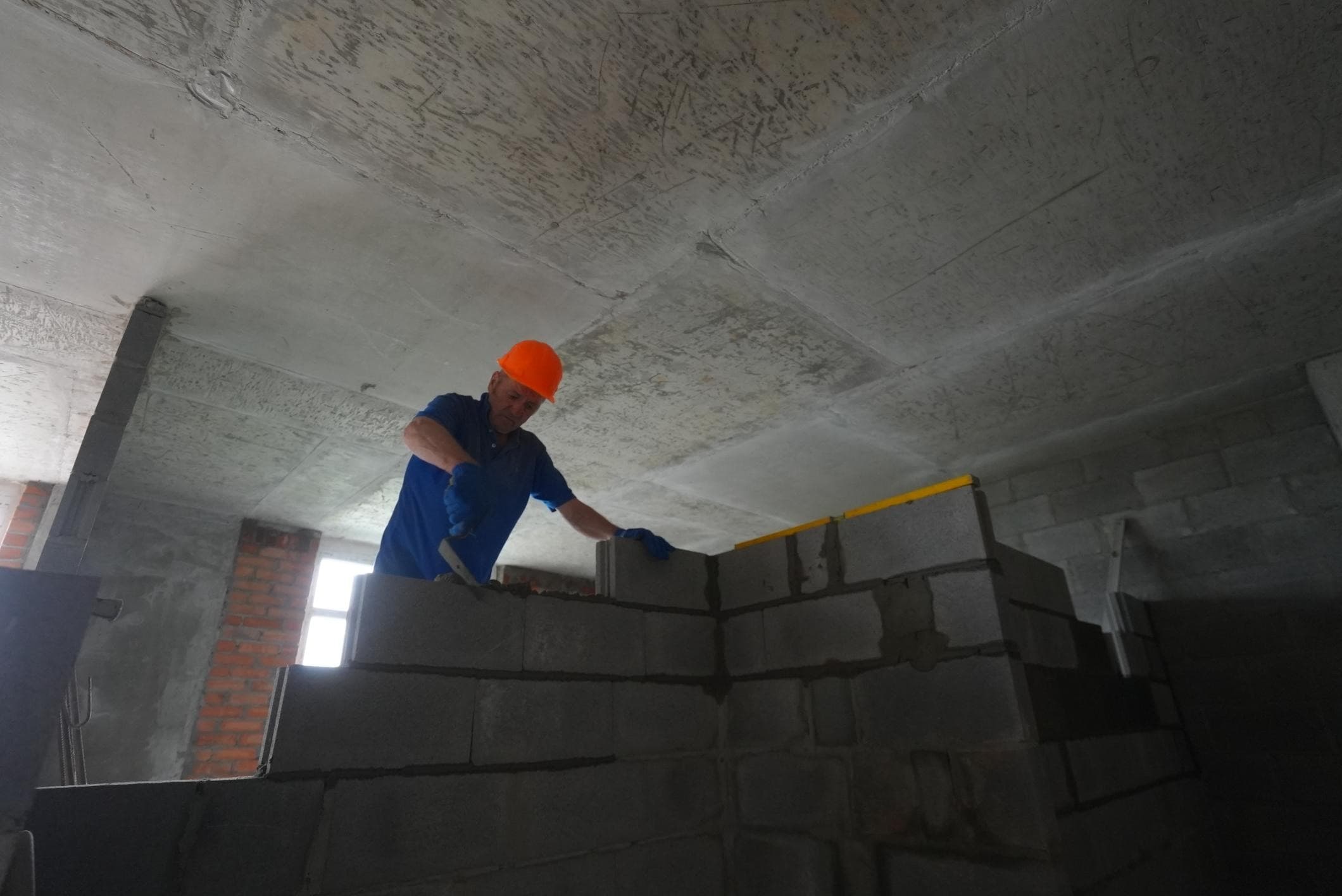

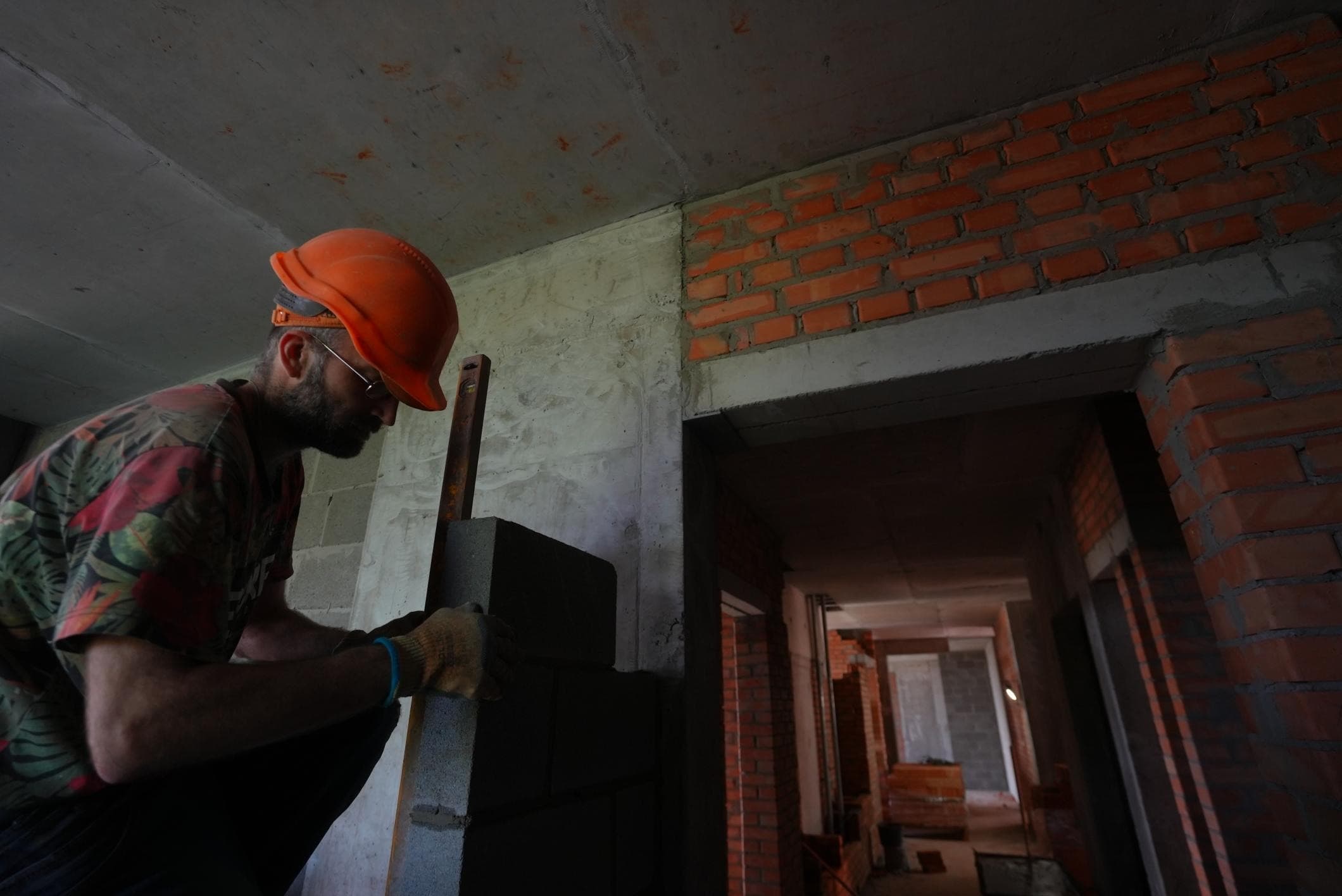

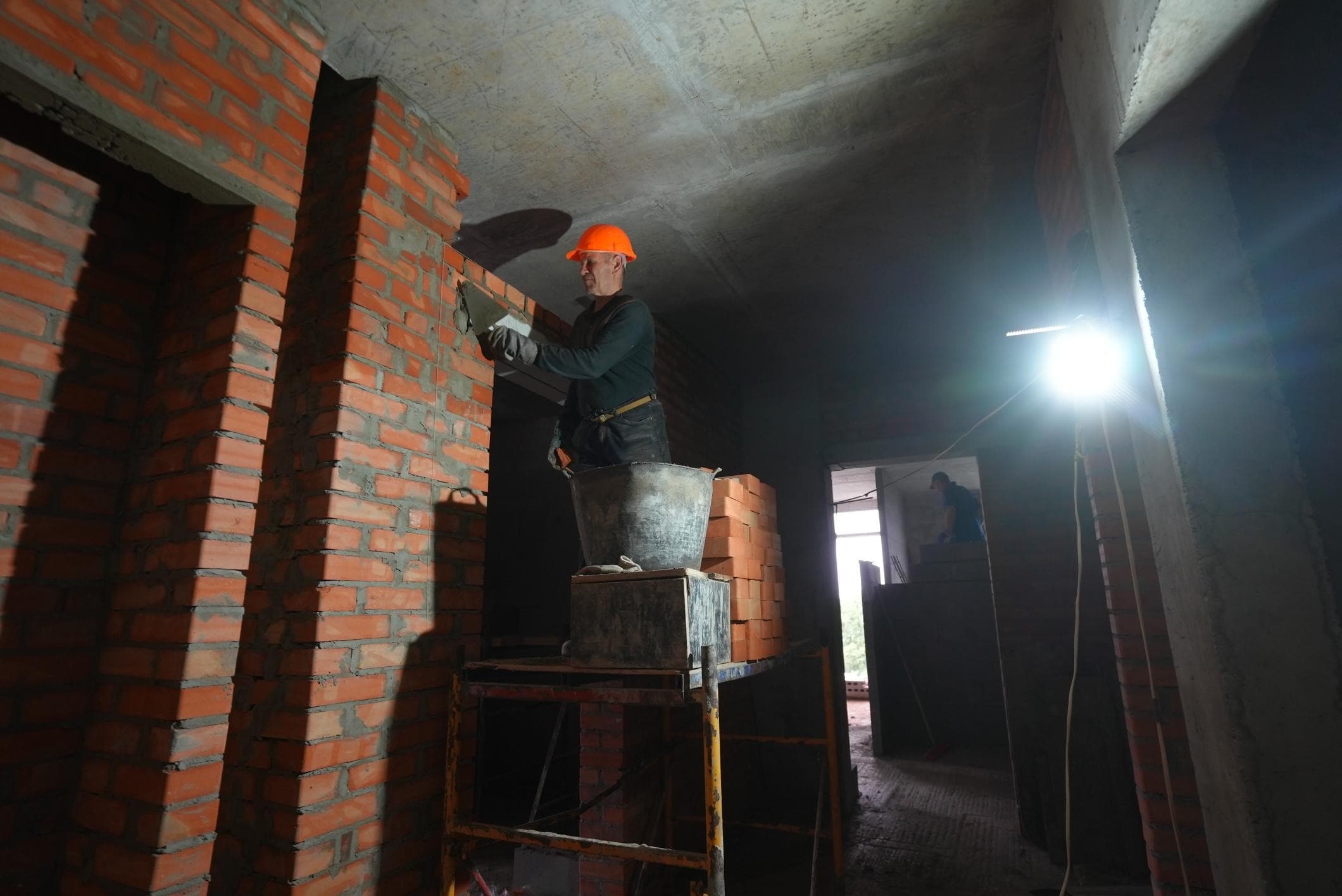

  • Masonry of external and internal partition walls: 4, 6-8 floors - 100%
  • Window installation: 1st floor - 95%, 2nd and 4th floors - 100%

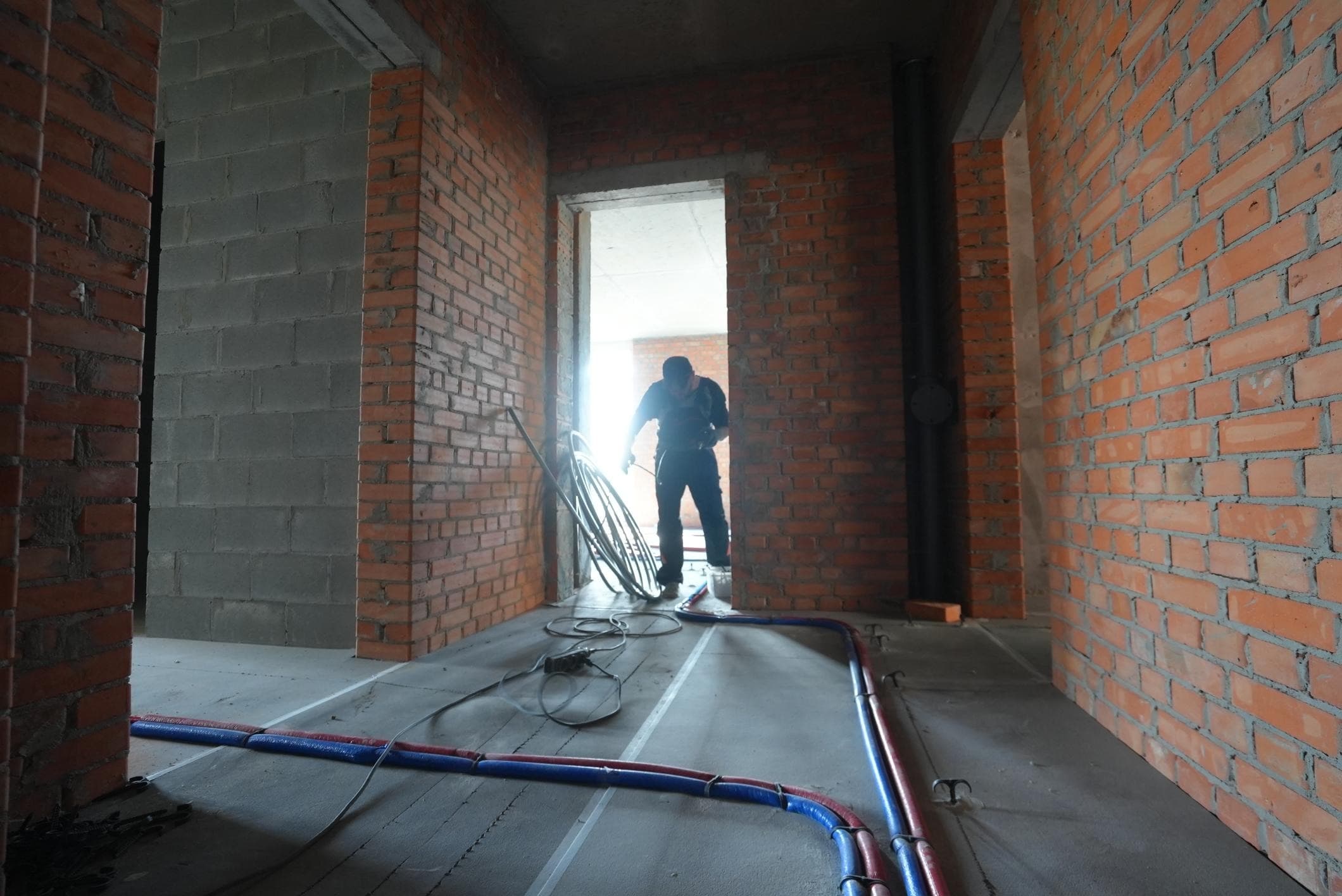

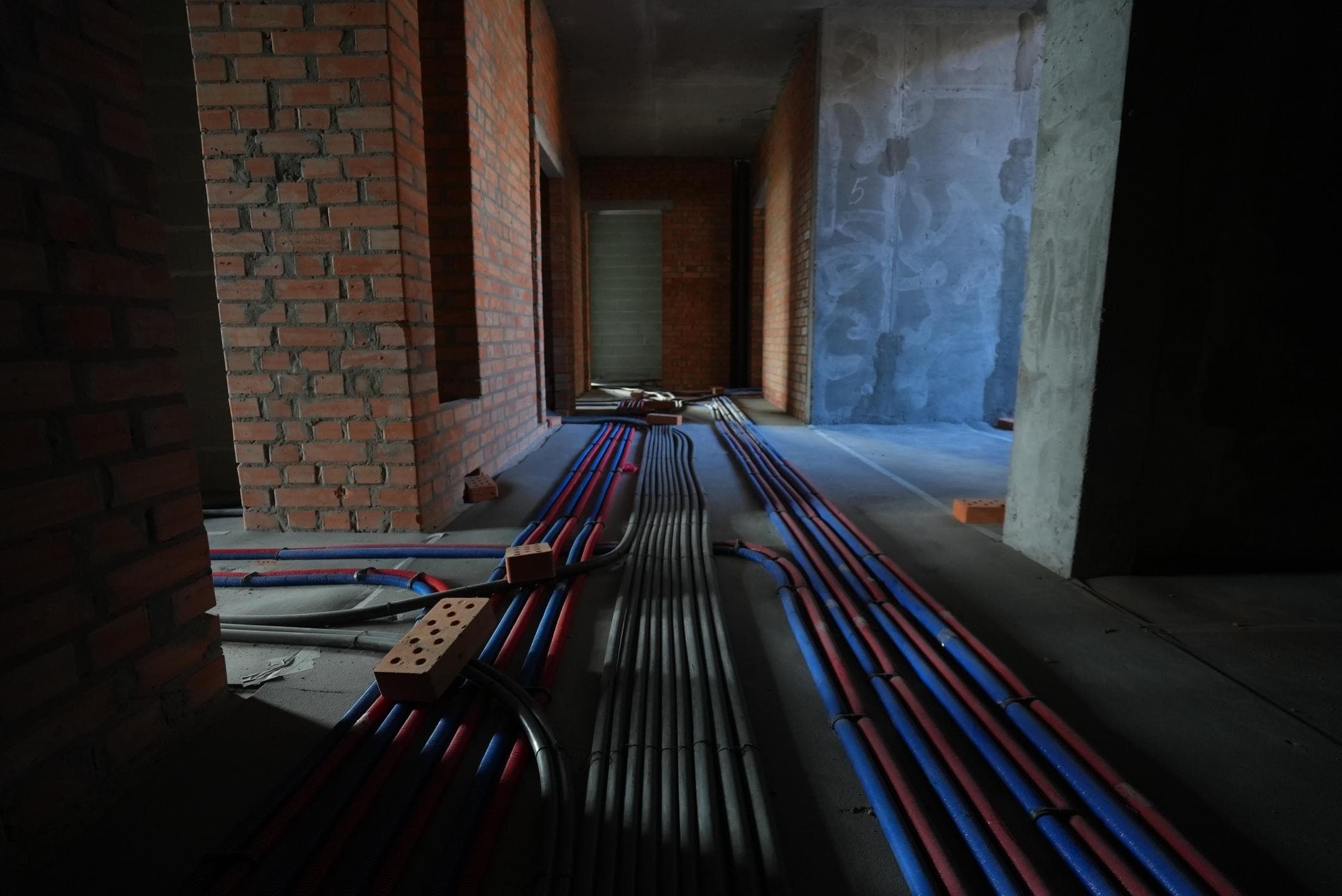

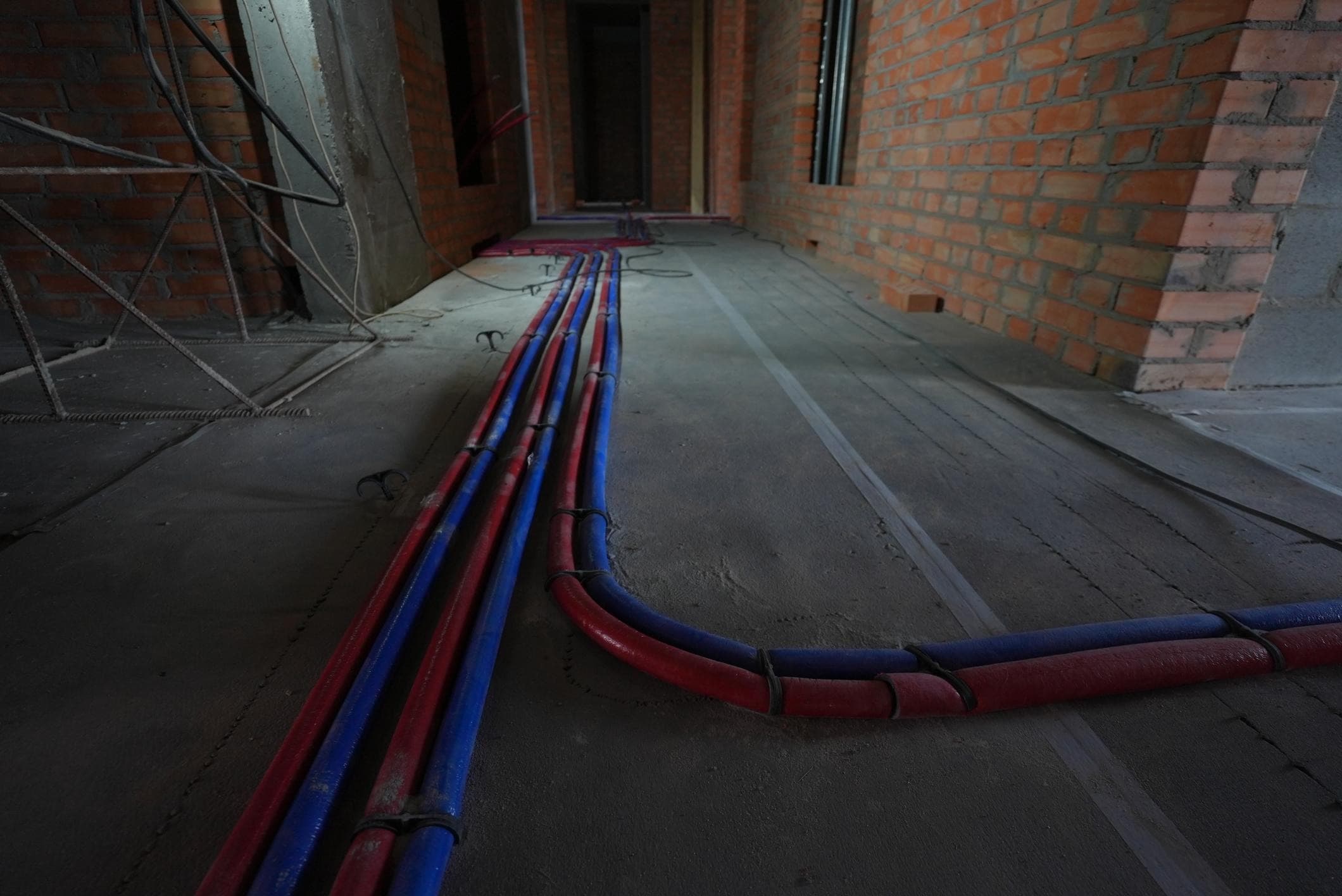

  • Installation of water supply risers - 20%
  • Installation of ventilation shafts (covers) - 100%

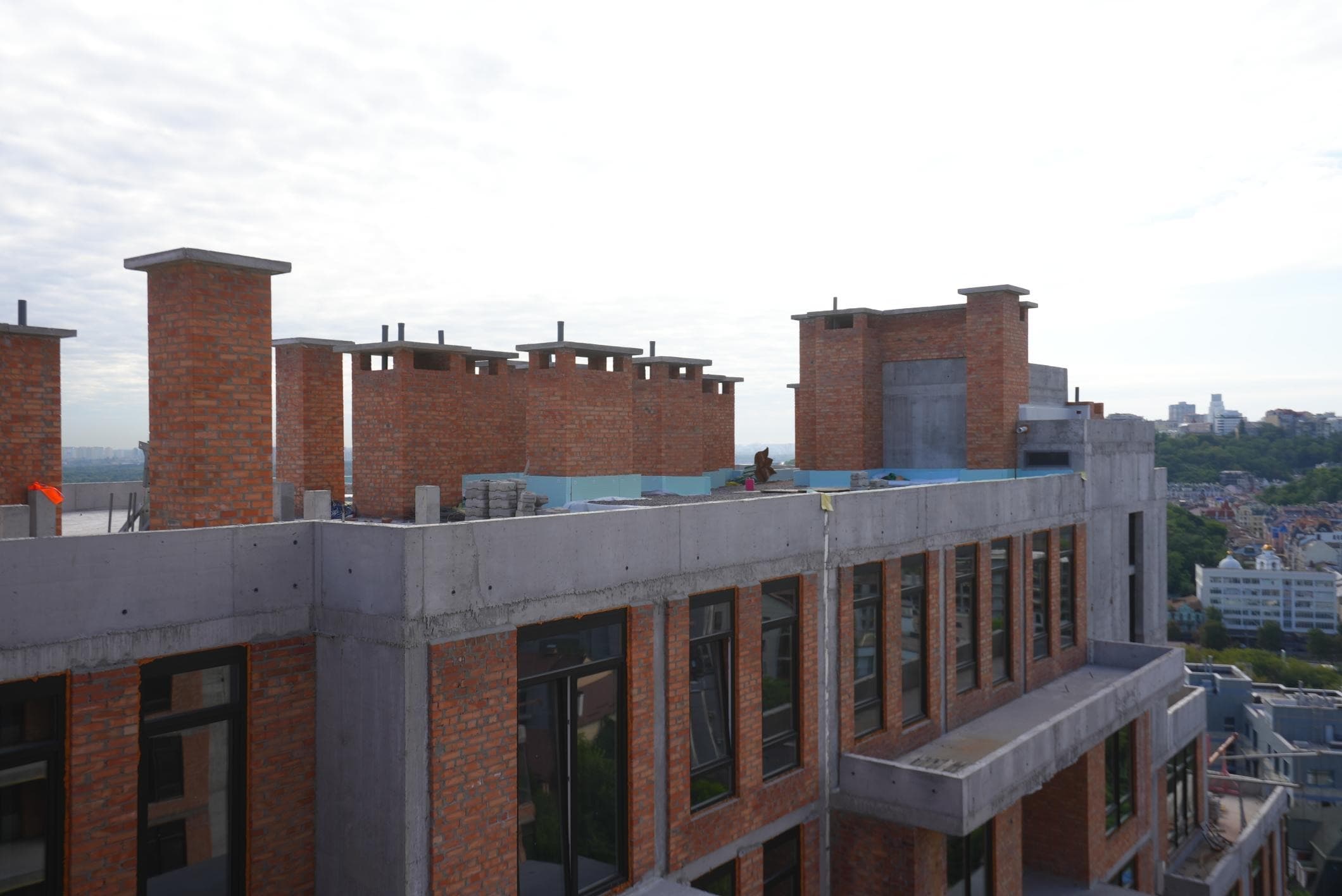

  • Foundation construction on the existing roof

Section 3:

  • Foundation construction on the existing roof
  • Installation of ventilation shafts (covers) - 100%

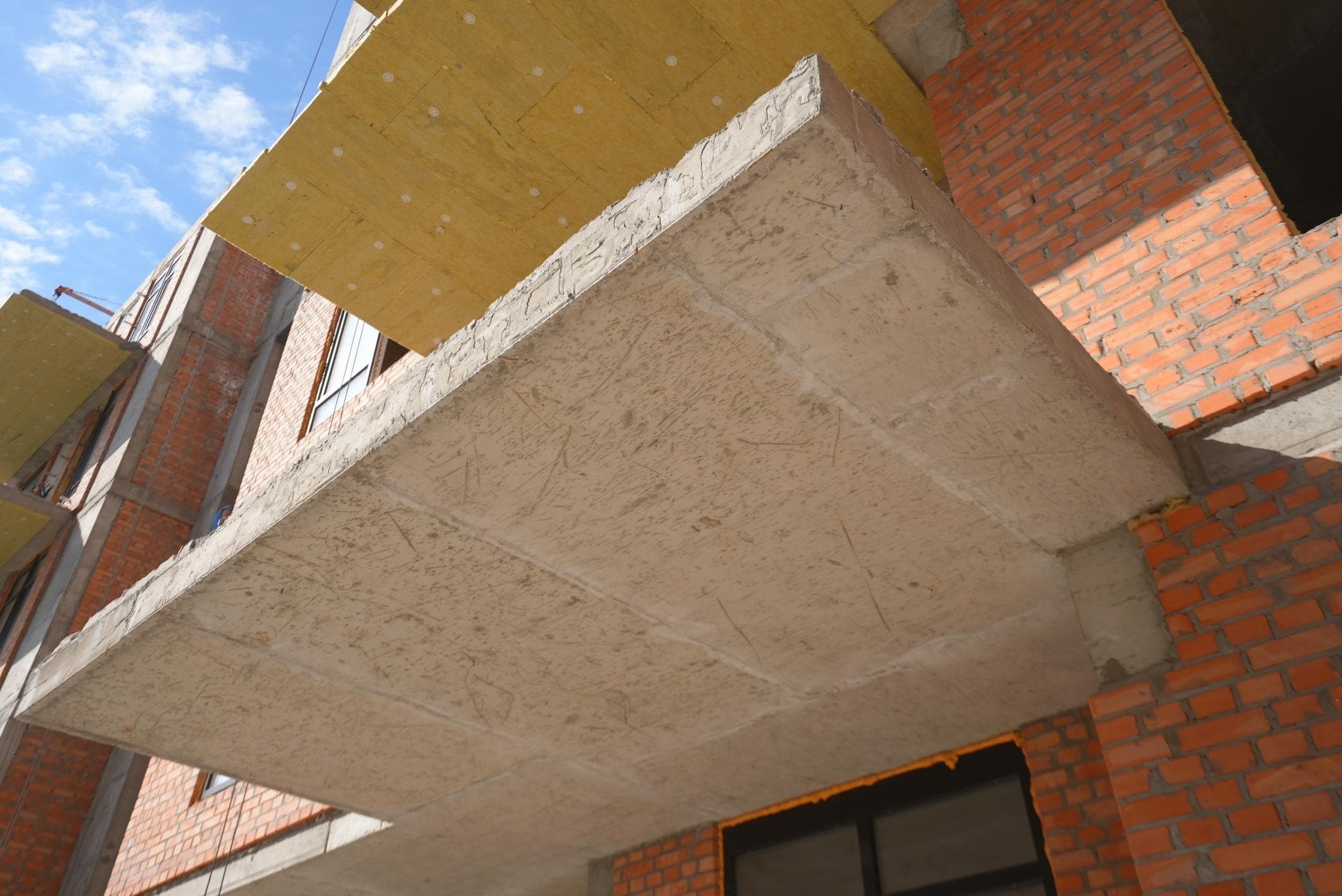

  • Facade installation - 10%

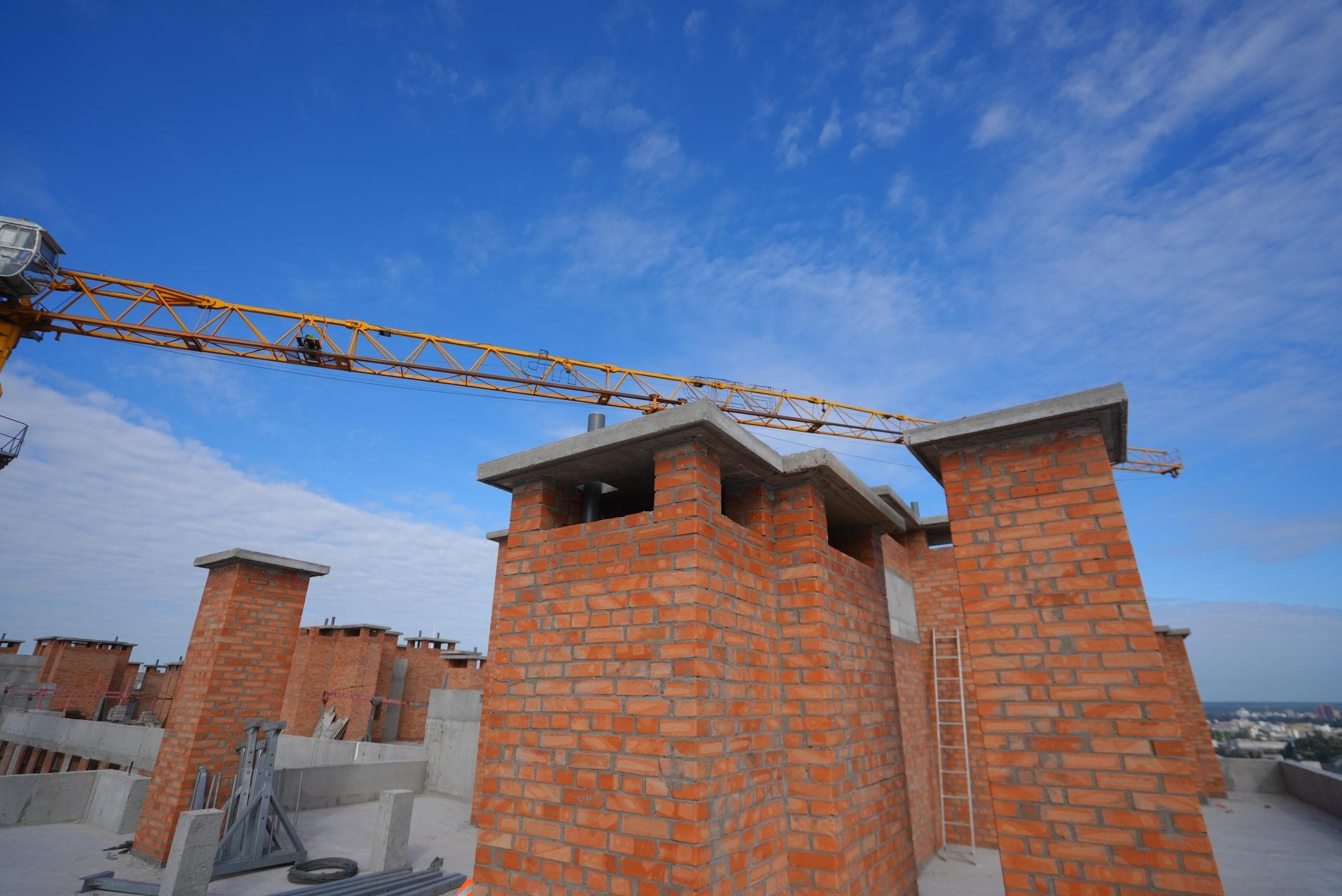

  • Installation of heating risers for stairwells - 100%

Section 4:

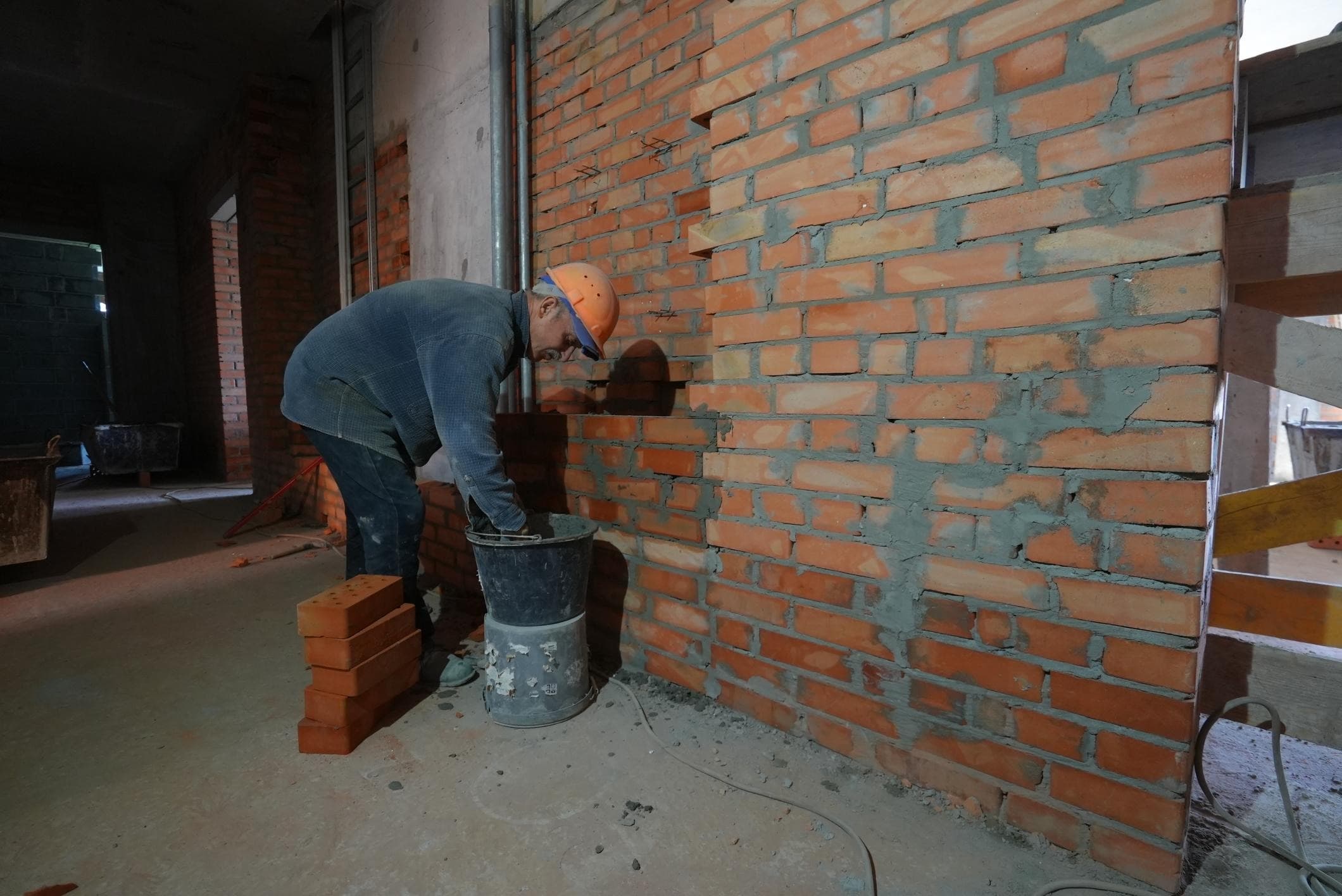

  • Masonry of external and internal partition walls: 2nd floor - 100%
  • Sound insulation, floor installation in apartments, waterproofing in bathrooms and balconies, as well as preparation for laying cement screed - 90%
  • Installation of water supply risers - 75%
  • Installation of ventilation shafts (covers) - 100%
  • Foundation construction on the existing roof
  • Installation of internal engineering networks for electrical heating in apartments and common areas - 20%

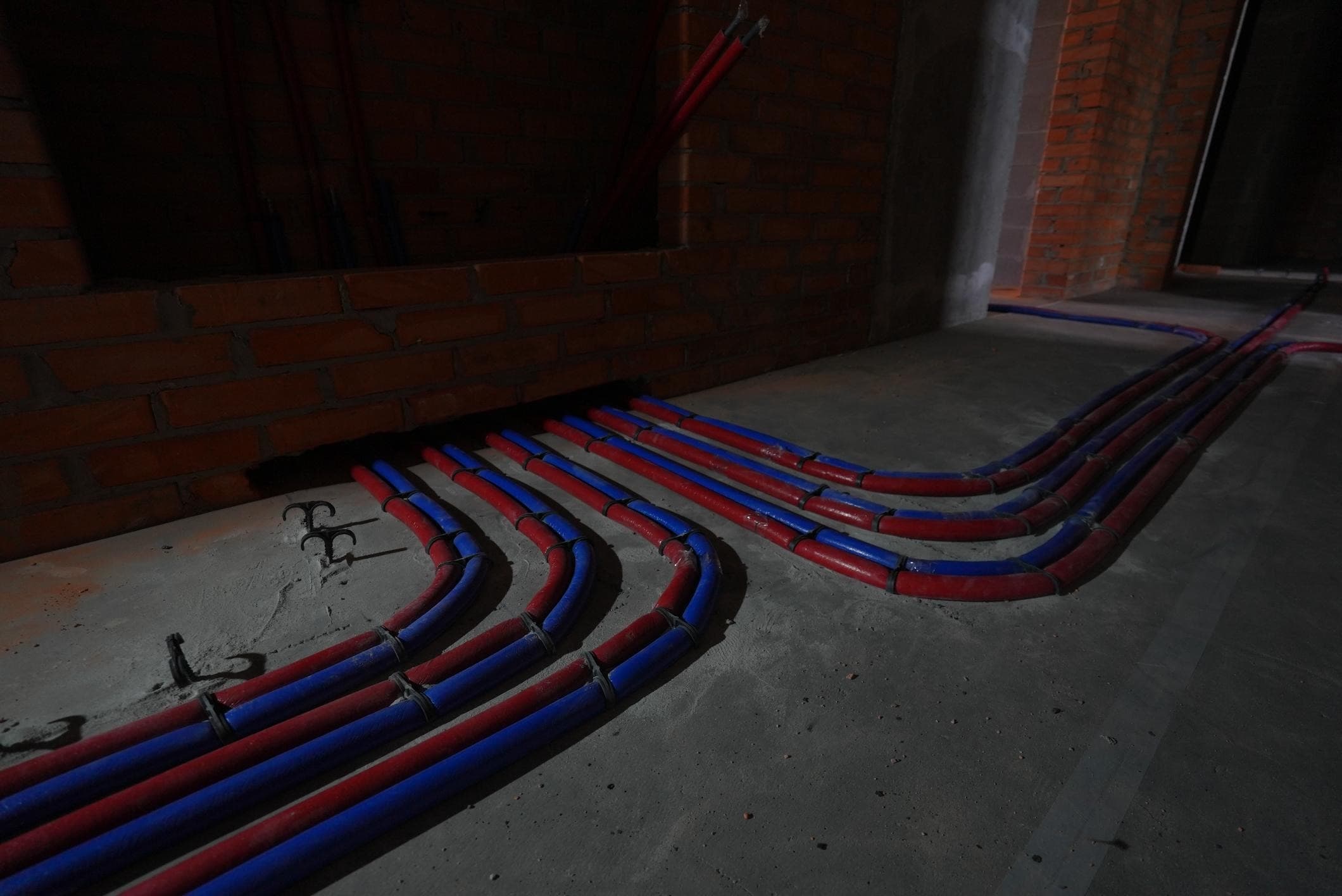

  • Installation of internal engineering networks for water supply, sewage, and storm drainage - 20%

Section 5:

  • Masonry of external and internal partition walls: 2nd floor - 100%
  • Sound insulation, floor installation in apartments, waterproofing in bathrooms and balconies, as well as preparation for laying cement screed from the 2nd to the 8th floor - 100%
  • Installation of internal engineering networks for electrical heating in apartments and common areas - 80%
  • Installation of internal engineering networks for water supply, sewage, and storm drainage - 80%
  • Facade installation - 5%
  • Installation of ventilation shafts (covers) - 100%
  • Laying of cement-sand screed from the 6th to the 8th floor - 100%

Parking:

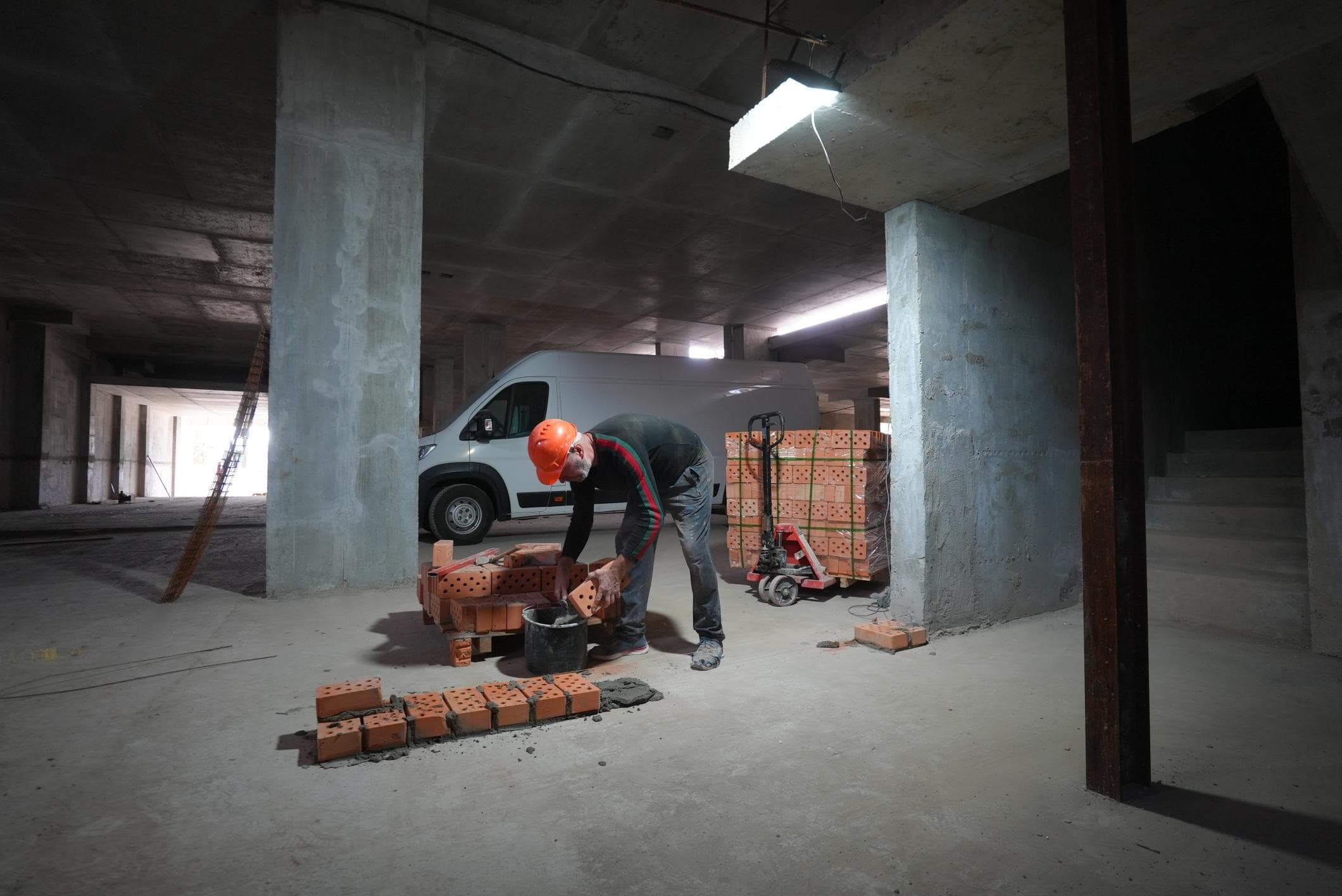

  • Masonry of external and internal partition walls - 5%
Stay tuned

Other news

  • News

    Exclusive apartments with fireplaces — a limited collection at OLEGIV Podil

  • Offers

    Apartments with autonomous gas heating

  • Offers

    The Magic of Podil on Black Friday

  • progress of construction

    Construction progress for October 2025
