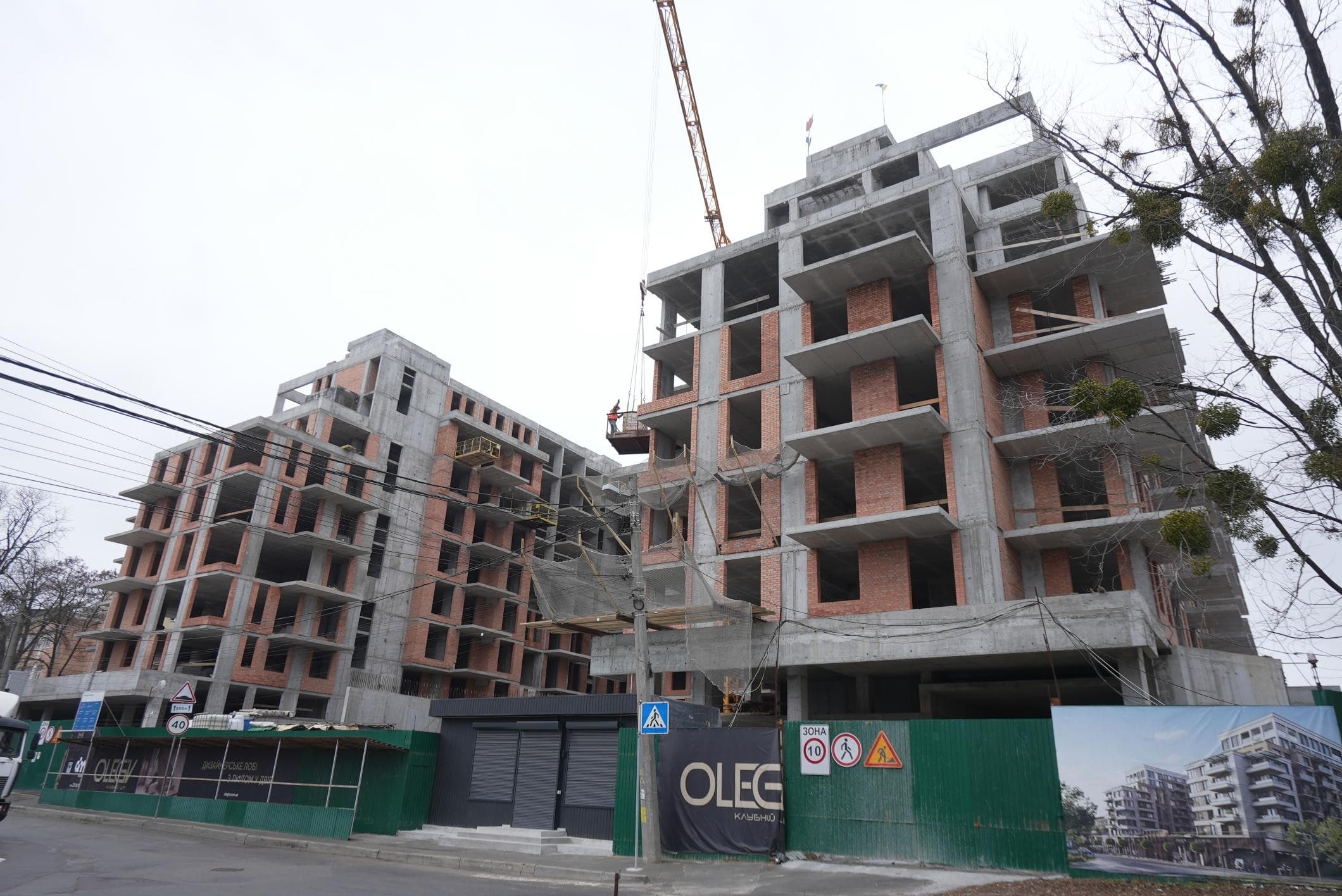

In January 2025, the following work was completed on the construction site:

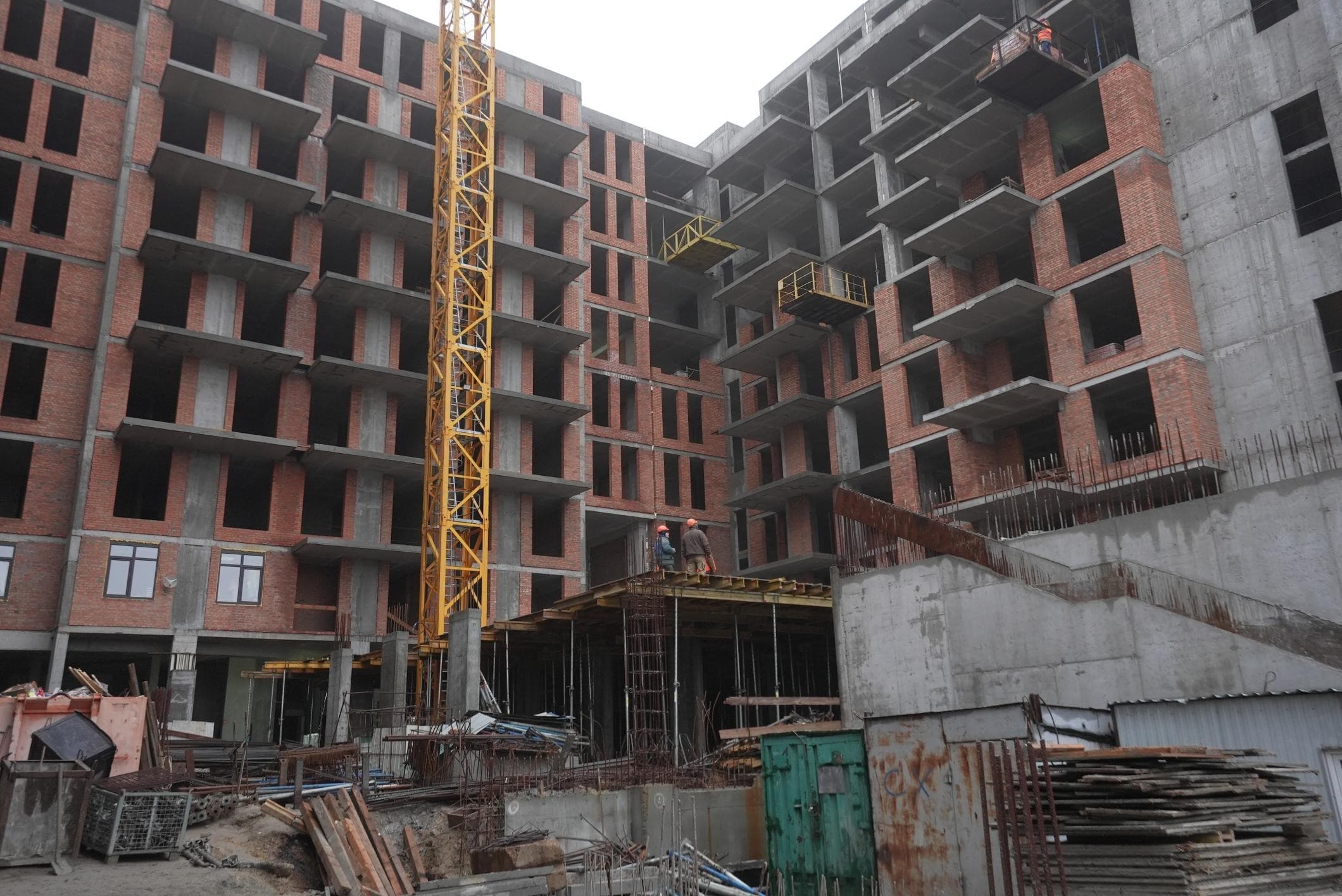

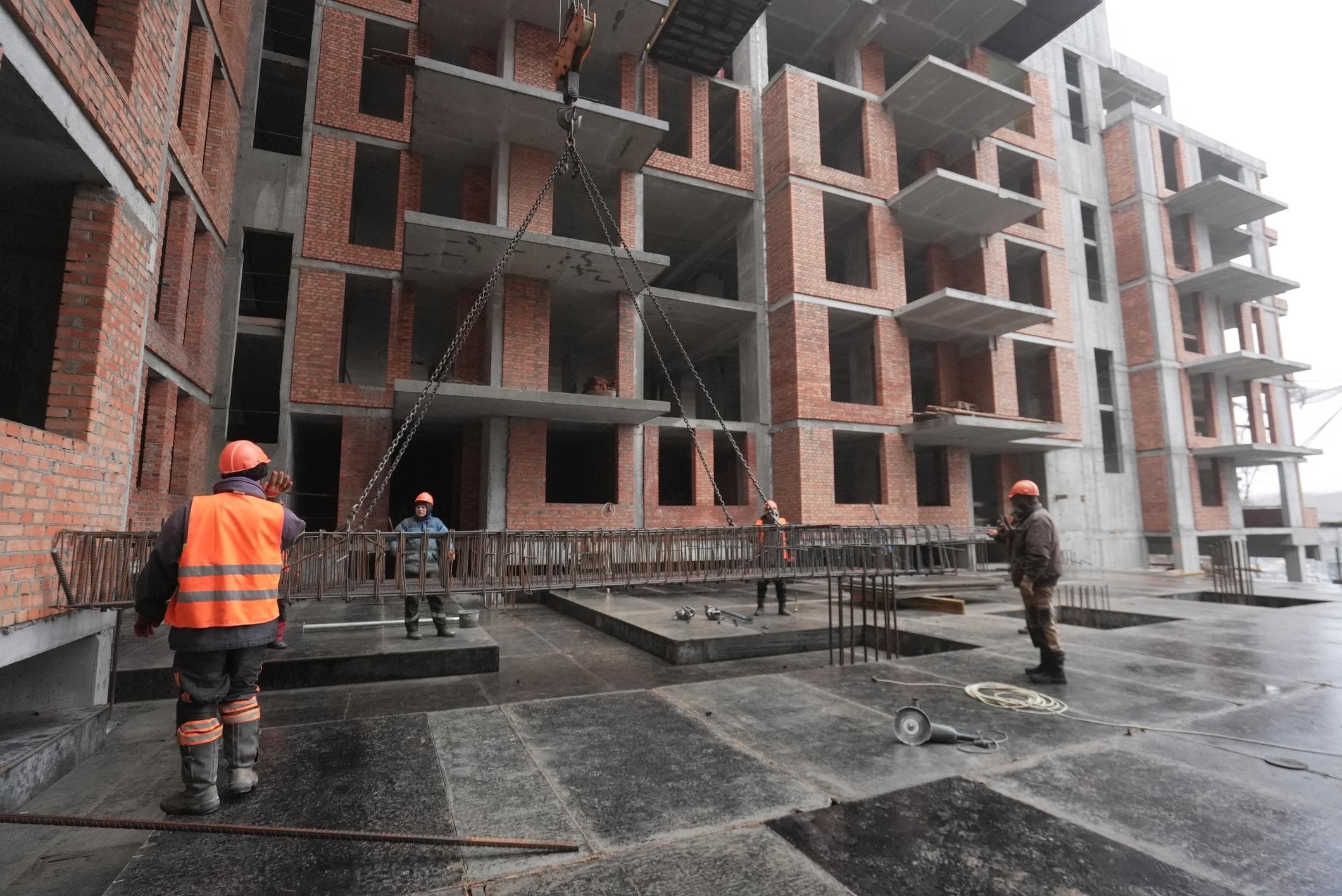

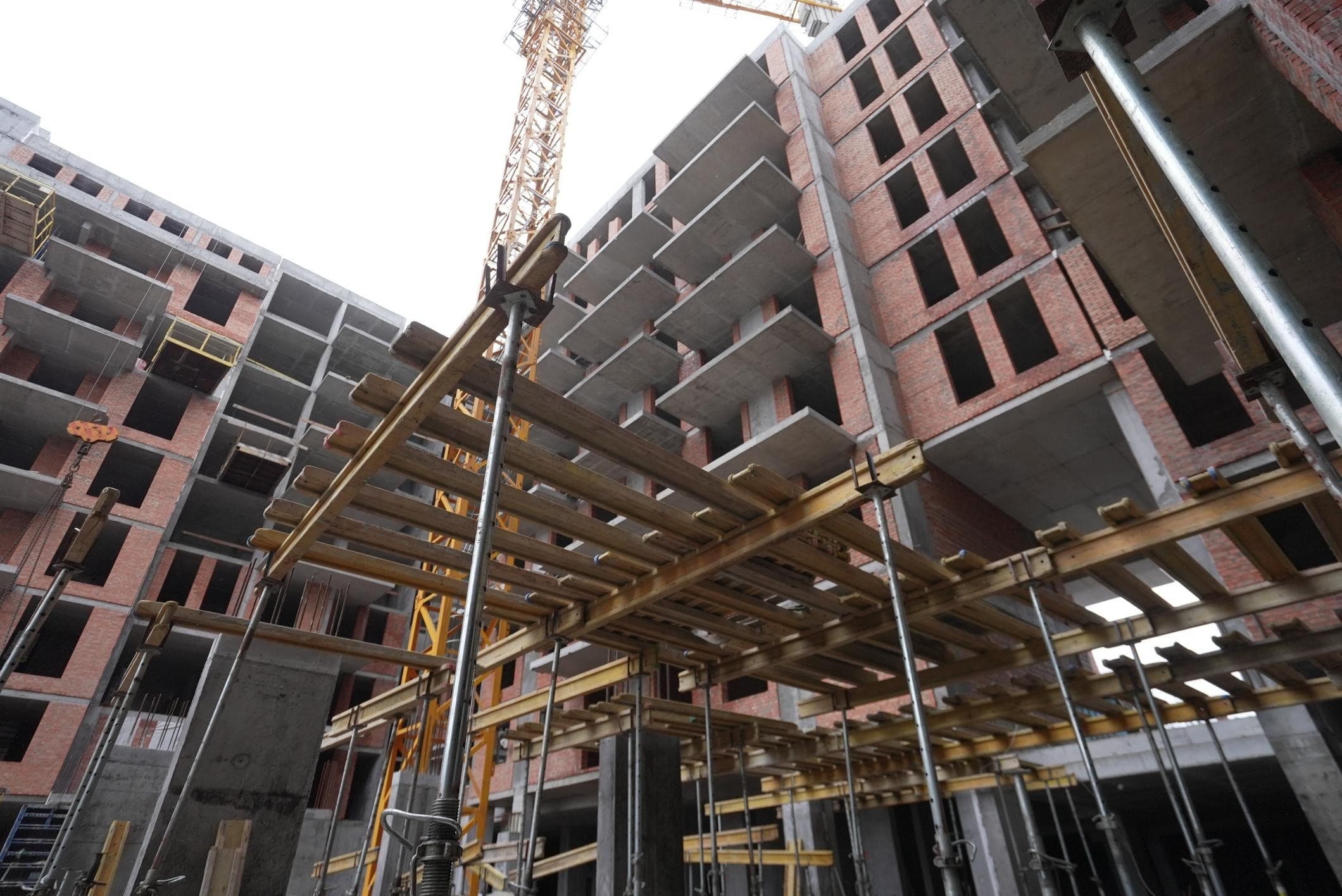

Section 1:

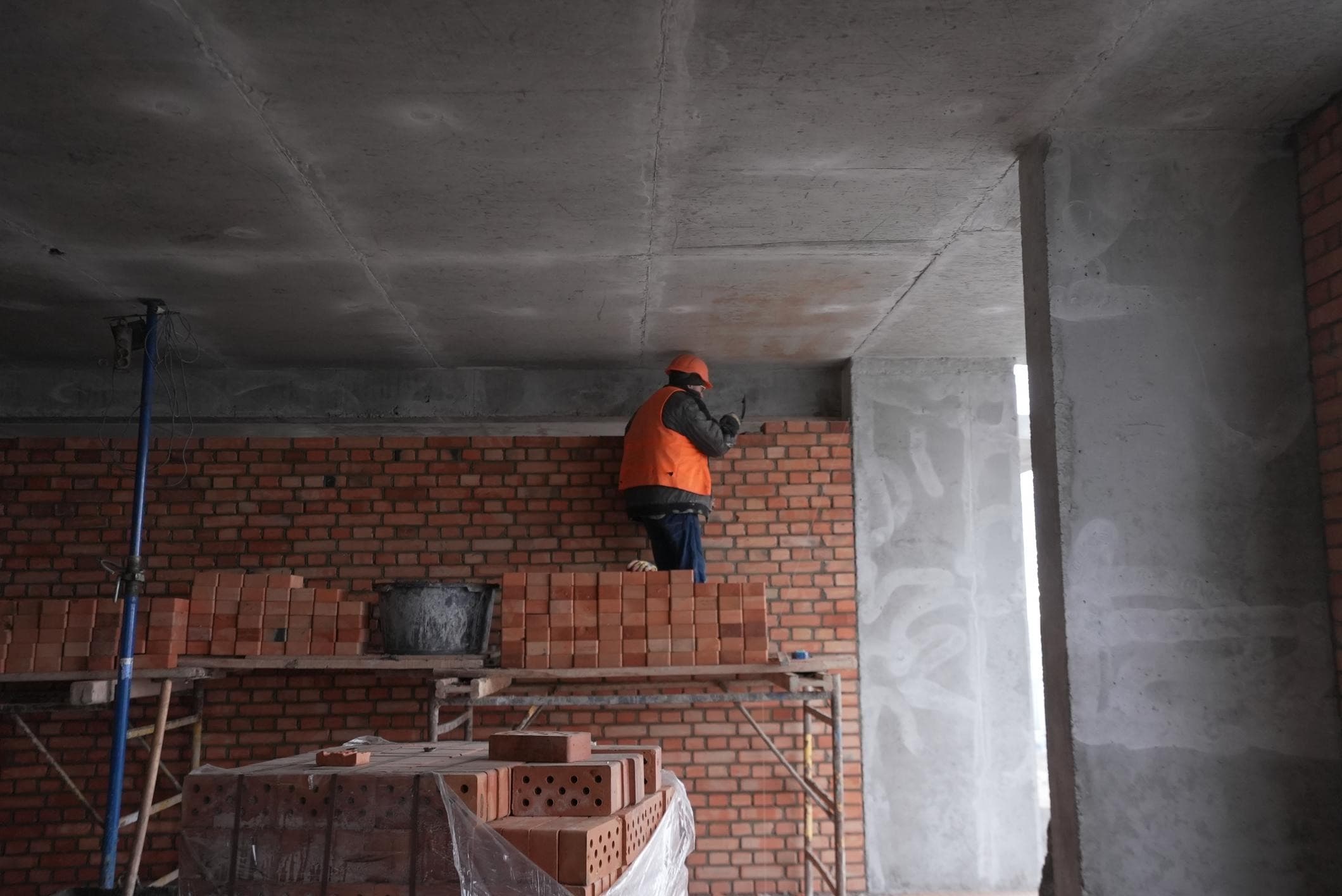

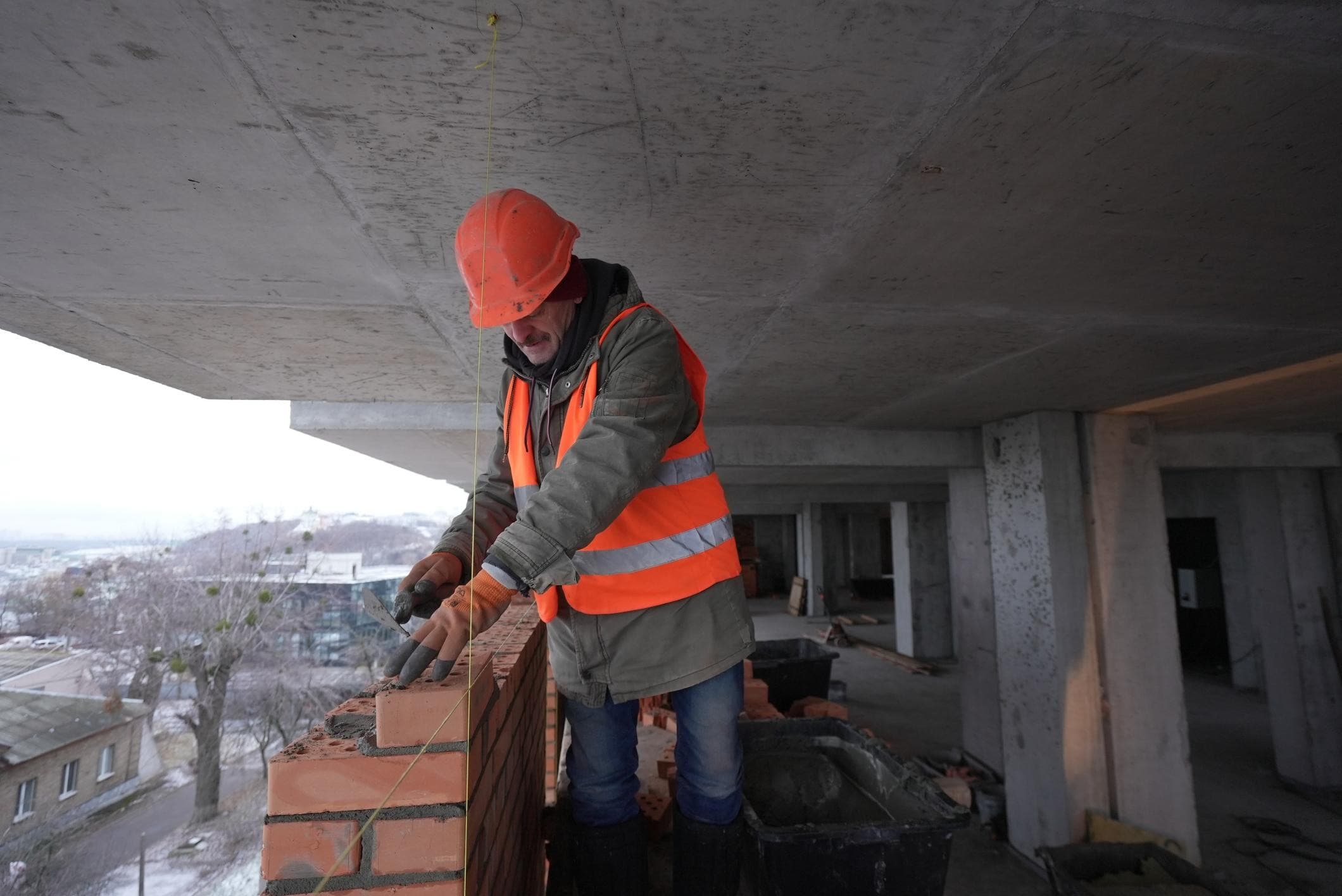

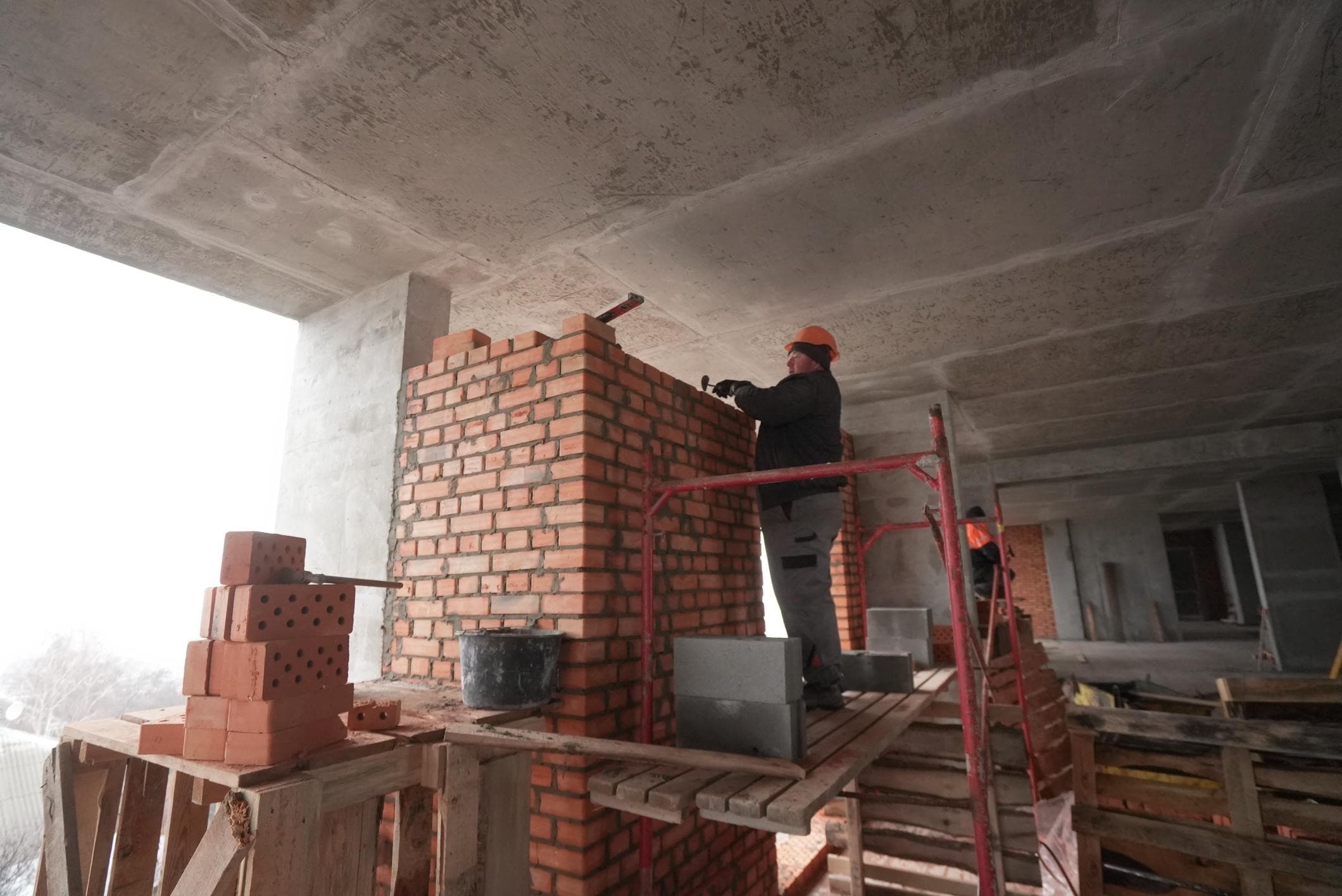

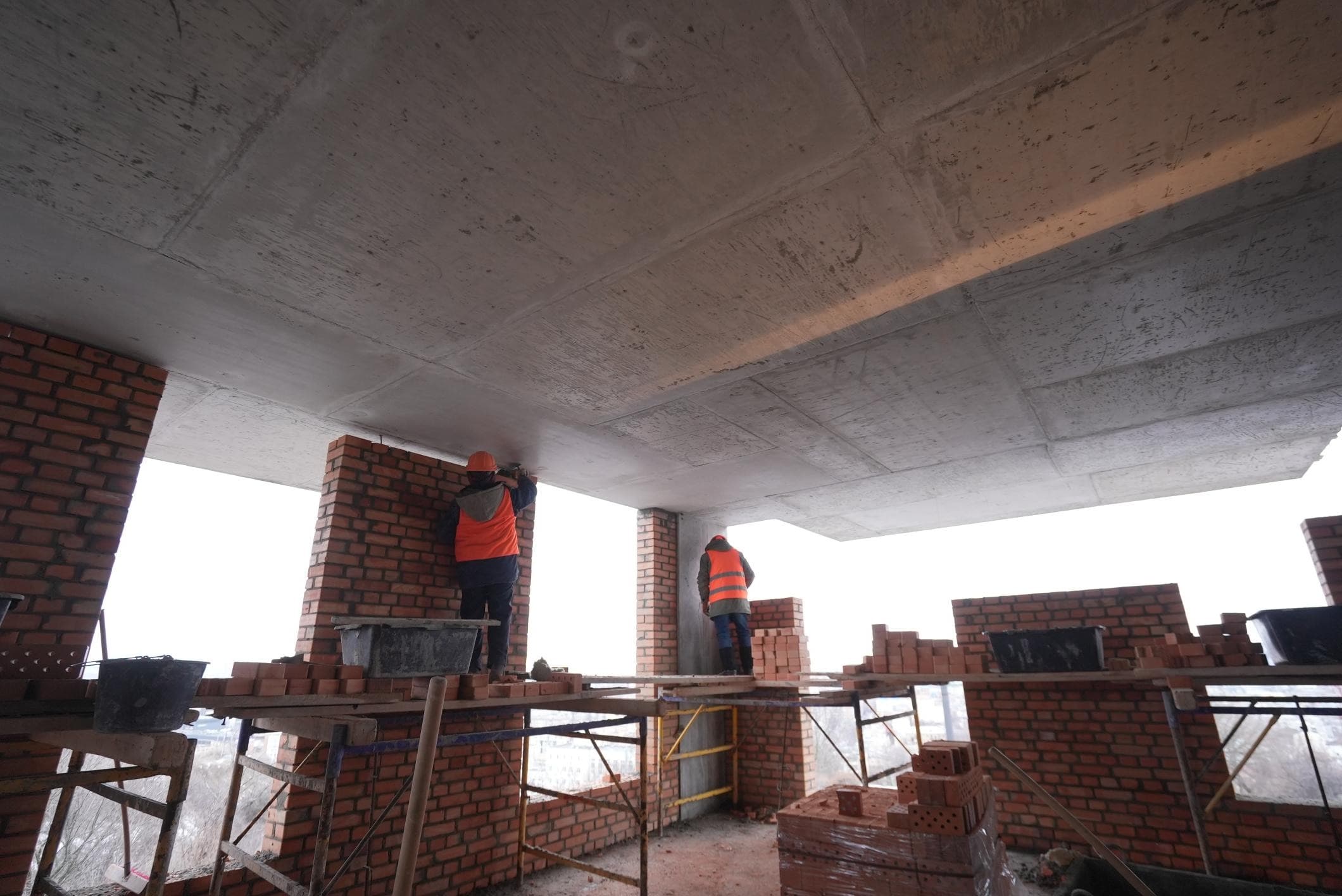

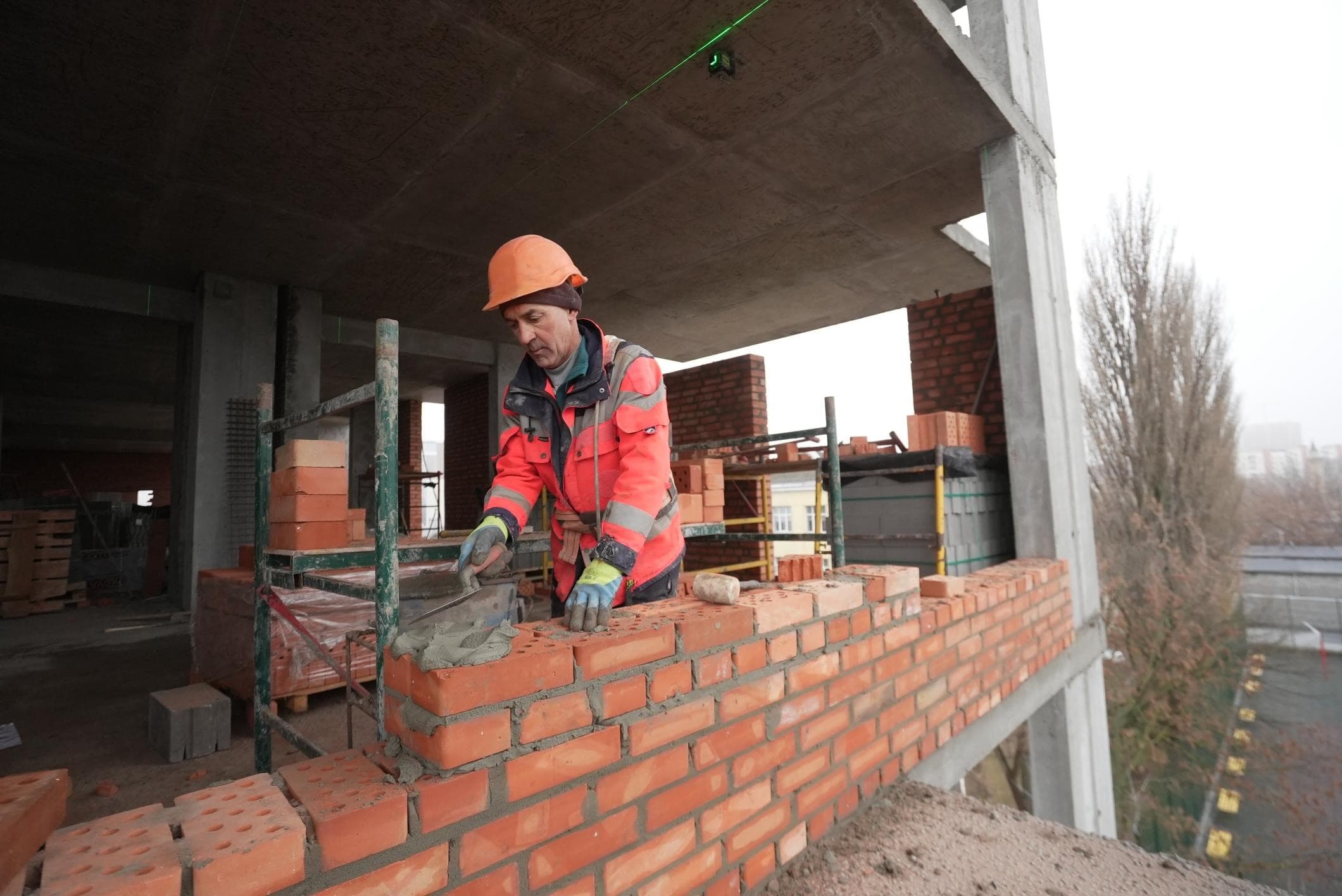

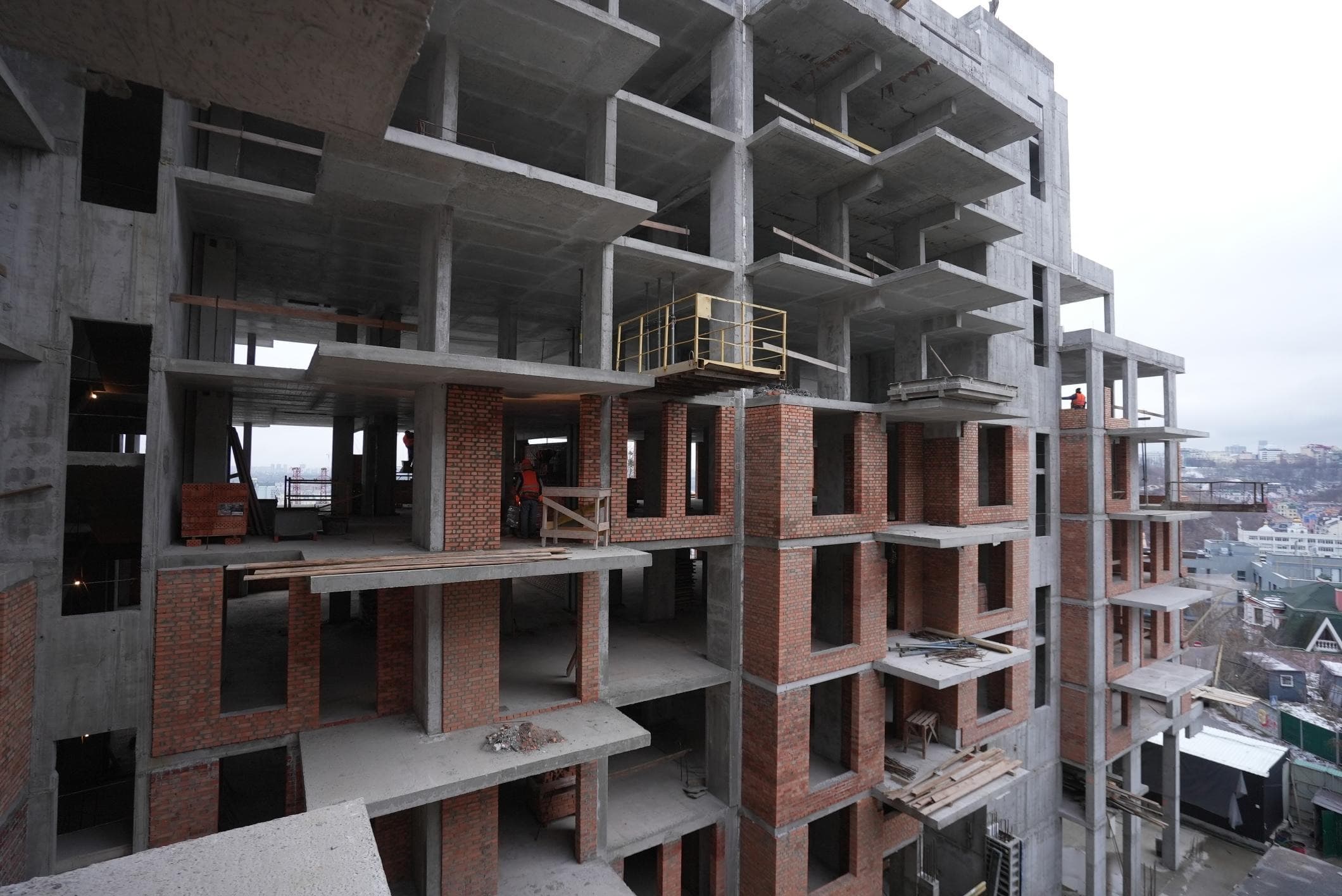

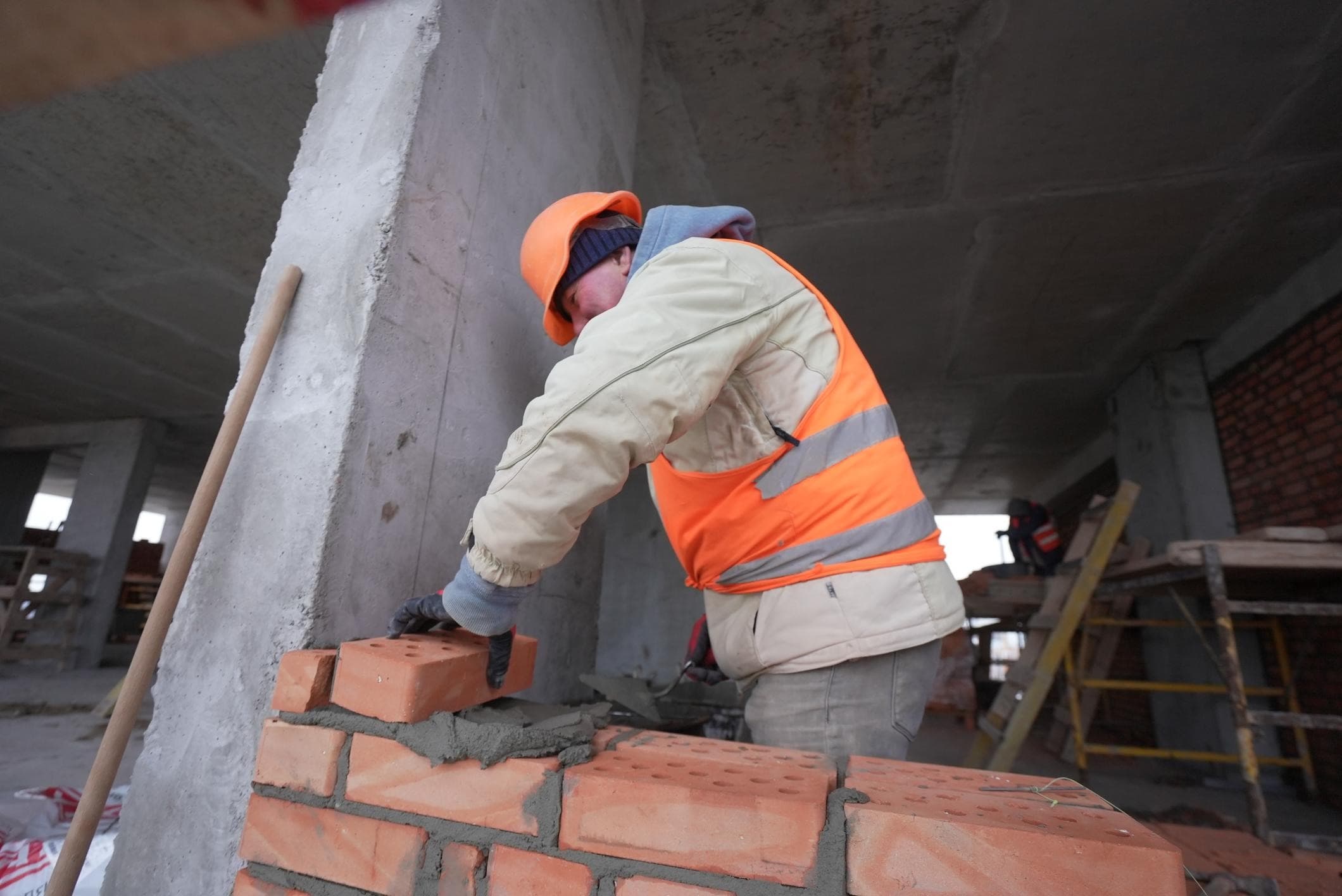

- Window installation 1st and 2nd floor – 75%

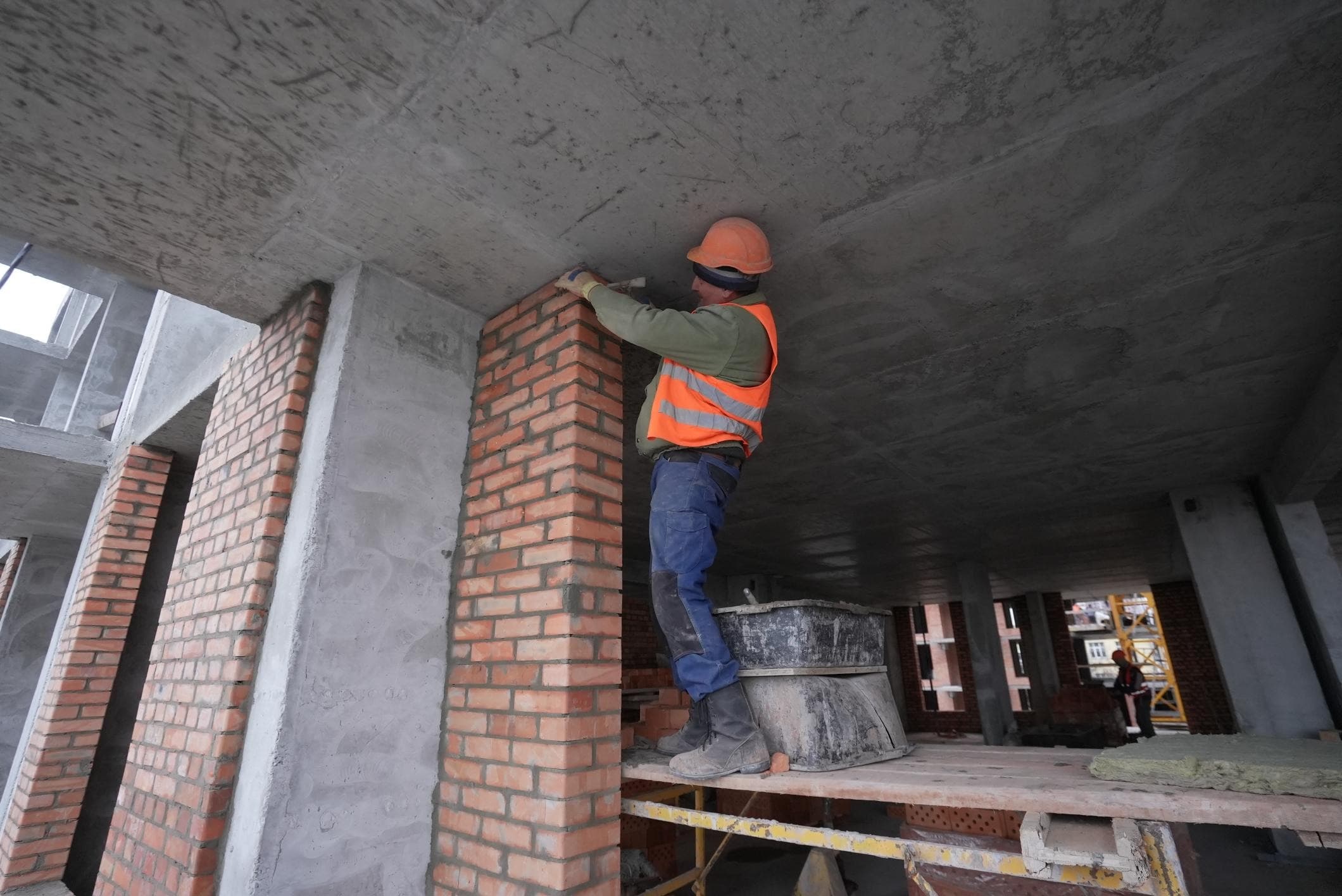

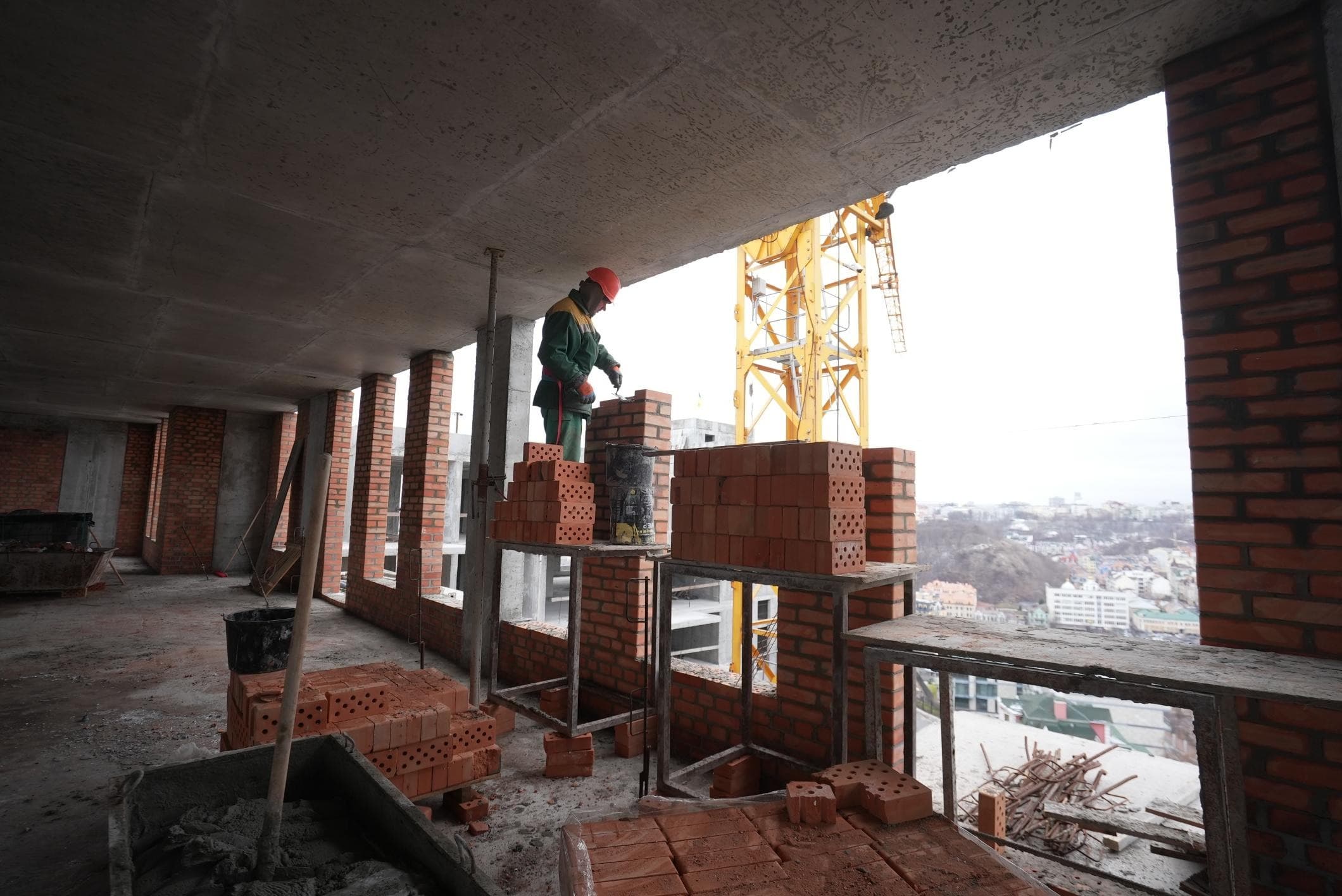

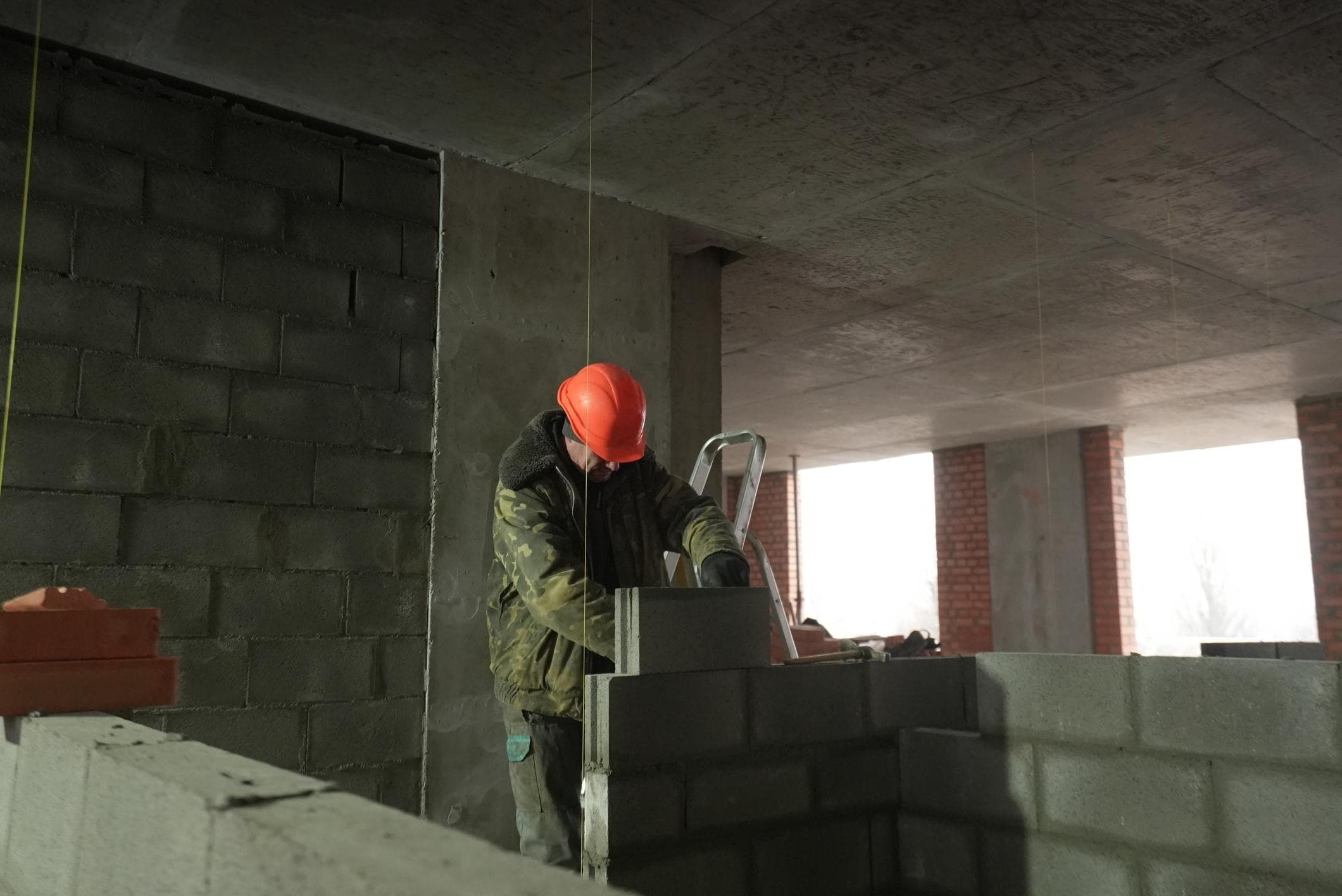

- Masonry of exterior and interior partition walls from 5th to 7th floor – 75%, 8th floor – 90%
Section 2:
- Masonry of exterior and interior partition walls from 5th to 6th floor – 45%
Section 3:

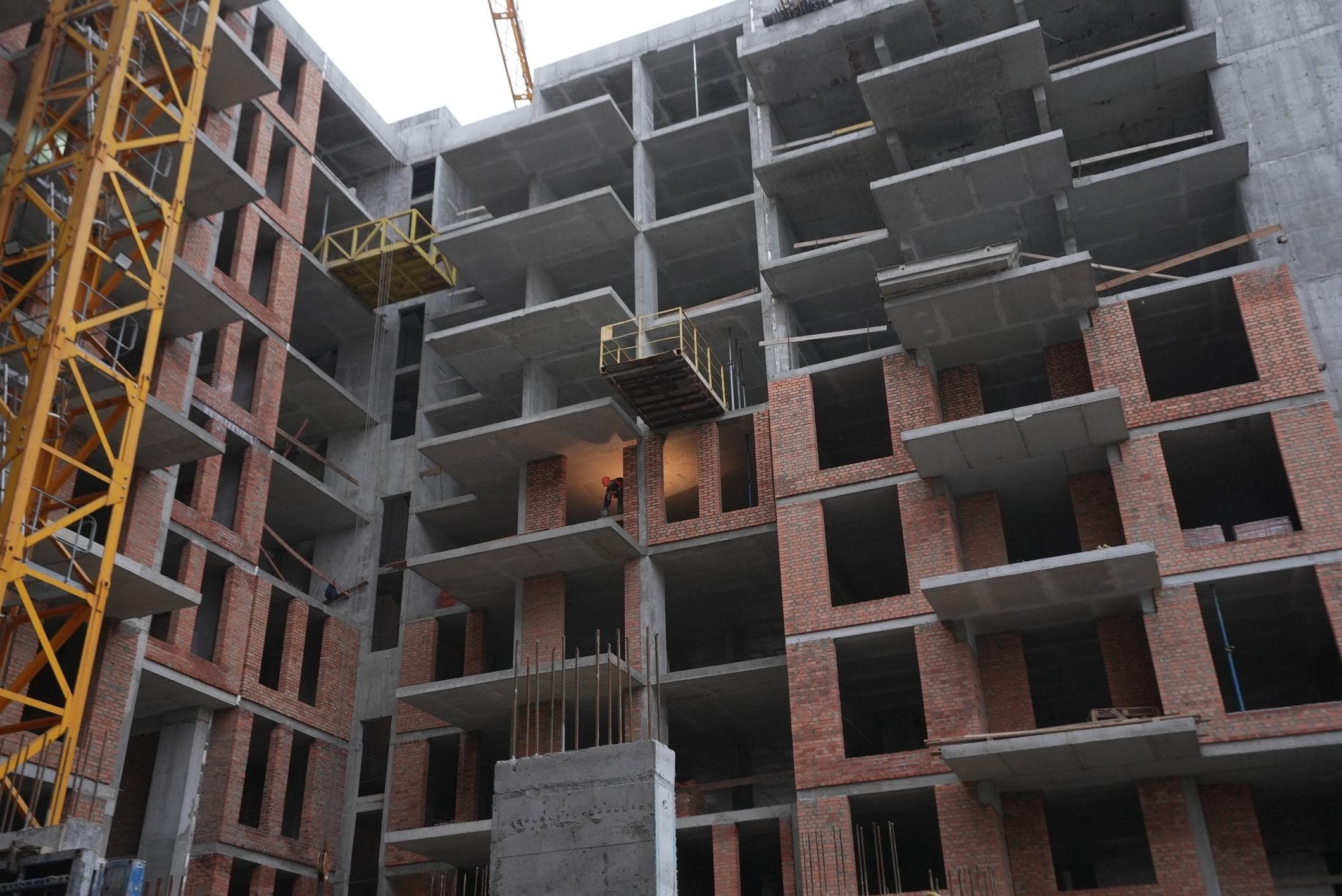

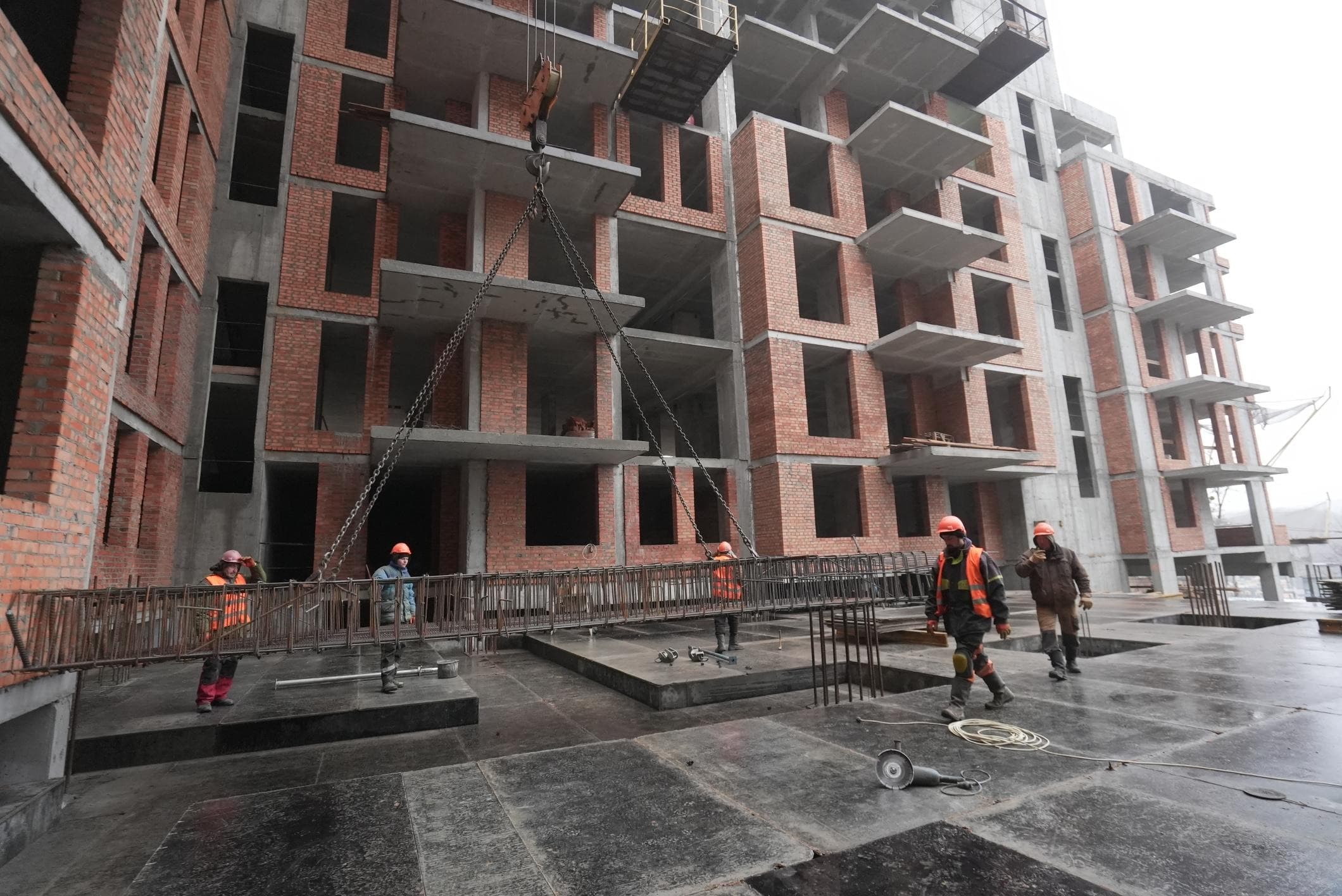

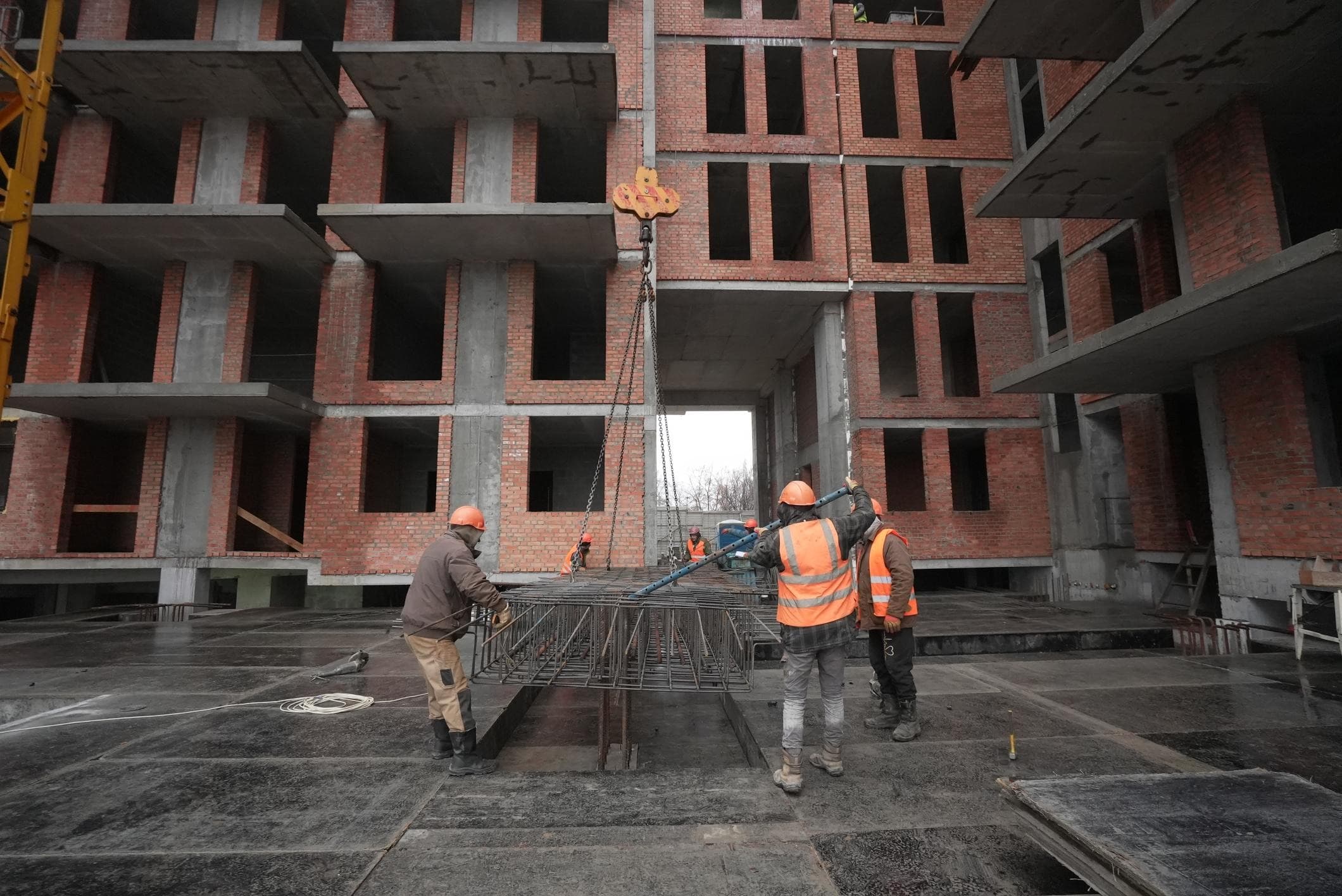

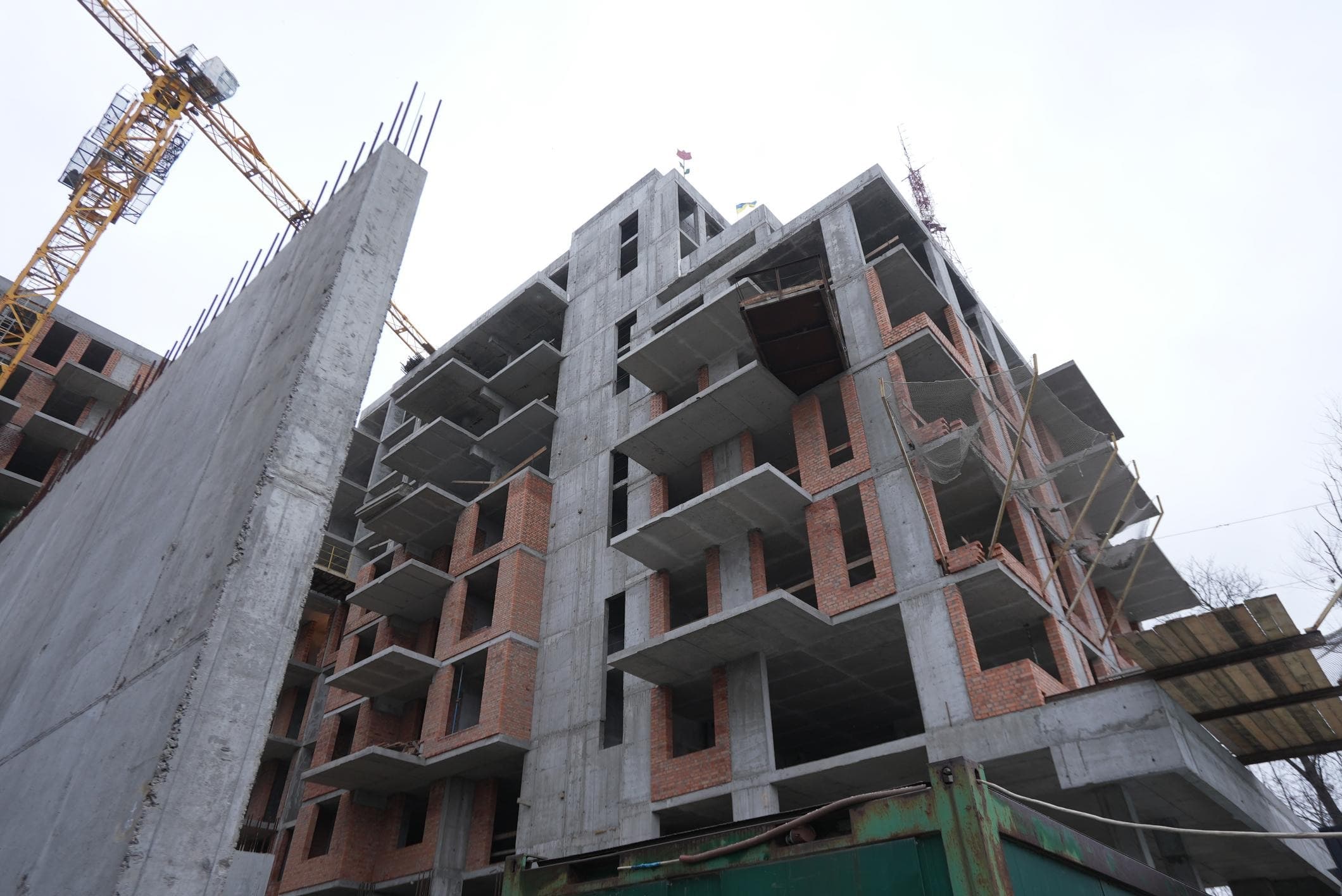

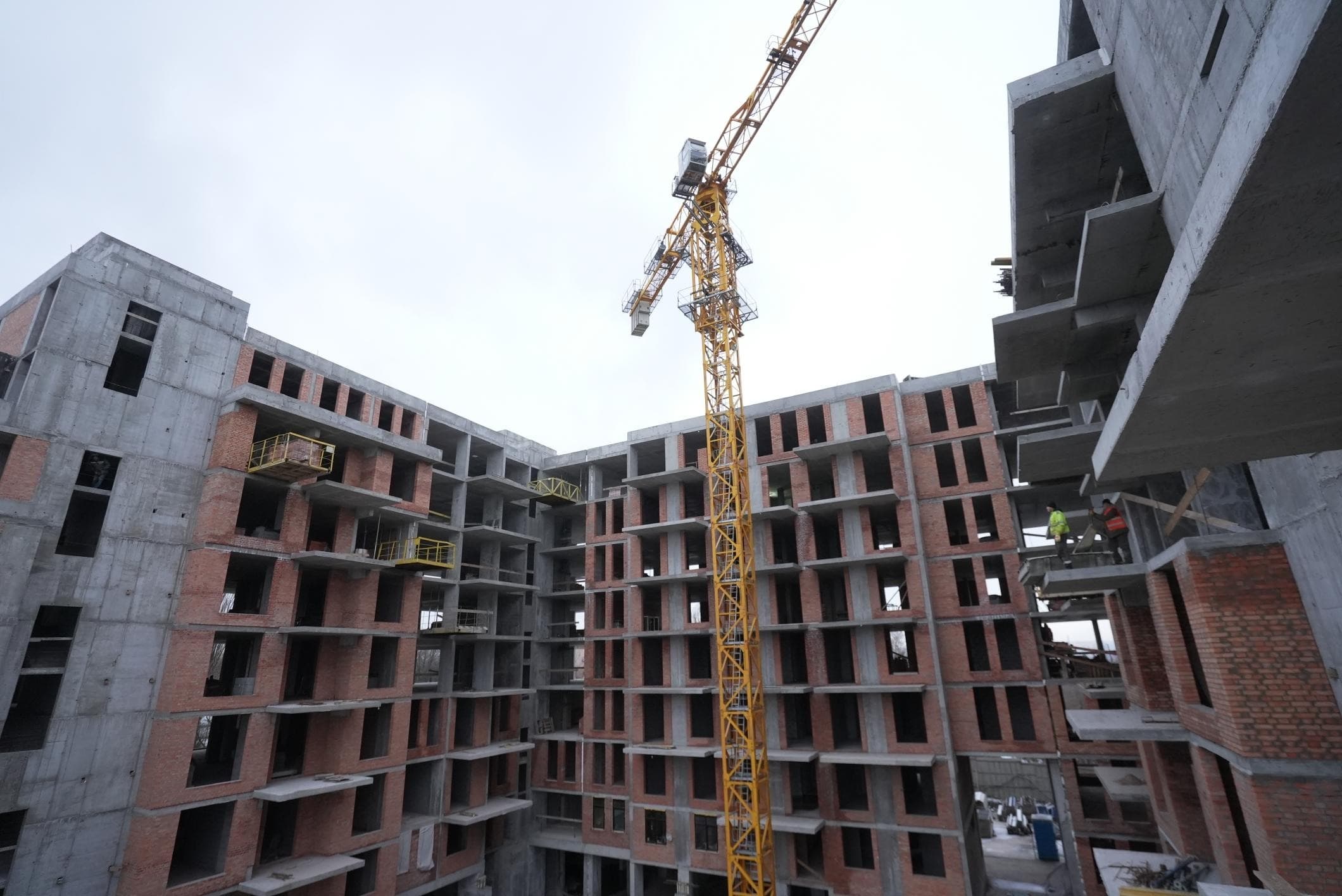

- Masonry of exterior and interior partition walls 5th floor – 85%, 6th floor – 80%, 7th-8th floor – 75%
Section 4:
- Masonry of exterior and interior walls from 4th to 6th floor – 50%
Section 5:
- Masonry of exterior and interior walls from 4th to 6th floor – 50%

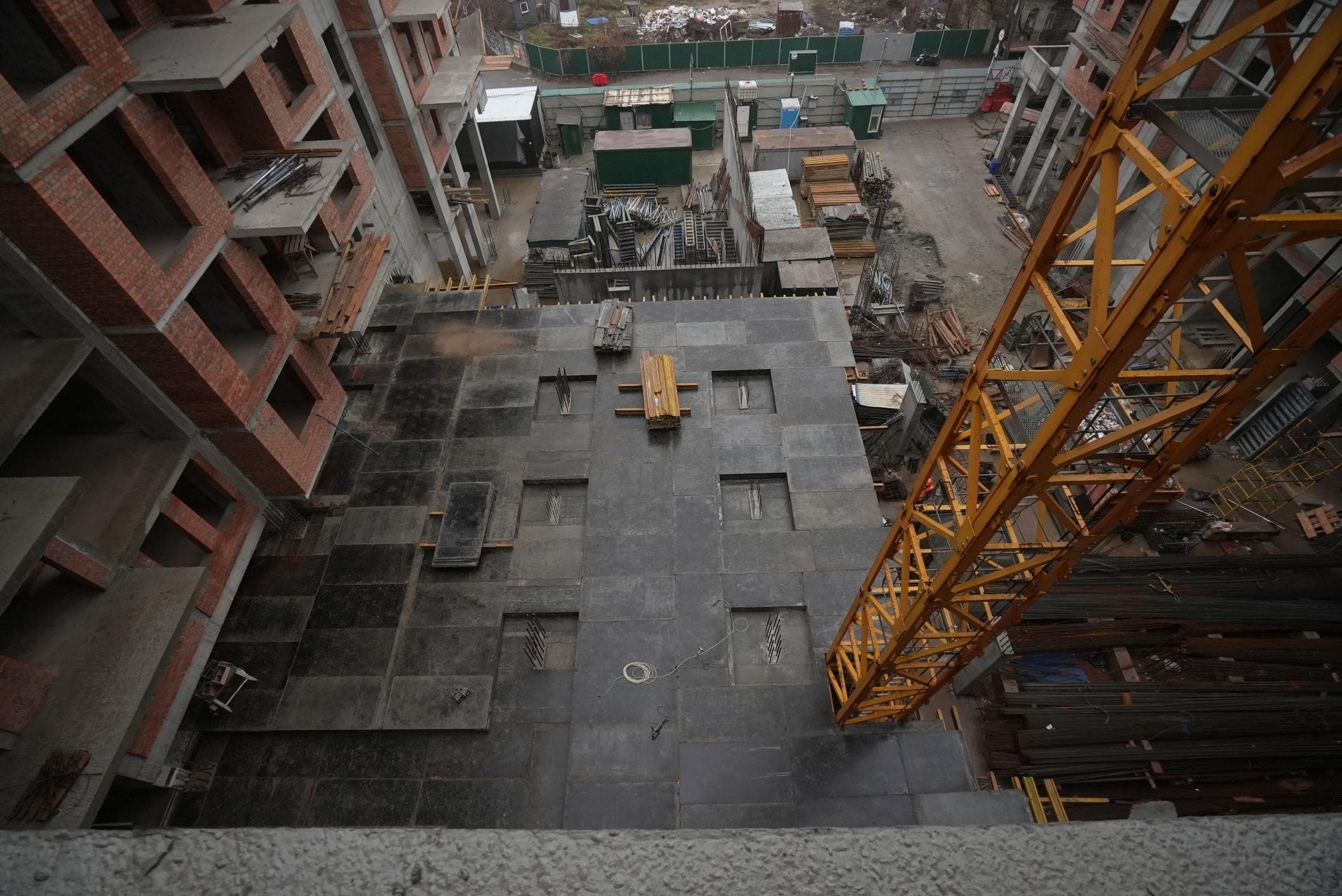

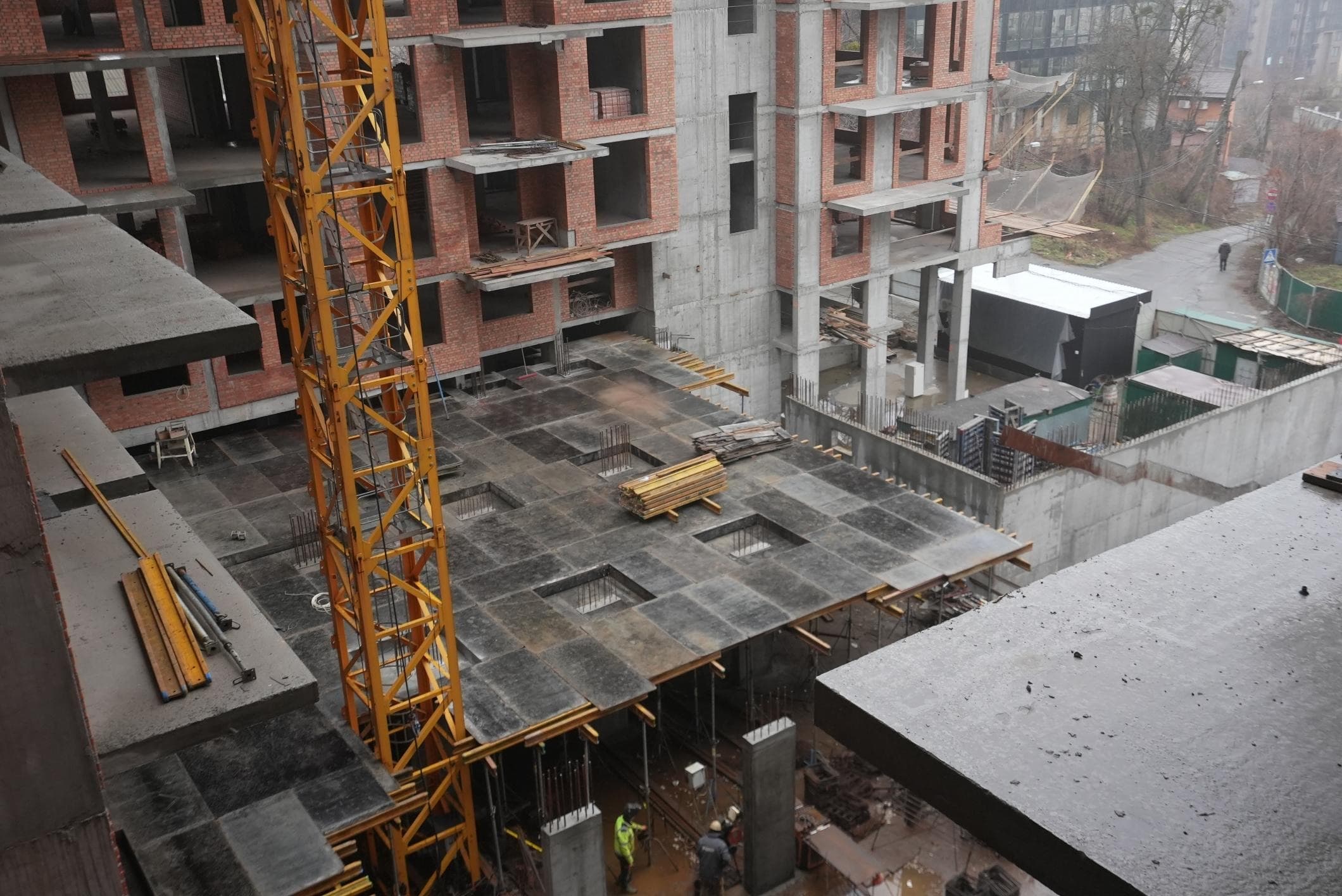

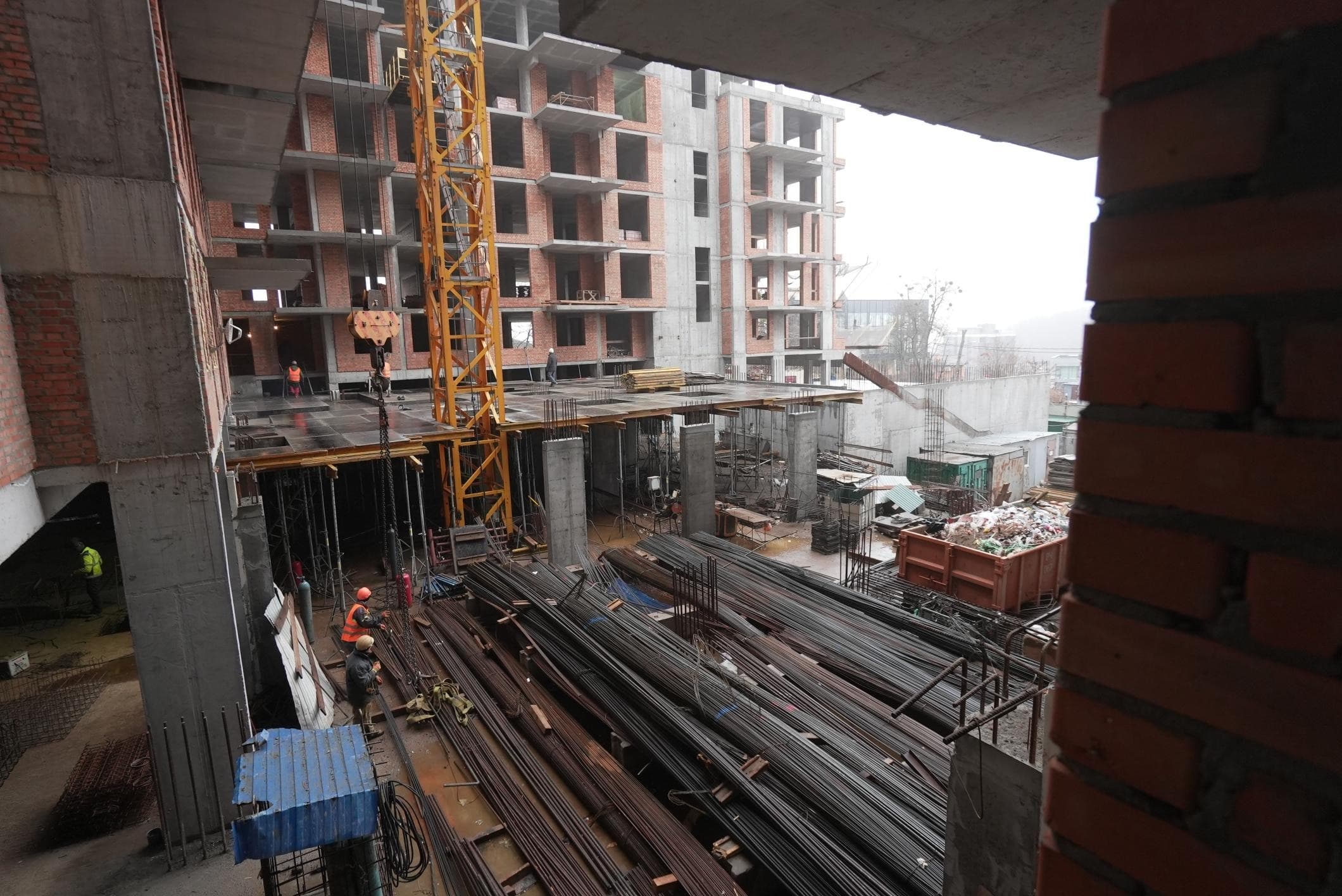

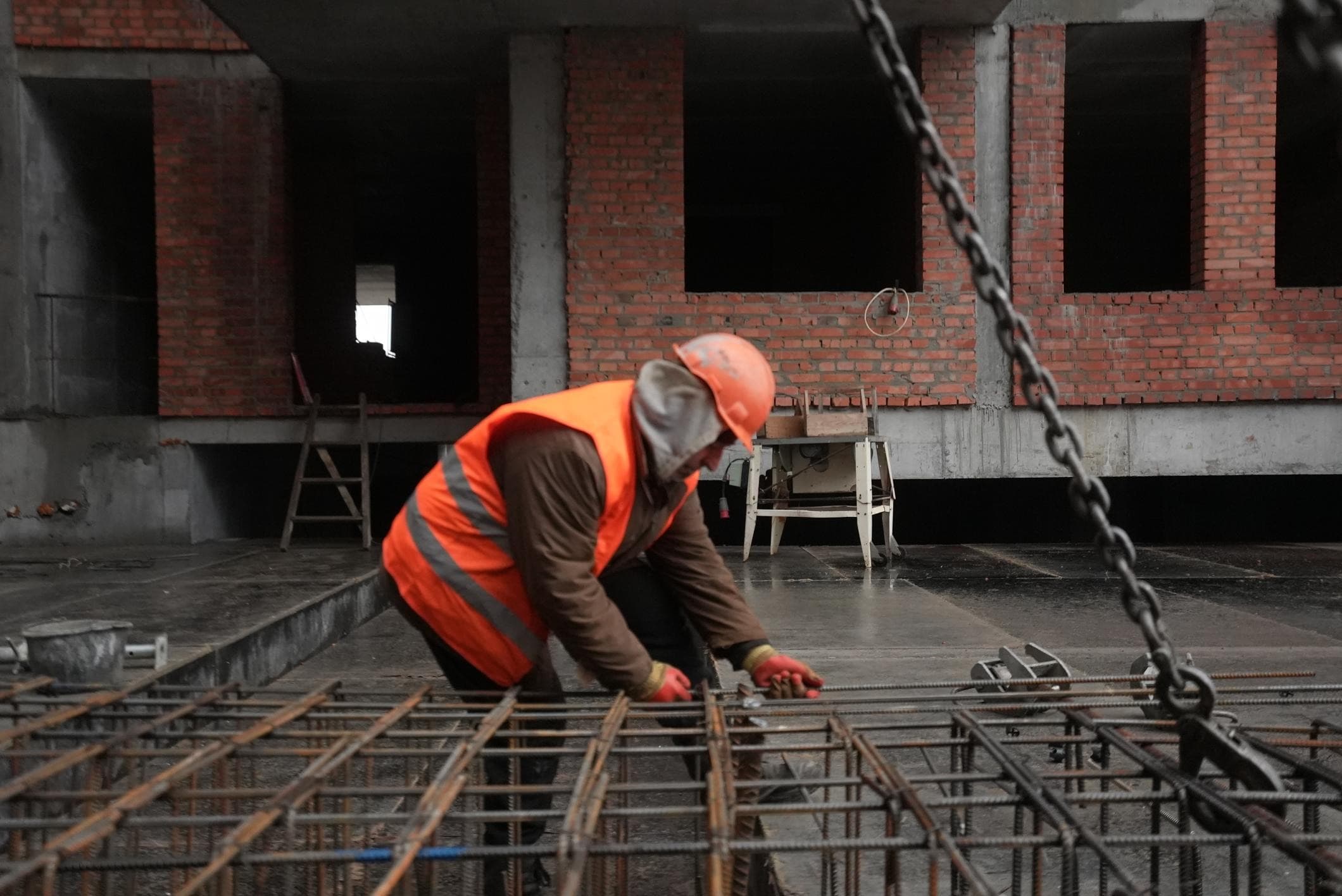

Parking (1 zone):
- Installation of the covering slab – 25%
