Olegivskiy residens logo
Share

Construction progress for November 2025

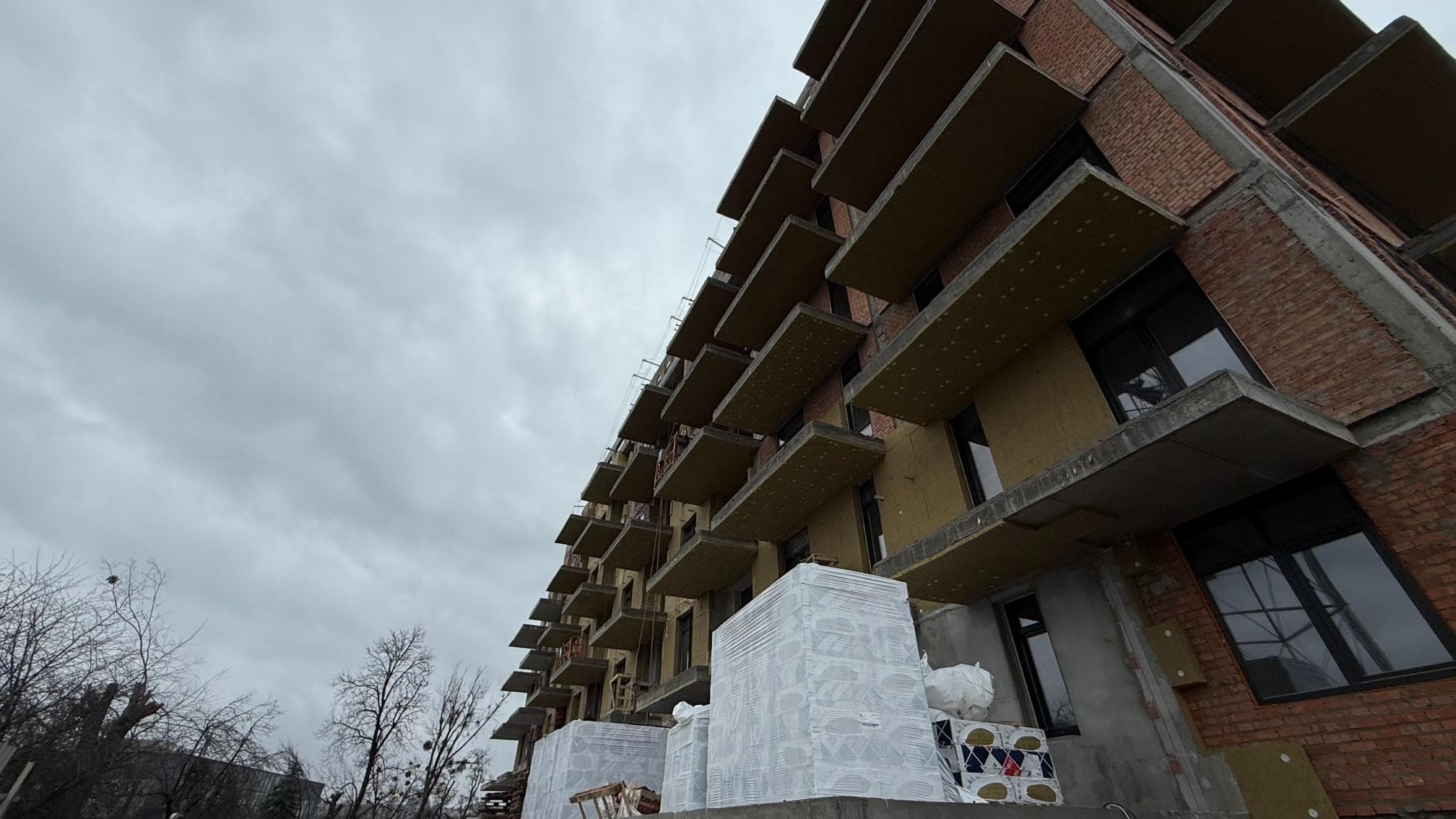

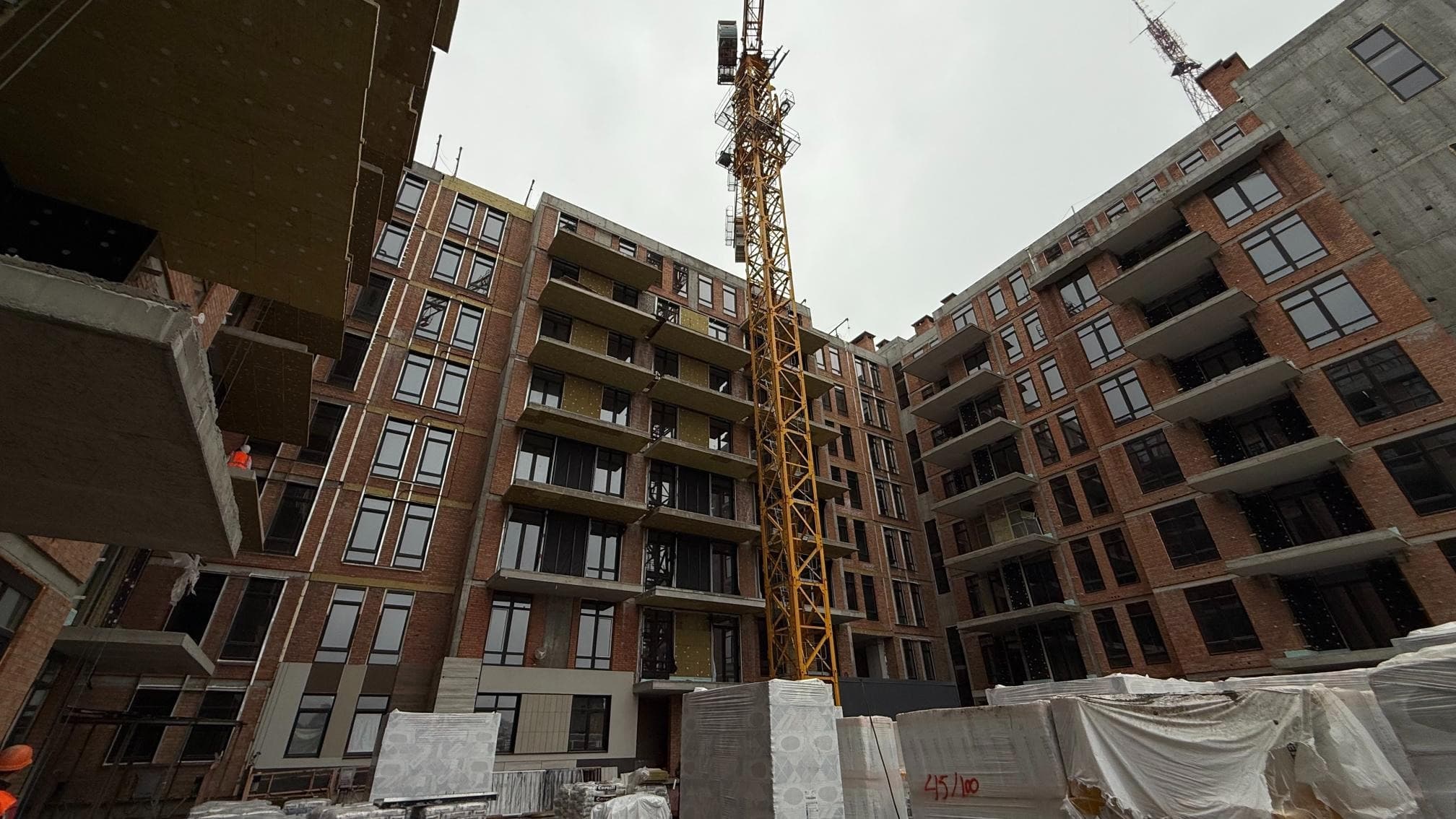

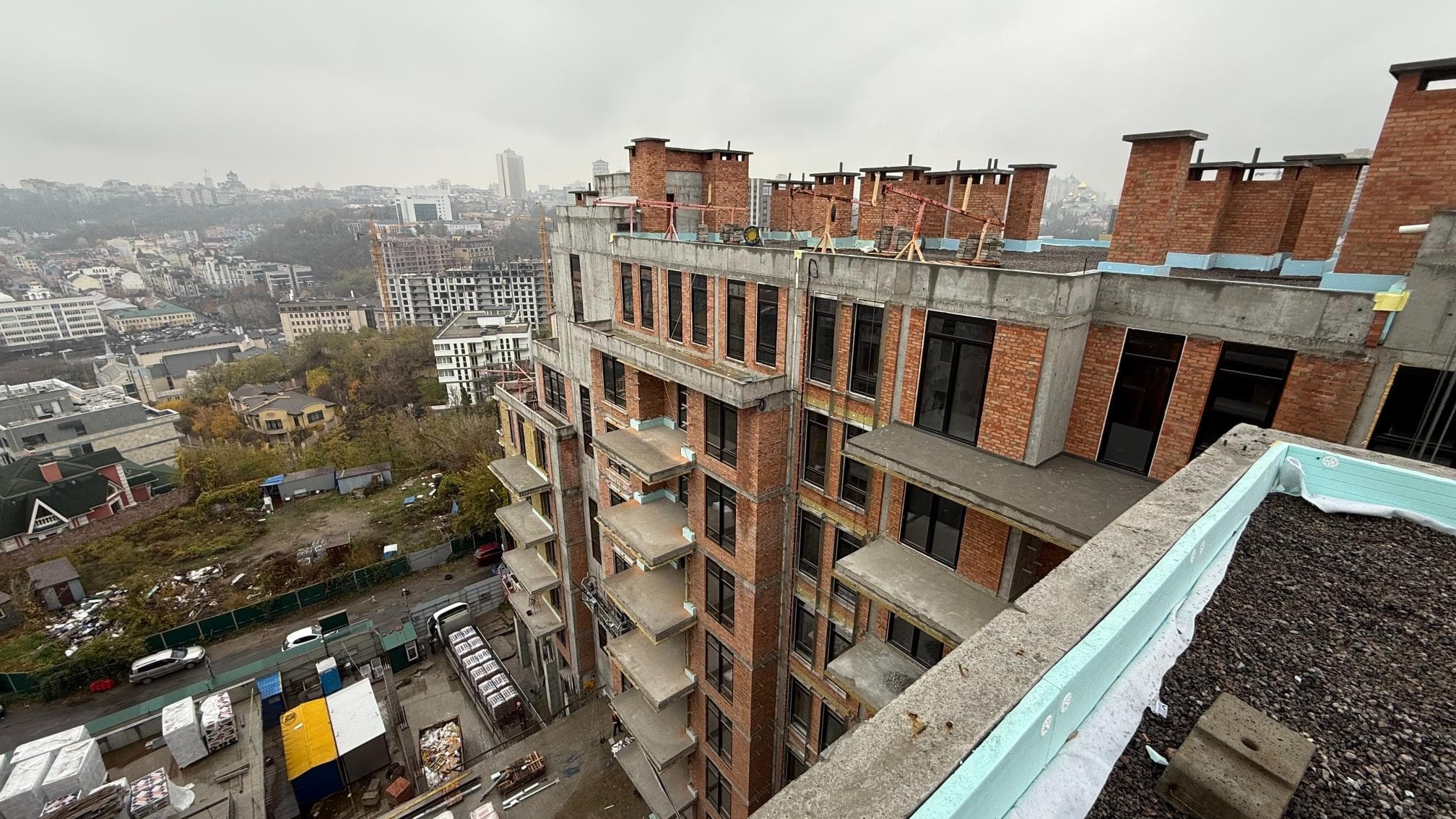

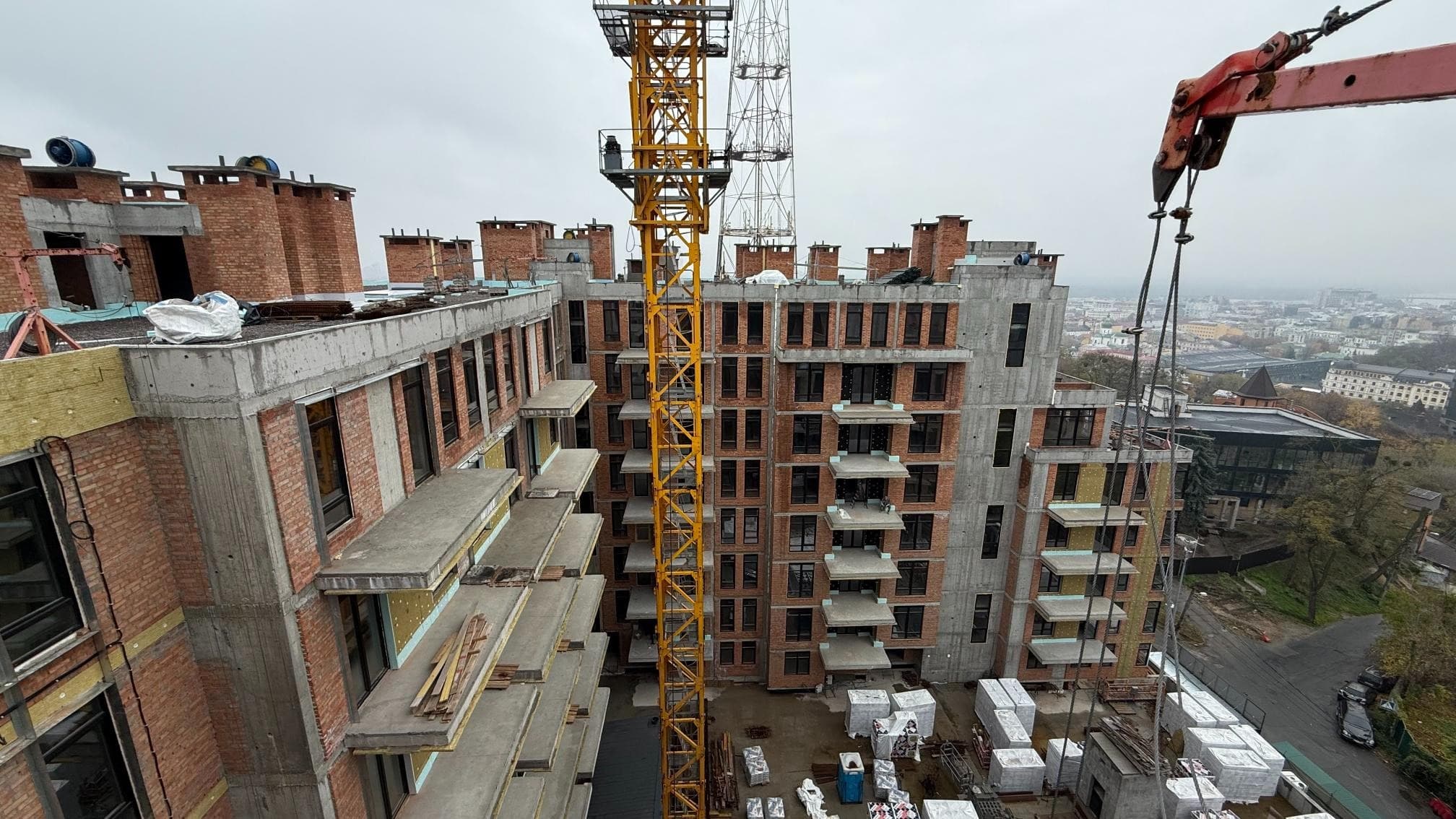

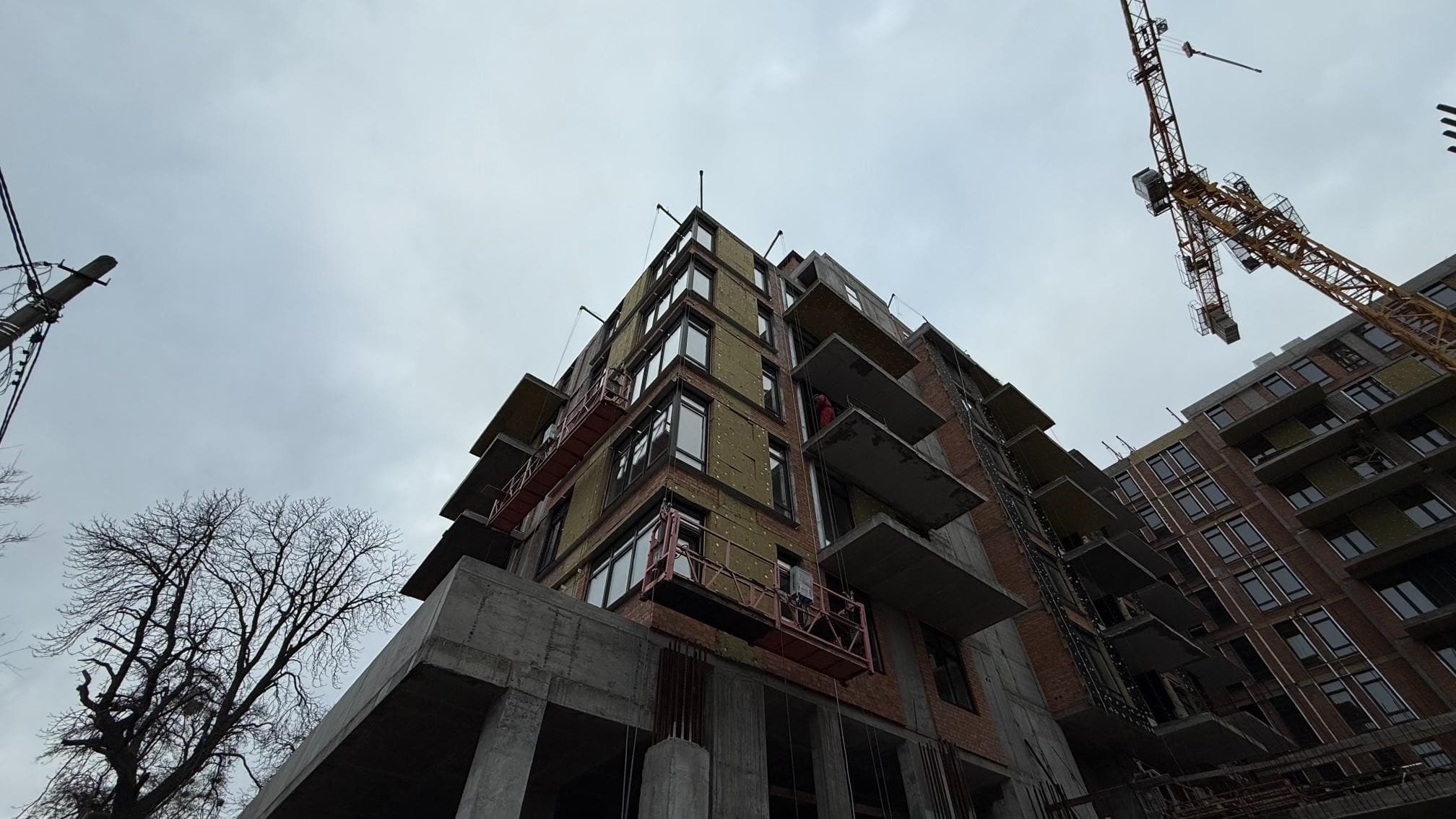

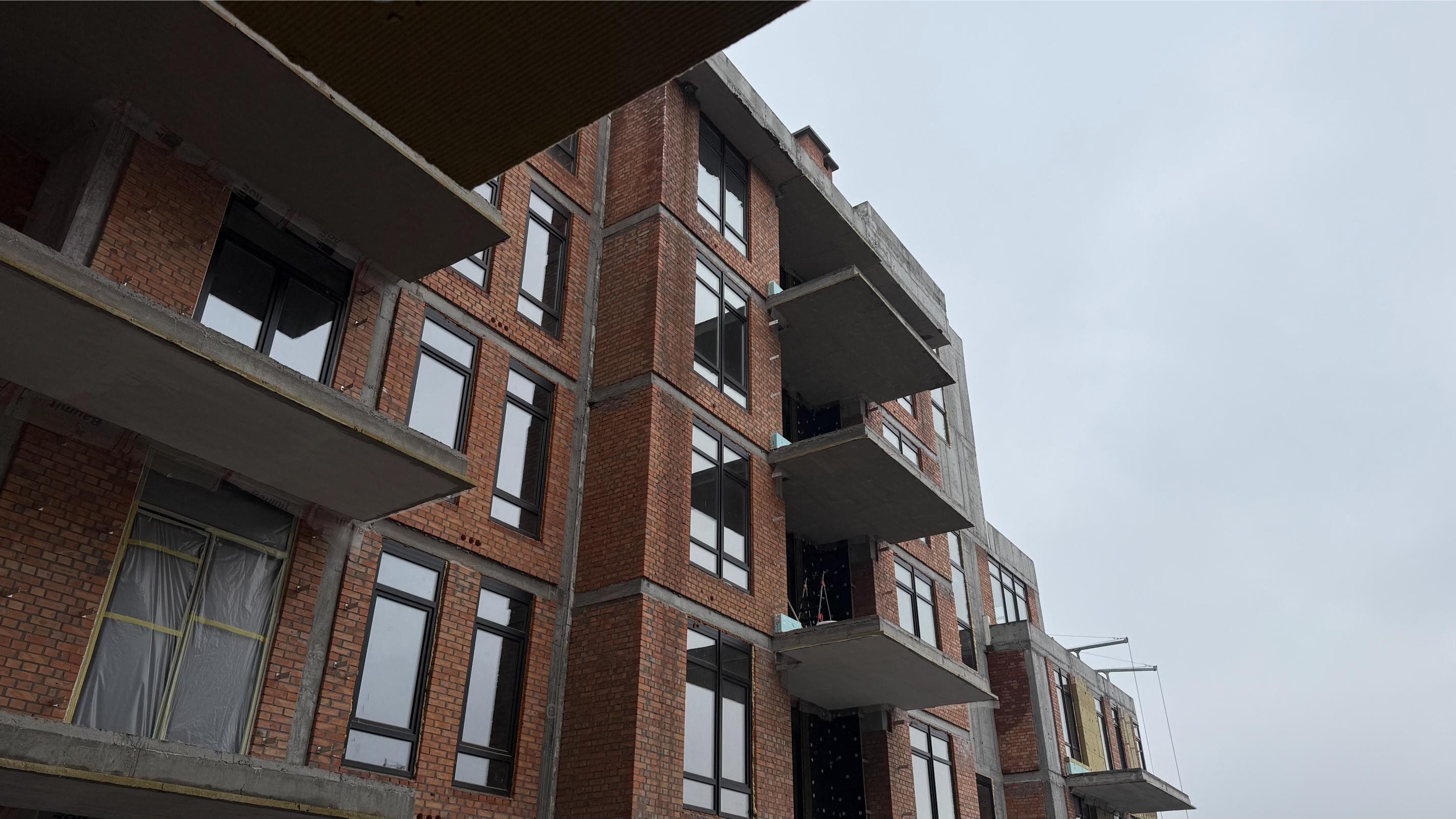

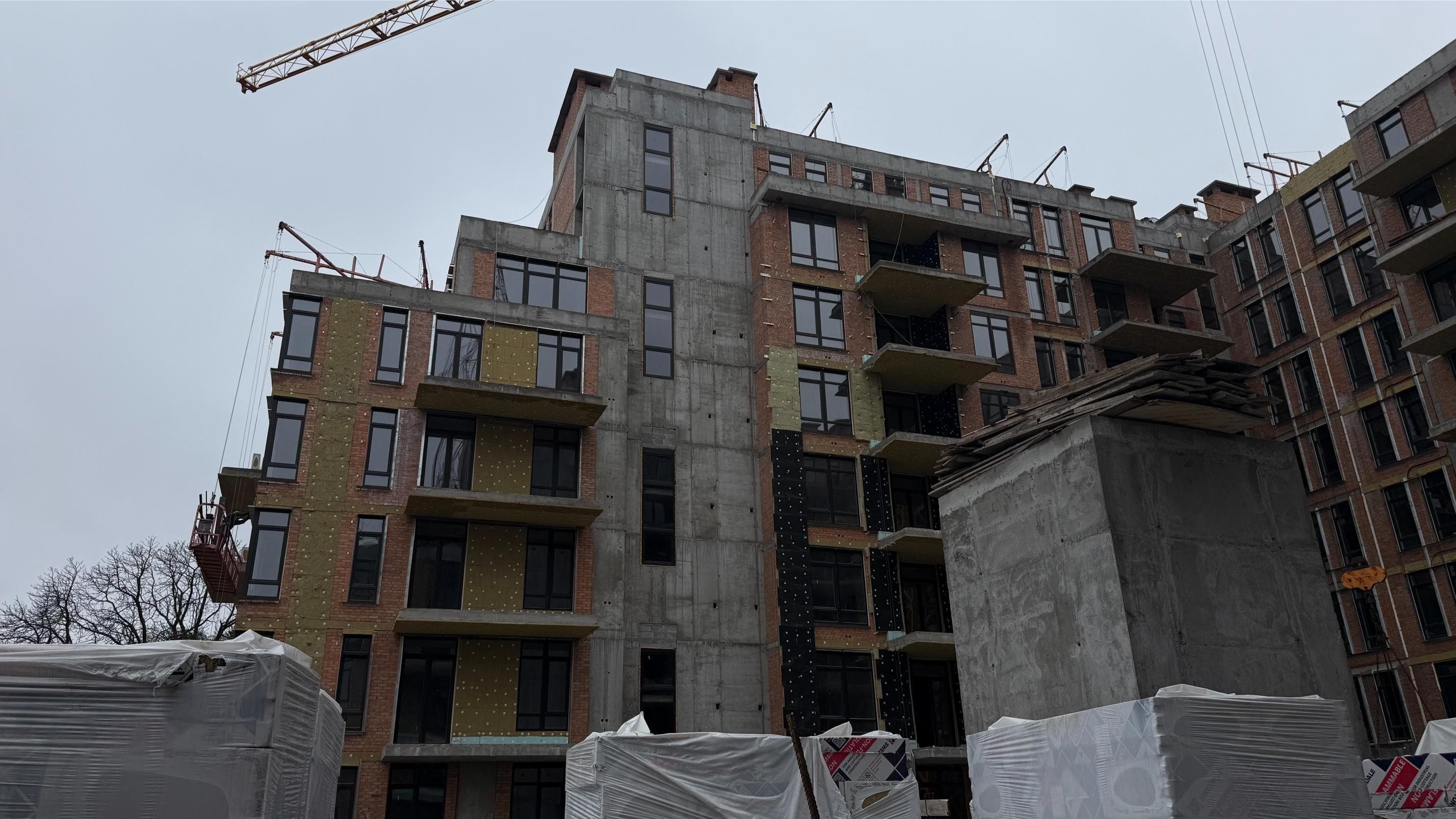

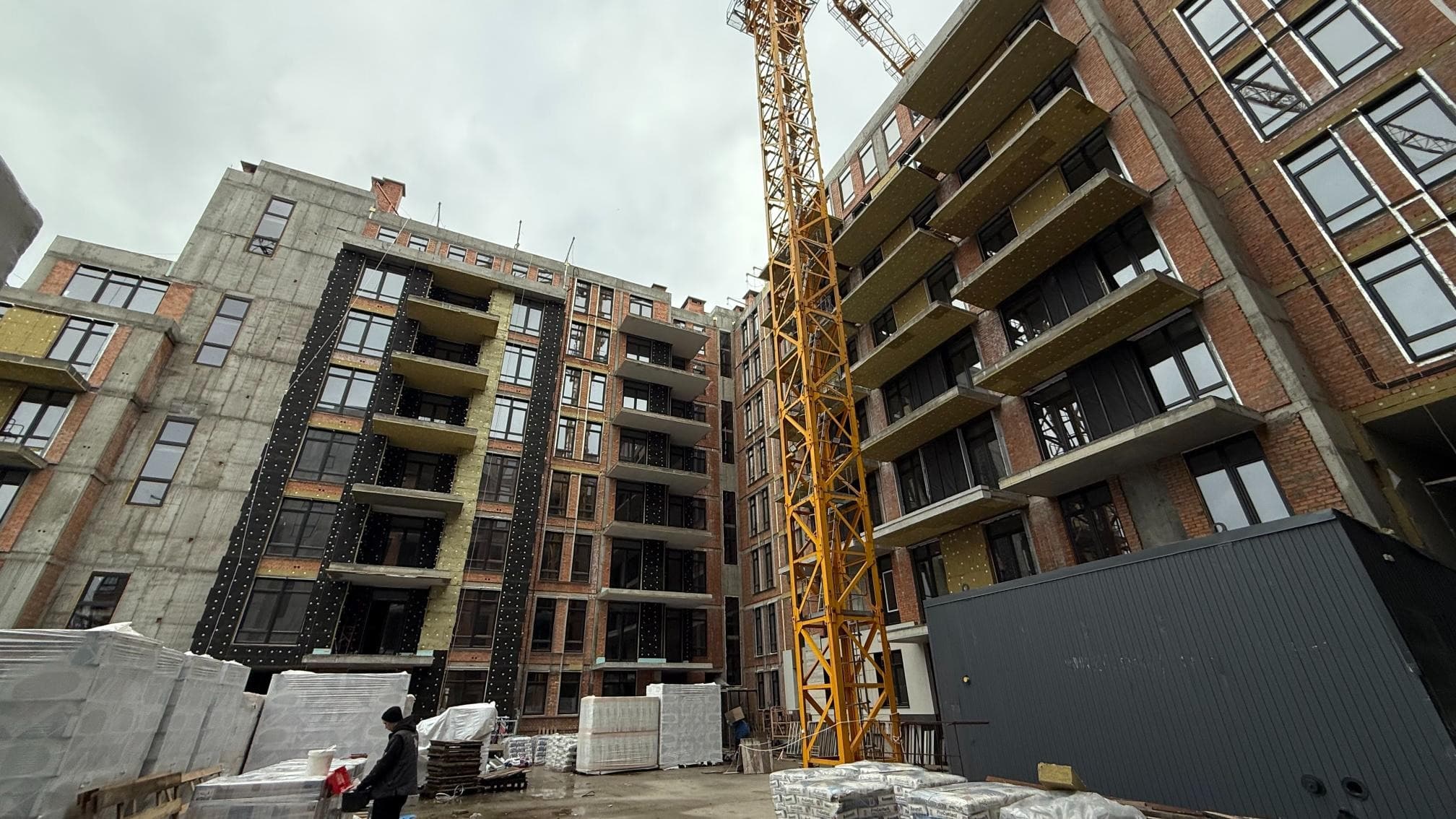

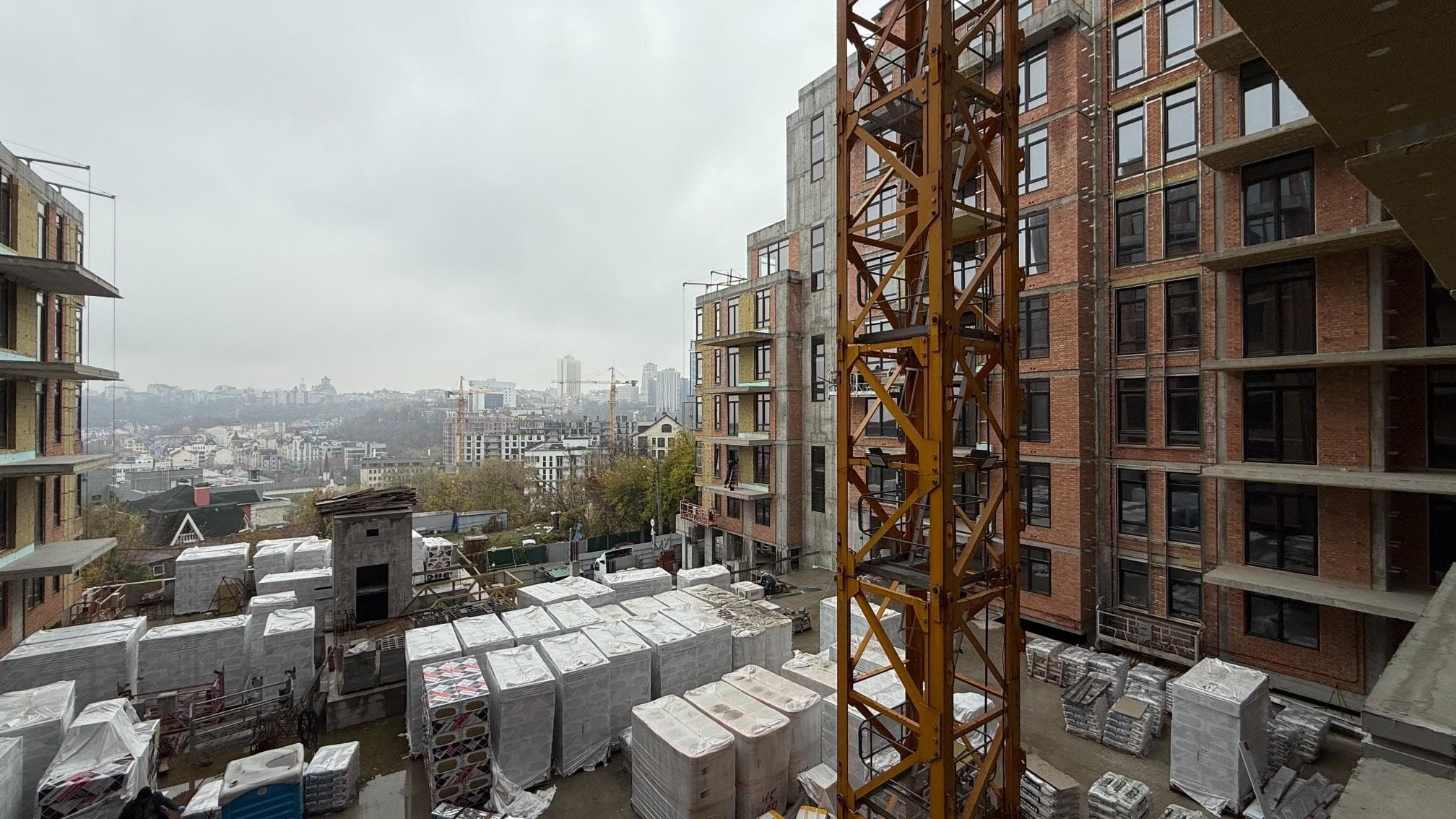

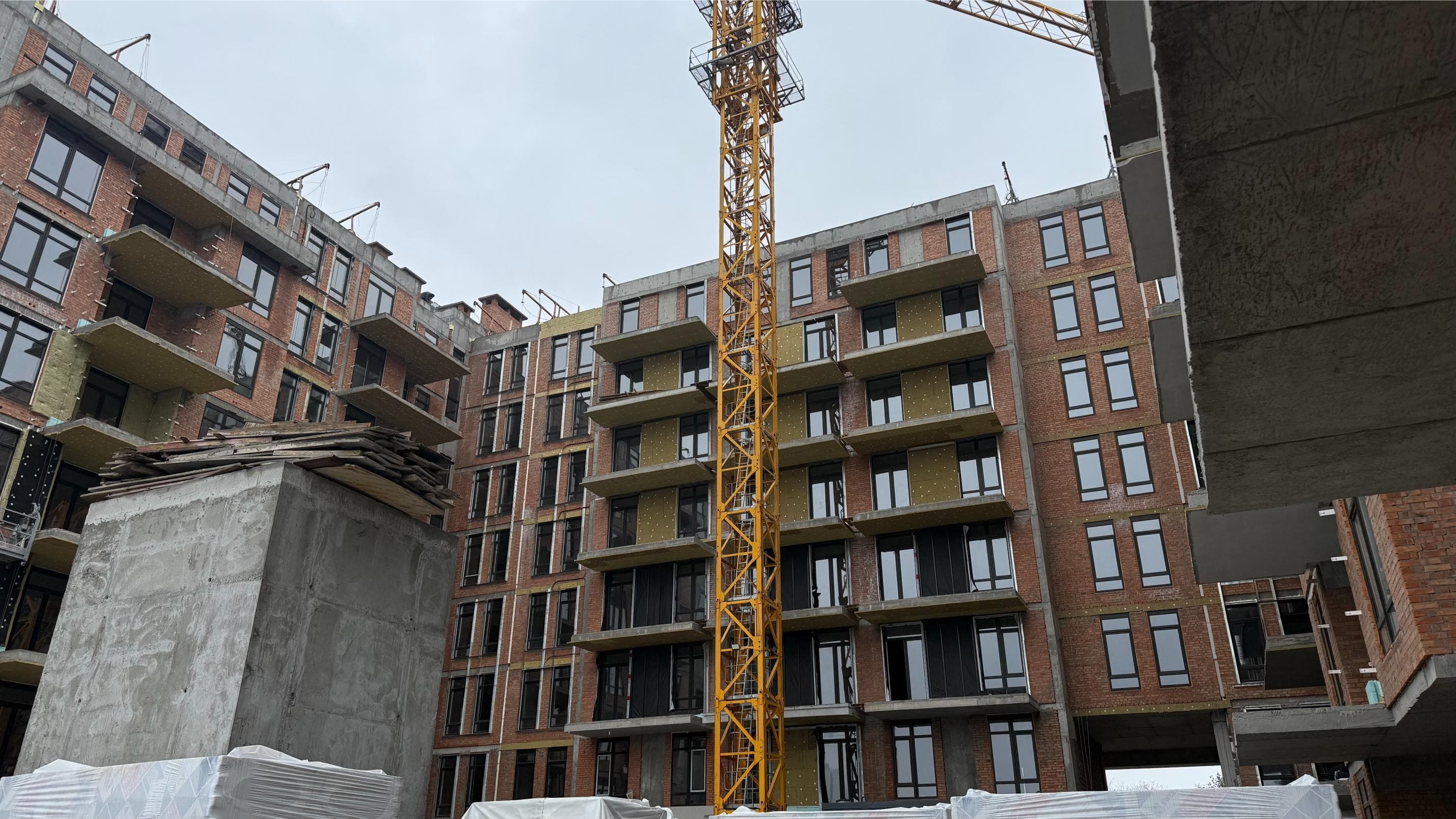

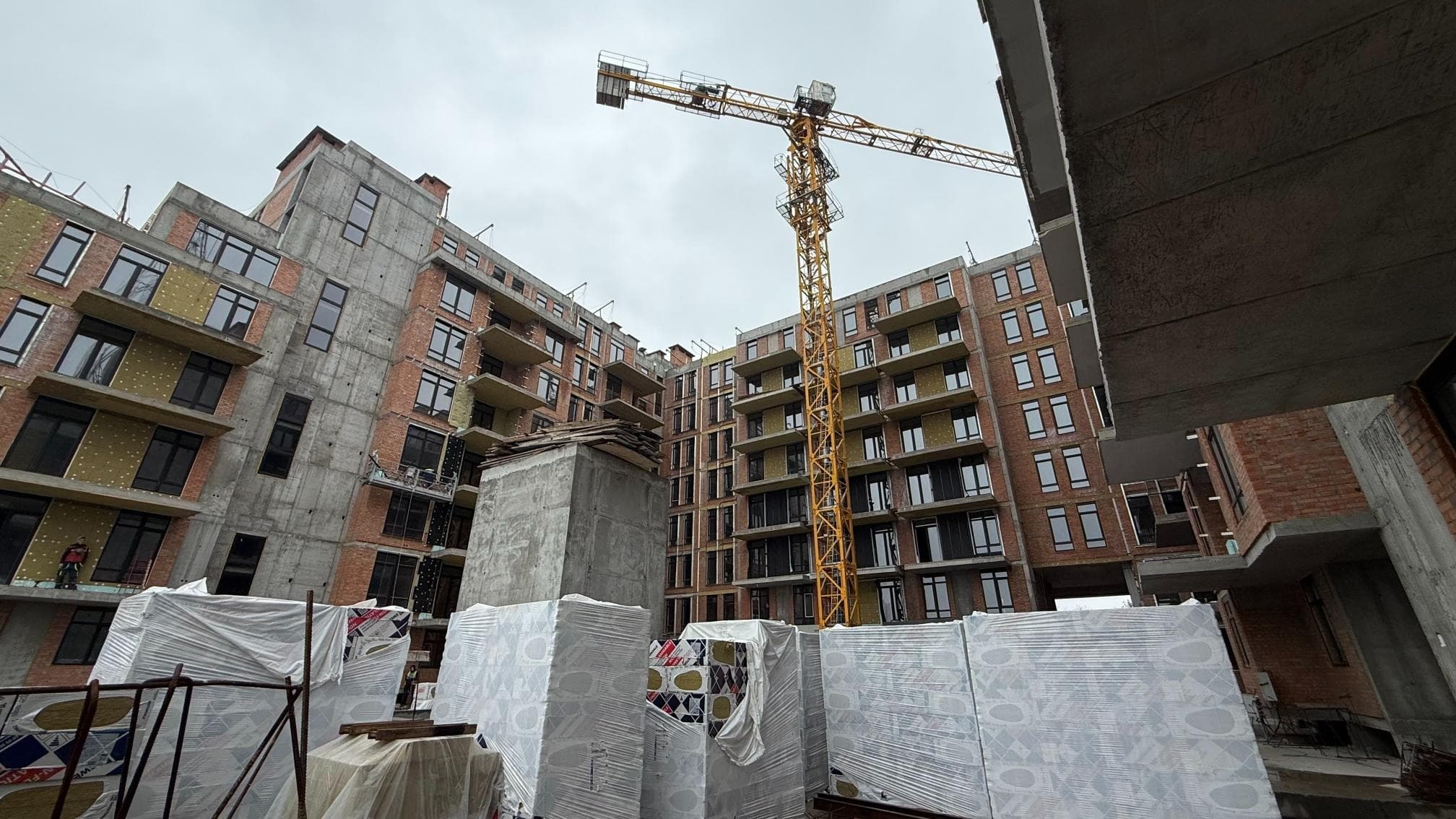

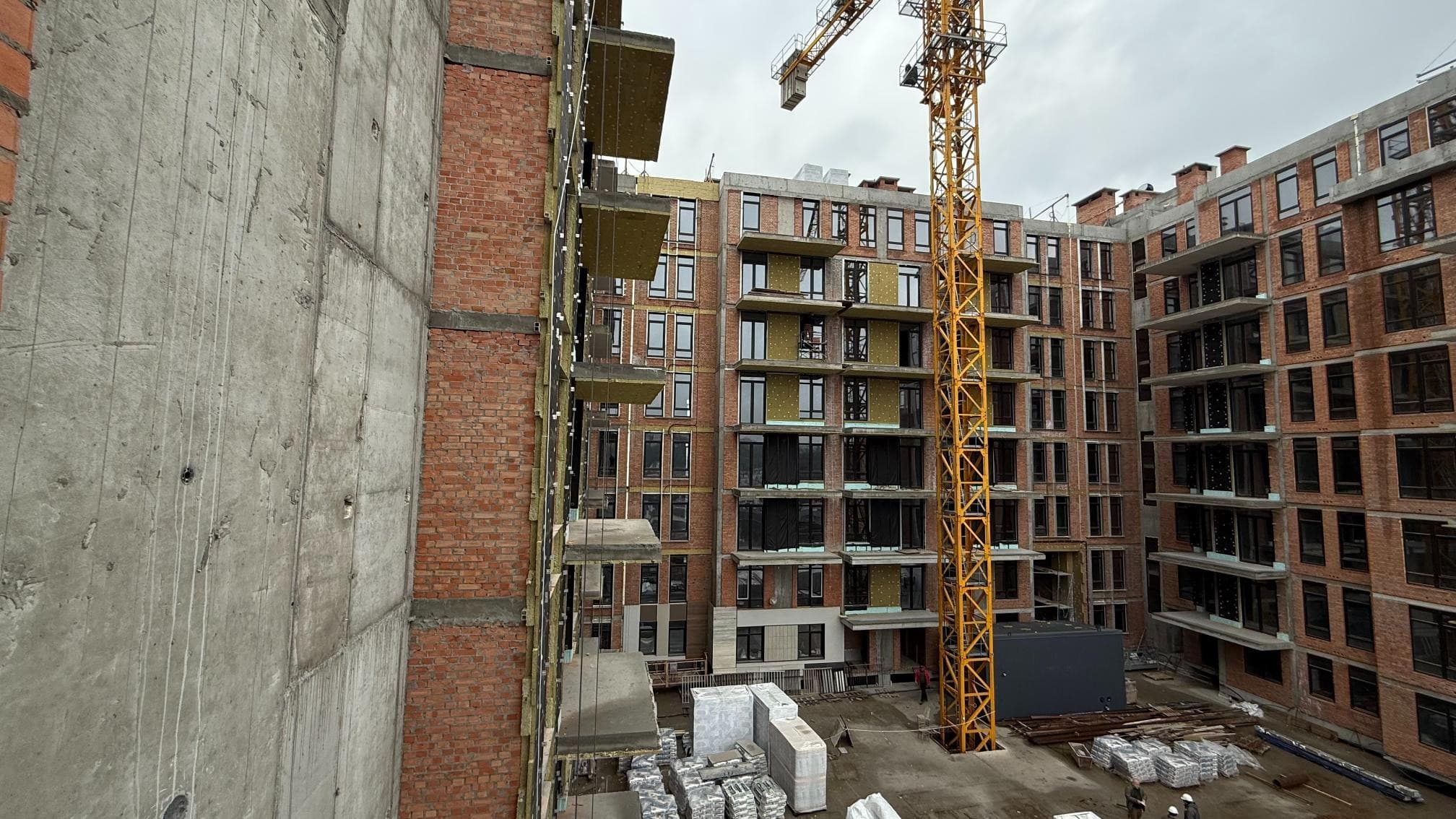

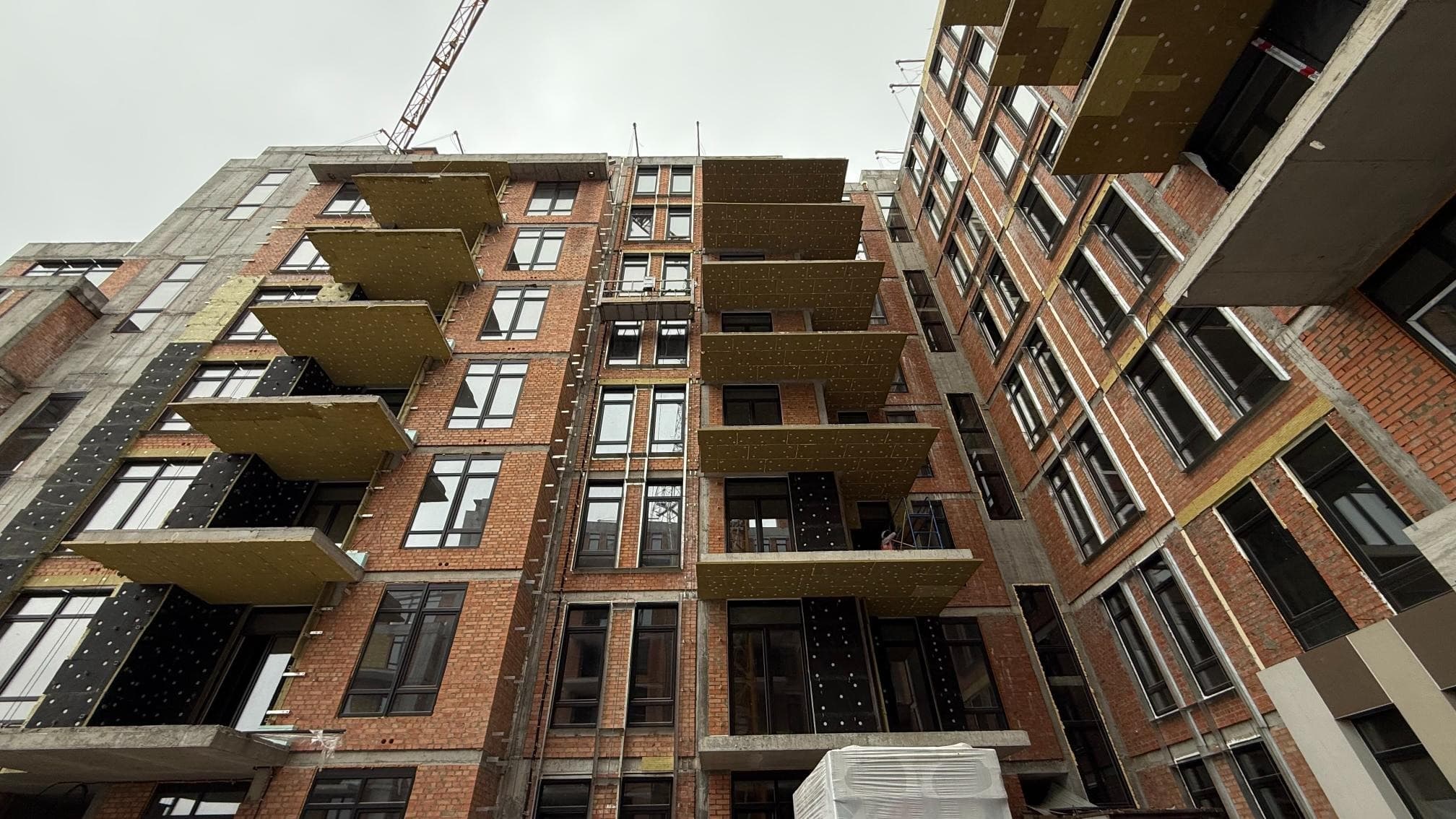

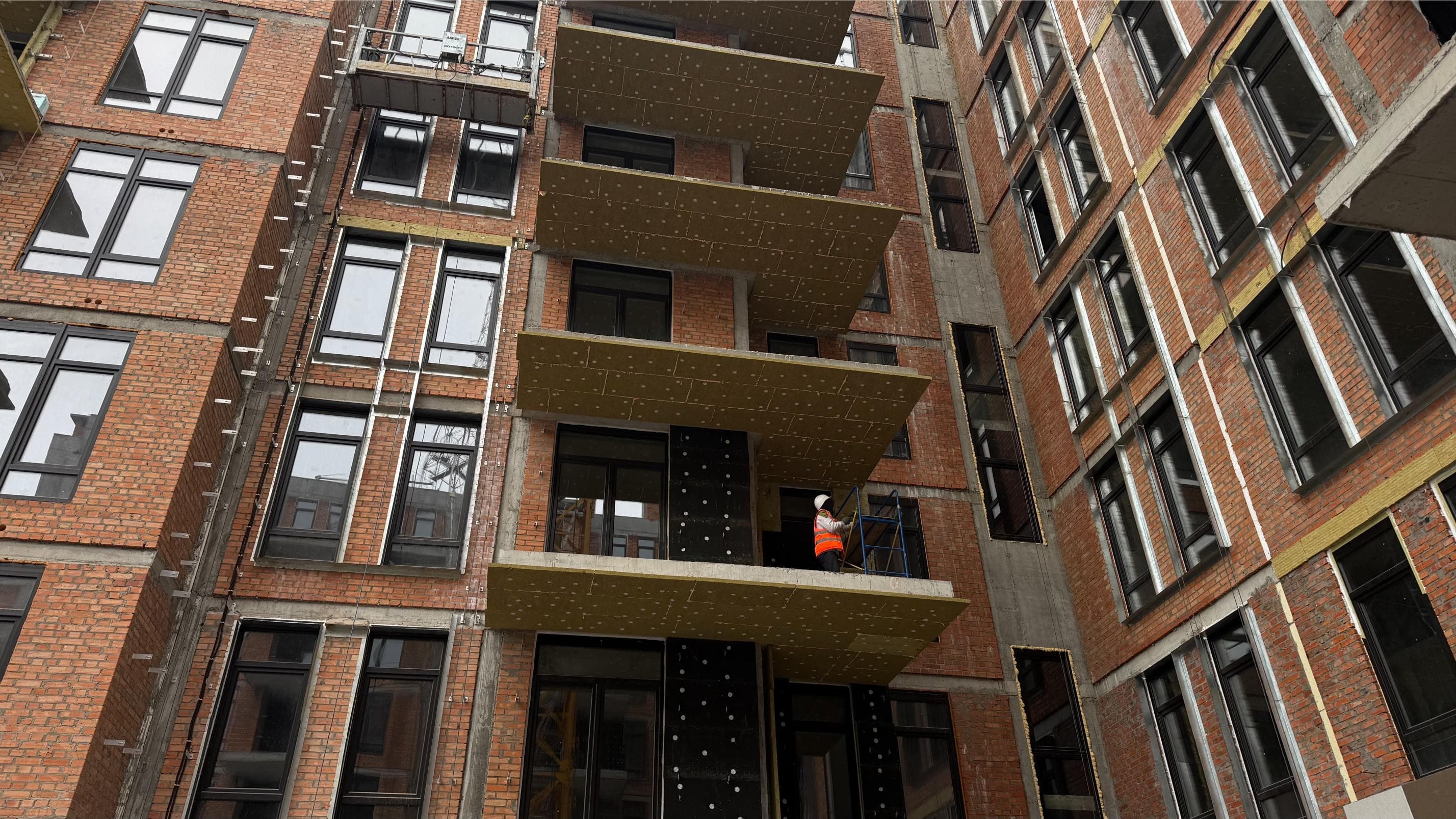

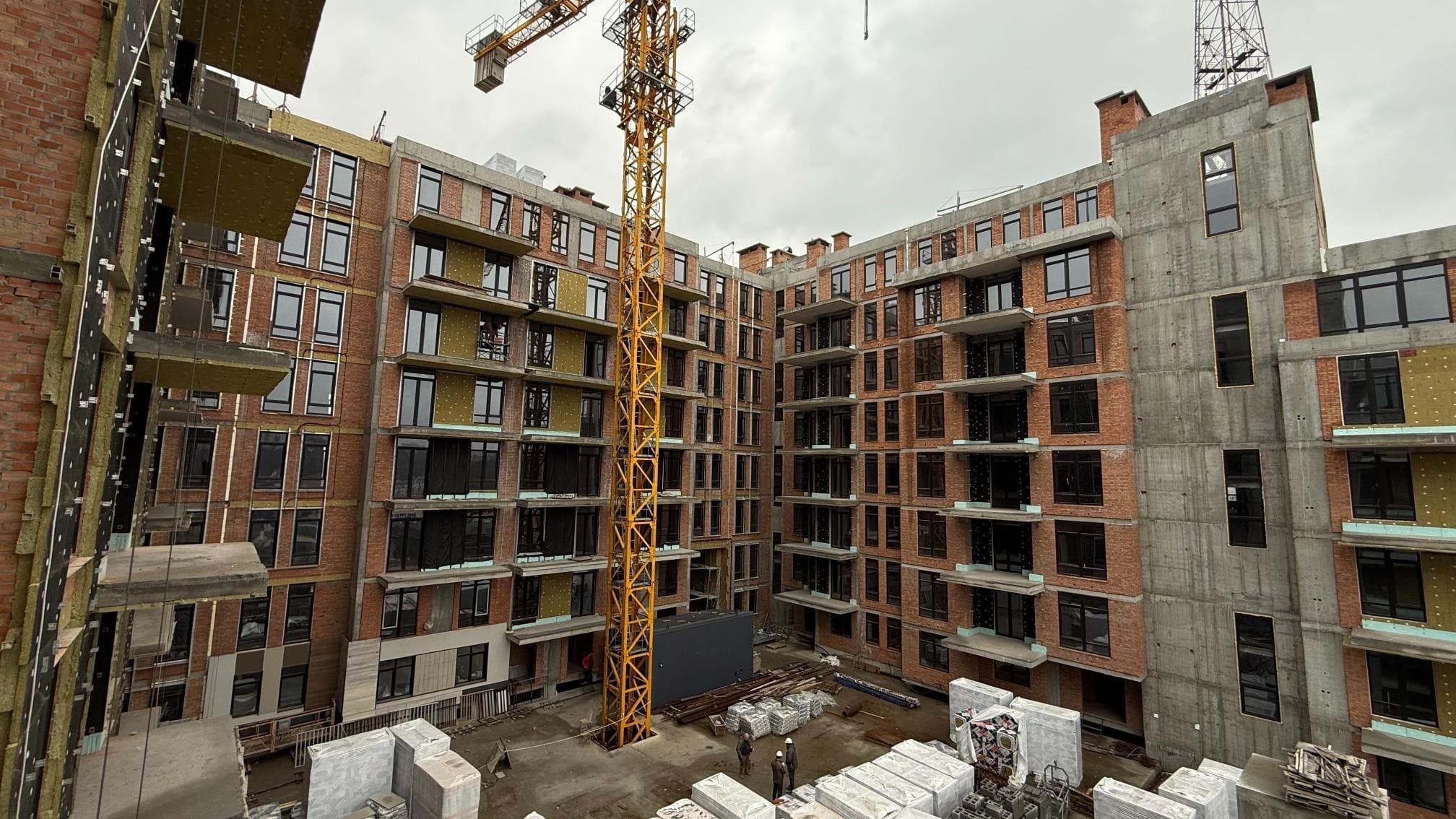

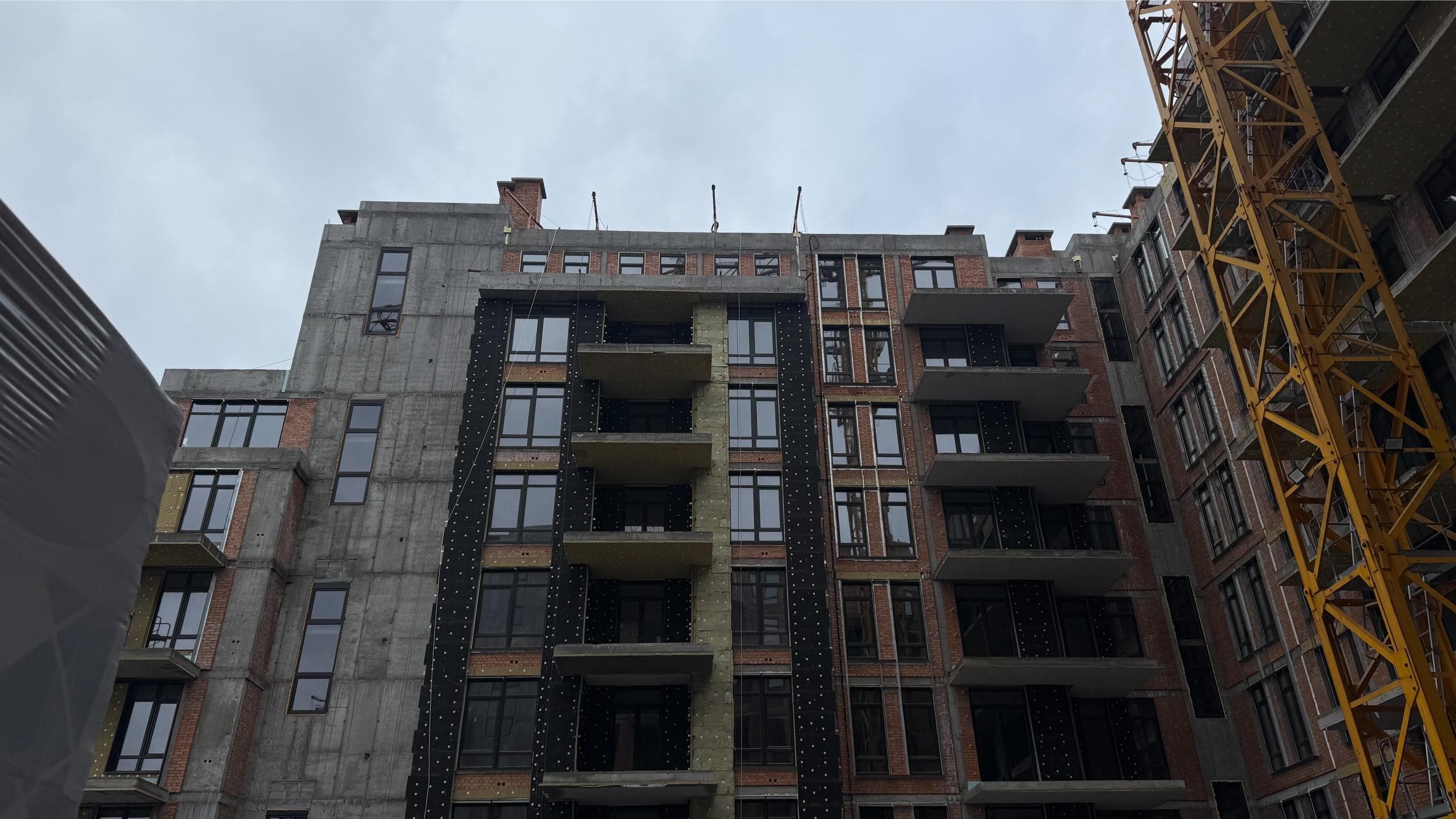

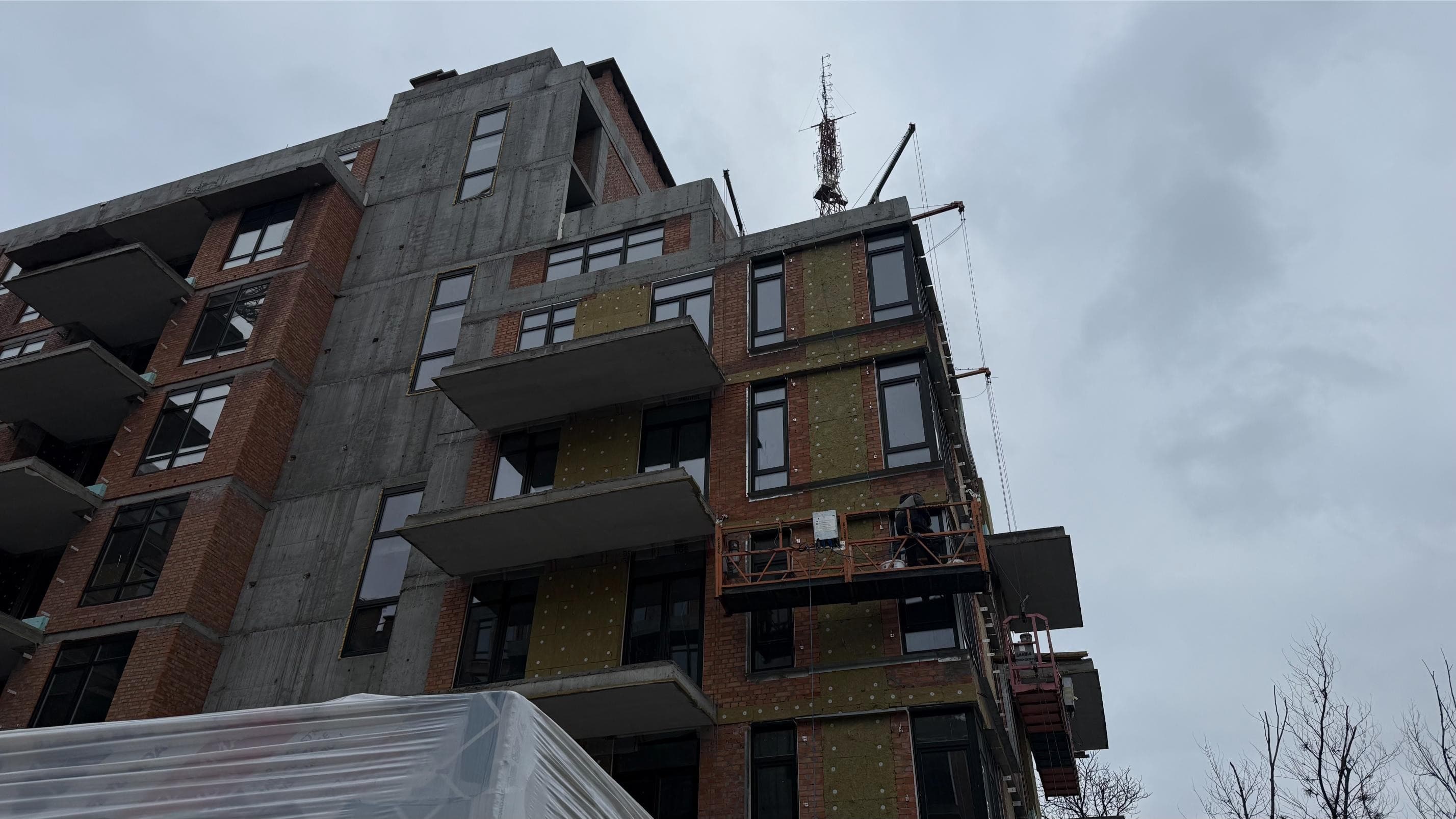

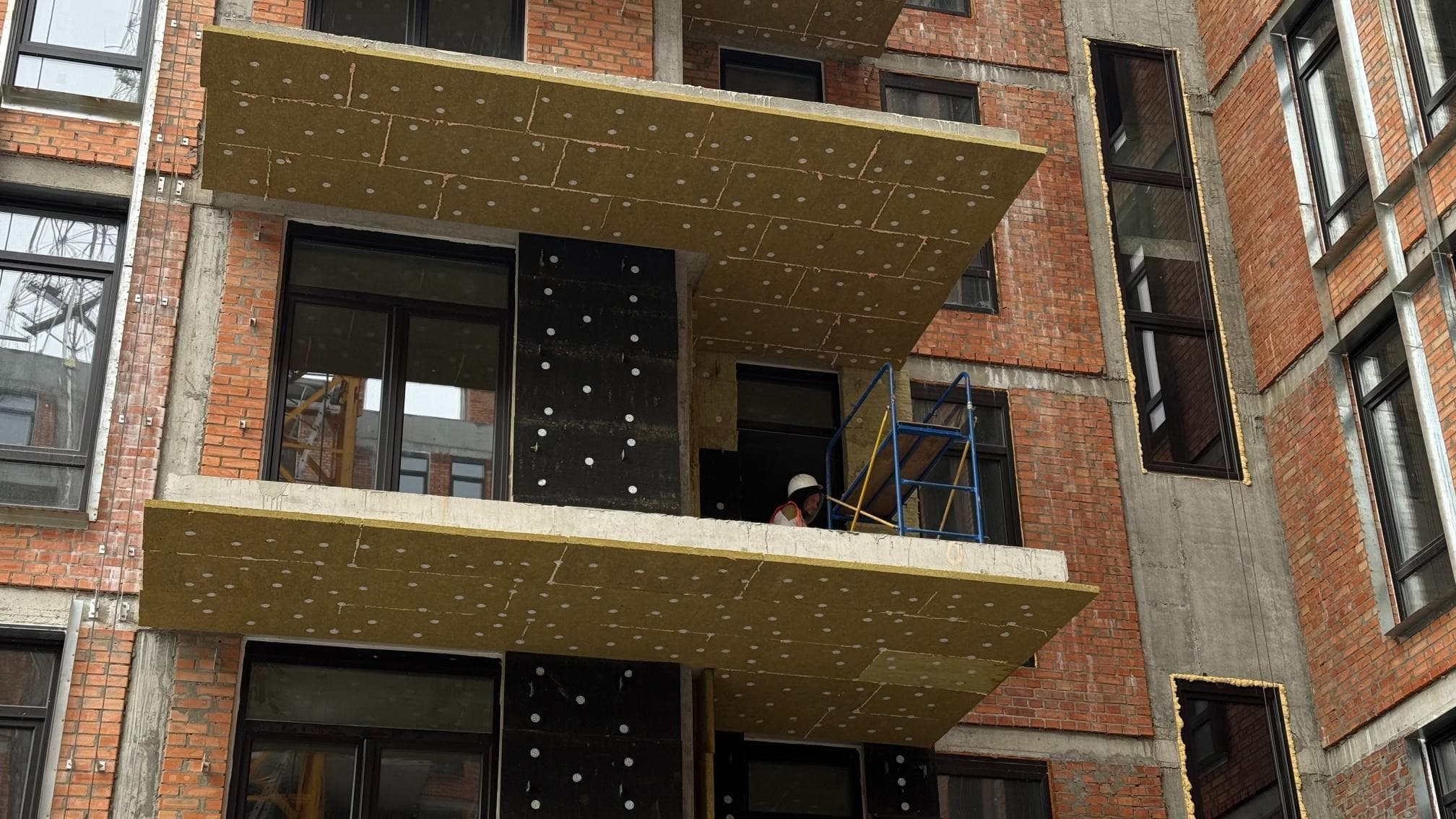

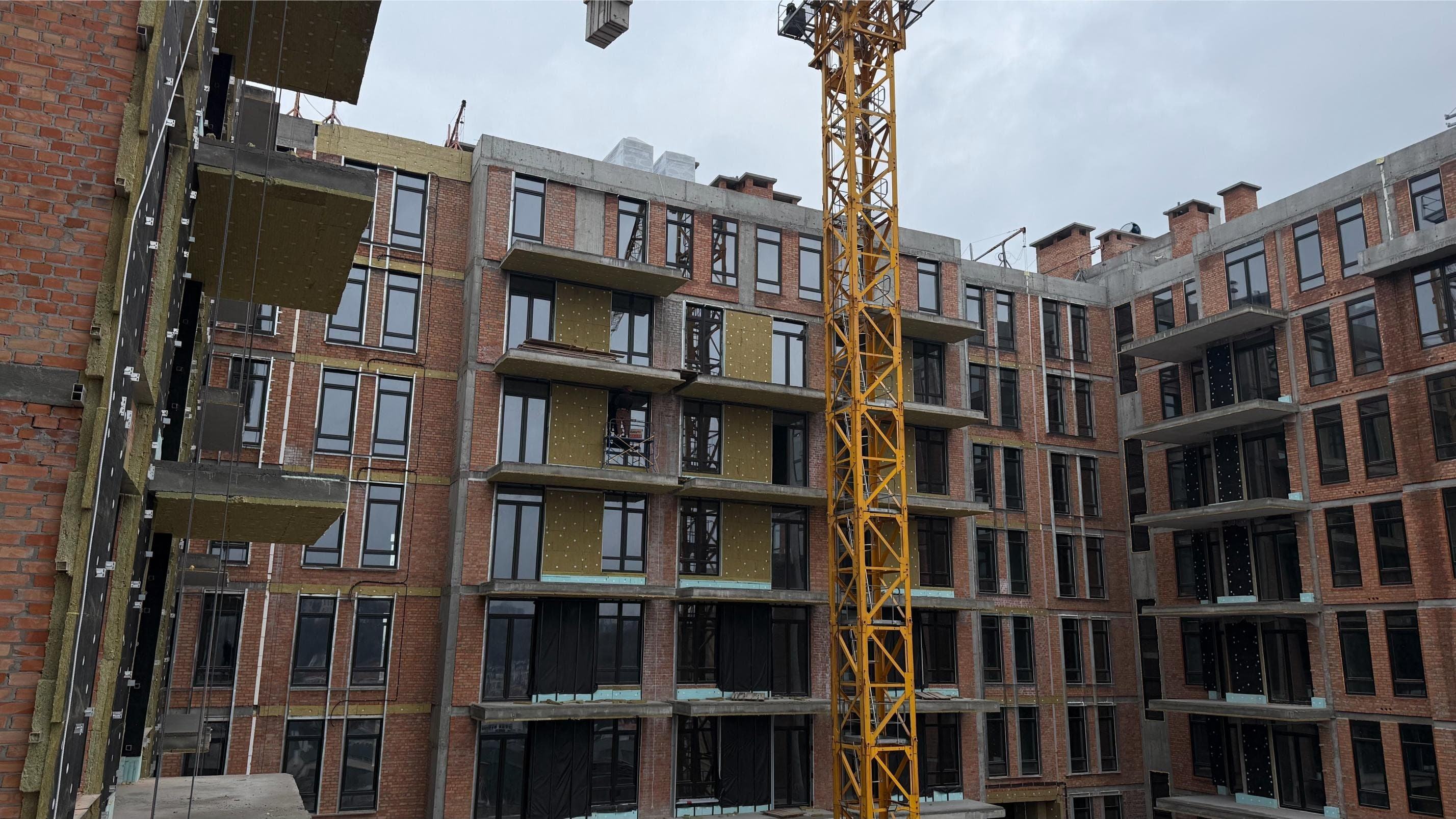

progress of construction

In November 2025, the following work was completed at the construction site:

Section 1:

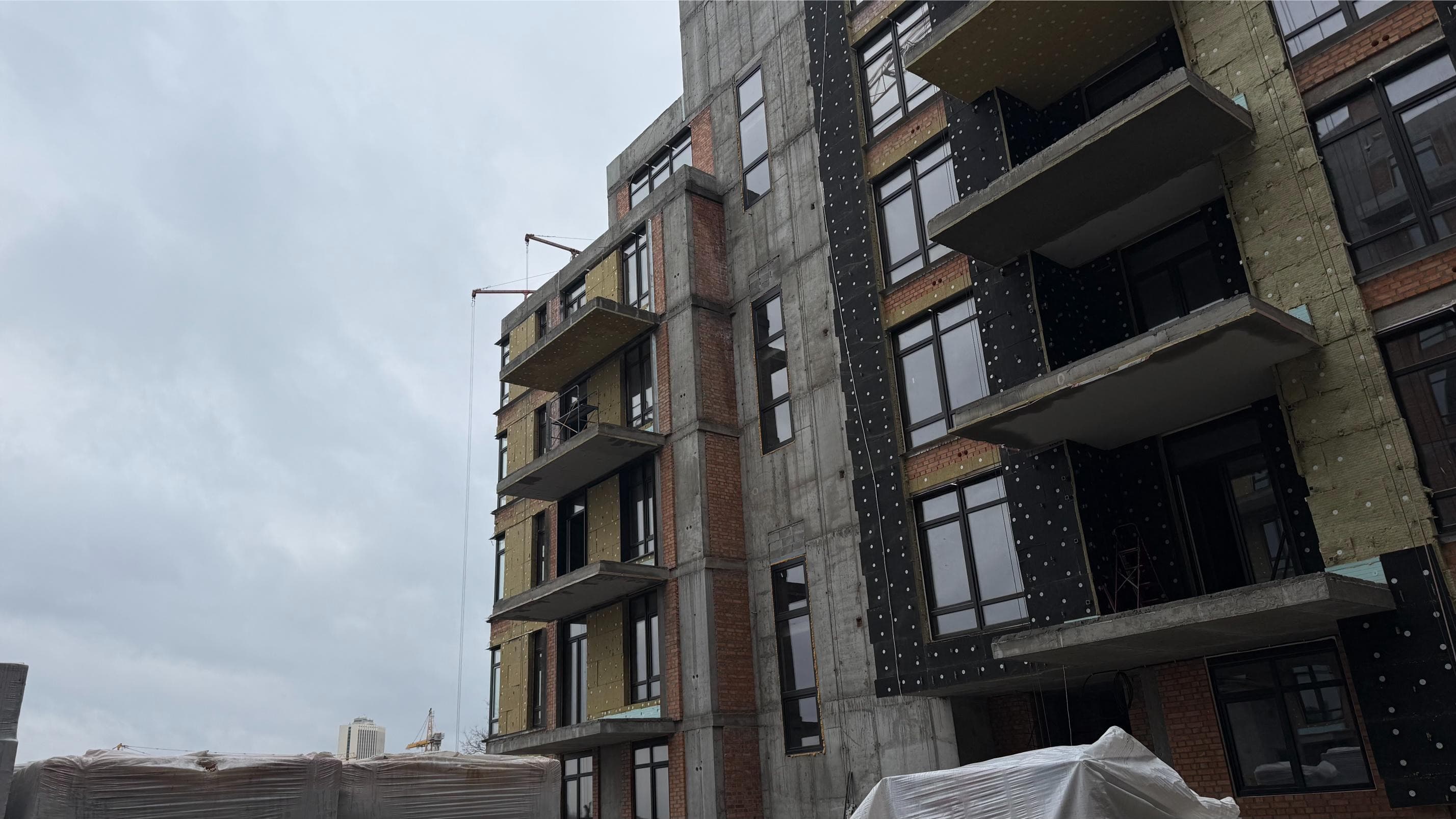

  • Facade installation – 20%
  • Roof installation – 25% at +29,450
  • Installation of ventilation equipment (valve) – 25%

Section 2:

  • Roof installation – 80% at +29,450 and at +28,000
  • Installation of engineering networks in the screed – 20%
  • Facade installation – 15%
  • Installation of K1 risers – 100%
  • Installation of screed in apartments and MZK from 4 to 8 floors – 90%

Section 3:

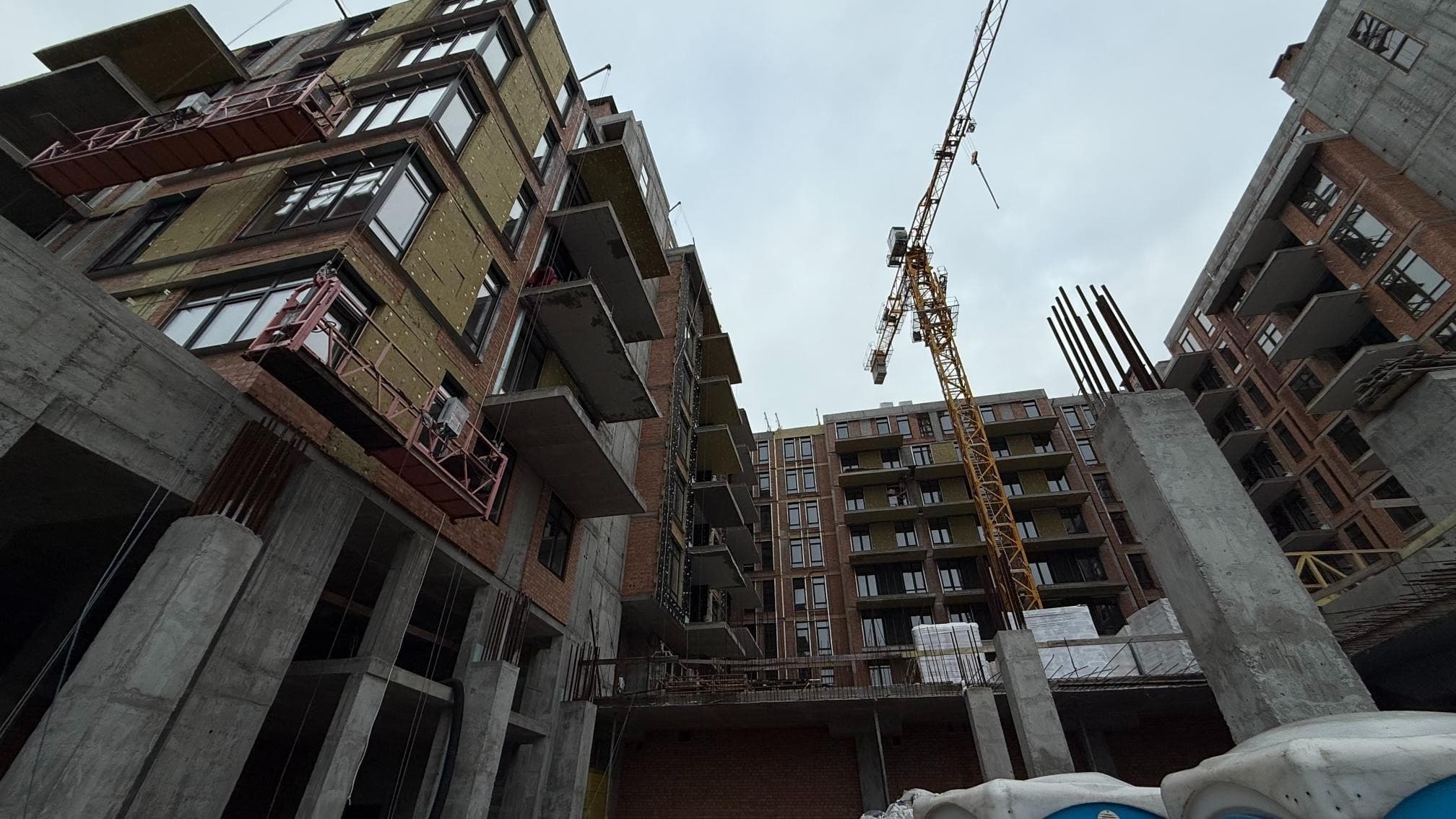

  • Installation of elevator equipment – ​​85%

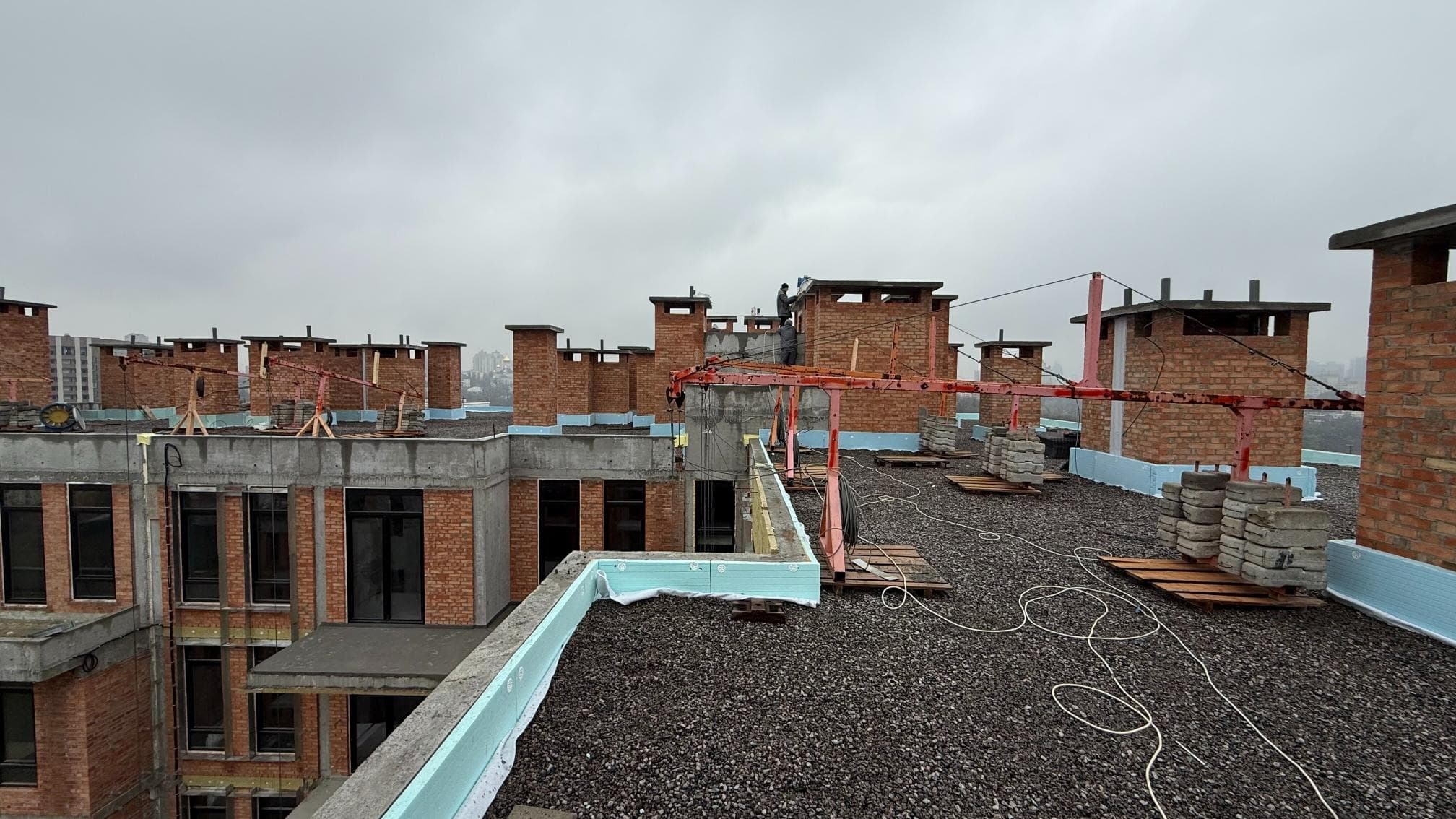

  • Installation of the roof in the area of ​​R-P/8-11 at +26,600 – 100% and at +29,450 and from +28,000 – 80%

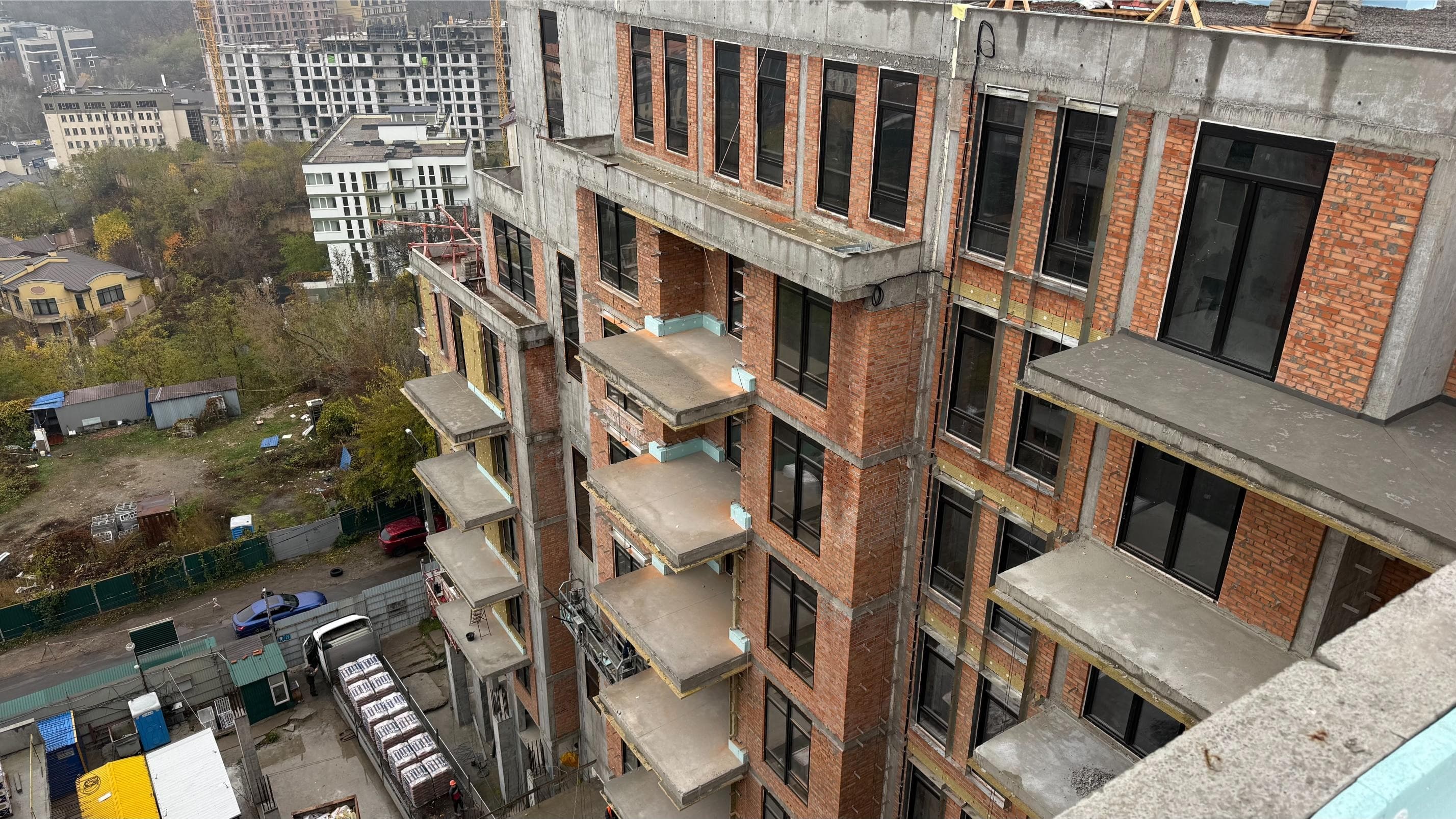

  • Facade construction – 19%
  • Installation of outdoor lighting on the facade – 20%

Section 4:

  • Facade construction – 25%
  • Roof construction – 80% on from +29,450 and on from +28,000
  • Installation of K1 risers – 100%
  • Installation of outdoor lighting on the facade – 25%
  • Installation of basket brackets for air conditioners – 80%

Section 5:

  • Facade construction – 22%
  • Roof construction – 20% from +29,450
  • Installation of K1 risers – 50%
  • Installation of outdoor lighting on the facade – 20%

Parking:

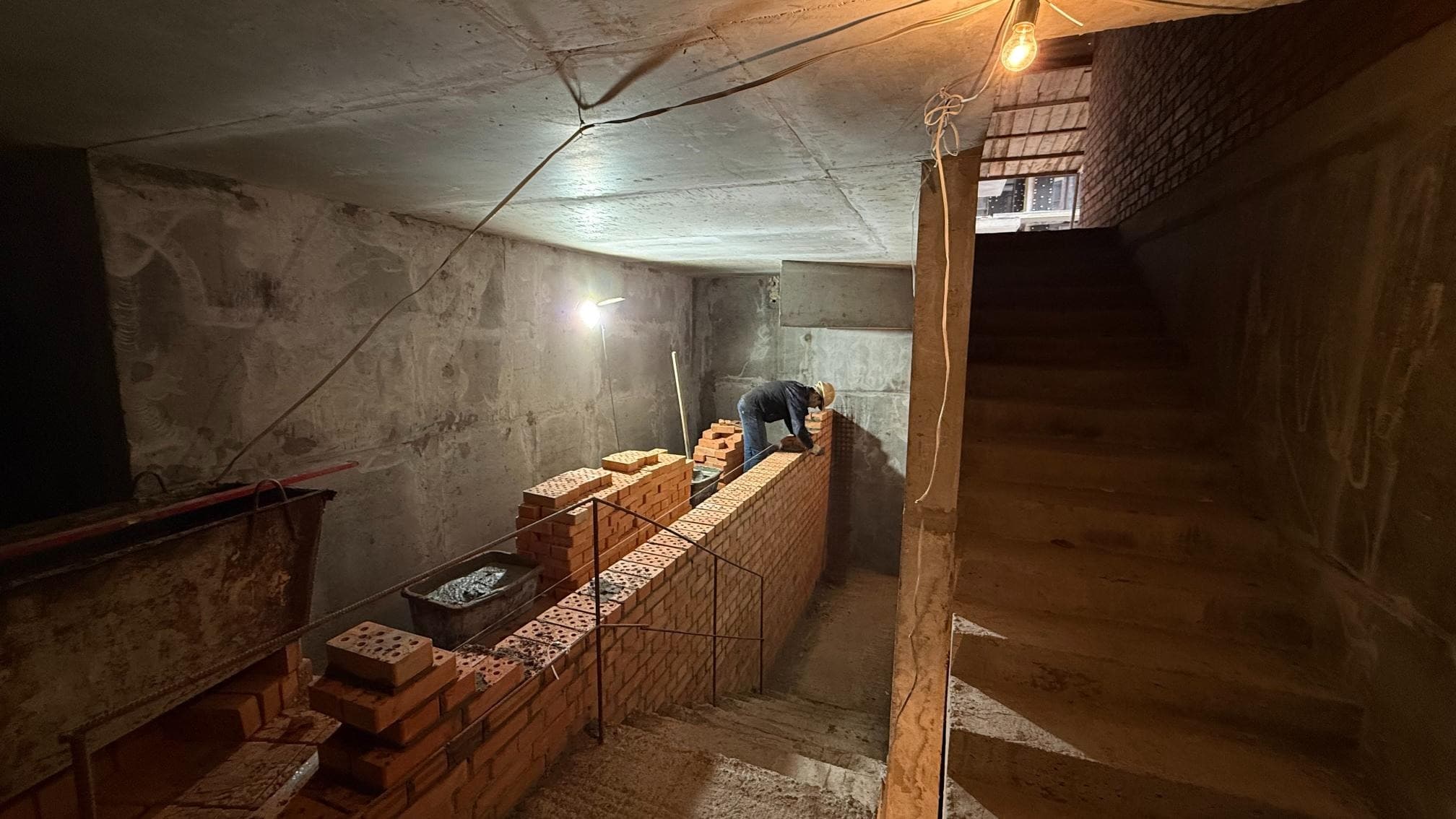

  • Masonry of walls and partitions – 17%
Stay tuned

Other news

  • Offers

    The Warmth of a Private Fireplace at OLEGIV Podil

  • Offers

    A Premium Investment in Podil

  • Offers

    Private Life at the Top of Podil

  • Offers

    Installments up to 2 years for apartments
